Agile metrics that actually tell you something useful

Blog post image

Agile metrics: summary and key takeaways

  • Agile metrics are not all equal: Velocity, cycle time, and throughput each measure different things. Picking the right ones depends on your framework and what decisions you need to make.

  • Output metrics without outcome metrics are dangerous: Tracking velocity alone creates incentives that reward speed over value delivery.

  • Your framework determines your metrics: Scrum teams need sprint burndown and velocity. Kanban teams need cycle time and WIP limits. Mixing them wastes effort.

  • The biggest metric mistake is tracking too many: Three to five well-chosen metrics beat a dashboard of twenty every time.

  • AI can automate the tracking, not the thinking: Features like Teamwork.com's AI Utilization Summary surface capacity data automatically, but teams still need to act on what the numbers say.

Every agile team I've been part of has gone through the same cycle with metrics. Someone proposes tracking velocity. Someone else adds cycle time. A third person builds a dashboard with fifteen charts. Within two months, nobody looks at any of them.

The problem is not a lack of data. It's a lack of clarity about what decisions the data should inform. In my years managing client delivery before joining Teamwork.com, I watched teams drown in numbers that told them everything about their process and nothing about whether they were delivering value.

This guide covers which agile metrics actually matter, how to choose the right ones for your framework, and how to avoid the traps that turn well-intentioned measurement into pointless overhead. And if you want to pair these metrics with ready-made agile templates, we've got those too.

What agile metrics actually measure (and what they don't)

Agile metrics are quantitative measures that track how work flows through your team's process. They cover everything from how fast tasks move (cycle time) to how much work gets done per sprint (velocity) to how many defects escape into production. If you're new to agile methodology, Teamwork.com's guide covers the fundamentals. For a broader look at project metrics beyond agile, that guide is worth a read too.

The critical distinction most articles miss: agile metrics measure your process, not your outcomes. Velocity tells you how much work your team completed. It tells you nothing about whether that work mattered to your customers or moved the business forward. That gap between output metrics and outcome metrics is where most teams go wrong. For a deeper dive into project management analytics and the broader data picture, Teamwork.com's analytics guide breaks it down further.

A balanced metrics stack pairs process metrics (velocity, cycle time, throughput) with outcome metrics (customer satisfaction, team health, defect rates). Without that pairing, you're optimizing a machine without checking whether it's pointed in the right direction.

Agile metrics vs. KPIs: the difference matters

These terms get used interchangeably, but they serve different purposes.

Criteria
Agile metrics
KPIs
What they measure
Process efficiency and team workflow
Progress toward specific business goals
Examples
Velocity, cycle time, WIP, sprint burndown
On-time delivery rate, customer satisfaction, revenue per project
Who uses them
The agile team, during standups and retros
Leadership, during strategic reviews
How often reviewed
Every sprint or continuously
Monthly or quarterly

Metrics are the raw data. KPIs are the subset you tie to business objectives. You need both, but confusing one for the other leads to tracking too much or reporting on the wrong things.

Why most teams track the wrong agile metrics

In my experience, the biggest metric failure I saw was teams tracking numbers because they were easy to measure, not because they informed real decisions. Velocity is the classic culprit. It's visible, it trends nicely on a chart, and it gives the illusion of progress. But without context, it's noise.

What we see across Teamwork.com customers is a version of the same pattern: someone sets up a dashboard during an agile rollout, picks the metrics that look most "agile," and then wonders why the numbers don't help them make better choices six months later.

Three patterns that always lead to bad metric decisions

1. Tracking output without outcomes

Velocity going up means nothing if customer satisfaction is going down. In most engagements I've seen, teams that focus only on throughput eventually burn out, ship lower-quality work, or both. The fix is pairing every output metric with at least one outcome metric. If you track velocity, also track escaped defects. If you track cycle time, also track customer satisfaction.

For example, imagine a team that increased velocity from 40 to 60 story points per sprint over three months. Leadership celebrates. But escaped defects also doubled, and post-release customer complaints tripled. The team was cutting corners to hit higher numbers. Without a quality metric alongside velocity, the damage was invisible until customers felt it.

2. Comparing teams using different estimation cultures.

Each team's velocity is unique to its estimation norms. Team A completing 50 story points and Team B completing 75 does not mean Team B is more productive. Their point values reflect different estimation cultures, different complexity standards, and different team compositions. Using velocity to rank teams against each other creates competition that undermines collaboration.

I've seen this play out in organizations where leadership publishes a velocity leaderboard. Within weeks, teams start inflating their point estimates to look better on the chart. The metric becomes meaningless, and the culture becomes toxic. Velocity is a planning tool for the team that generates it, not a performance ranking for leadership.

3. Setting metric targets instead of using metrics for learning.

The moment you tell a team "your velocity target is 60 points per sprint," you've incentivized gaming. Teams inflate estimates, declare work done before it's truly finished, or avoid difficult tasks that might reduce their numbers. Metrics work when they're treated as diagnostic tools, not report cards.

The better approach: use metrics to ask questions. "Why did cycle time increase this sprint?" leads to useful conversations. "Why didn't you hit your cycle time target?" leads to defensiveness and data manipulation.

Hard truth

If your metrics exist primarily to report upward to leadership, they're probably not helping your team improve. The best agile metrics are the ones the team uses in their own retrospectives to spot patterns and drive changes.

How to choose metrics that fit your framework

Not every metric fits every methodology. The framework your team uses should drive which metrics you prioritize. Here's a practical mapping.

Framework

Core metrics
Why these
What to skip
Scrum
Velocity, sprint burndown, commitment reliability
Sprint-based work needs iteration-level tracking
Continuous flow metrics like WIP limits add complexity without value
Kanban
Cycle time, throughput, WIP limits
Continuous flow needs real-time bottleneck detection
Velocity doesn't apply without fixed sprints
Lean
Lead time, flow efficiency, cumulative flow diagram
Waste reduction requires end-to-end visibility
Sprint-specific metrics don't fit a continuous delivery model

Scrum metrics: what to track when you work in sprints

If your team works in sprints, three metrics give you most of the signal you need. Velocity tells you how much work your team typically completes, so you can plan future sprints realistically. Sprint burndown shows whether you're on pace within the current sprint. Commitment reliability (planned vs. completed work) reveals whether your estimation is improving over time.

The key with Scrum metrics is consistency over time. A single sprint's velocity is meaningless. Six sprints of velocity data becomes a reliable forecasting tool. For a deeper look at agile project planning with sprints, see Teamwork.com's step-by-step guide.

Kanban metrics: what to track when flow is the goal

Kanban teams don't work in fixed iterations, so sprint-based metrics don't apply. Instead, focus on cycle time (how long each item takes from start to finish), throughput (how many items you complete per week or month), and WIP limits (how many items are in progress simultaneously).

The relationship between WIP and cycle time is direct: the more items in progress, the longer each one takes. Limiting WIP is one of the simplest changes a team can make, and it consistently produces faster cycle times across the teams I've seen adopt it.

Lean metrics: what to track when waste is the enemy

Lean teams care most about lead time (total duration from request to delivery, including wait time) and flow efficiency (active work time divided by total elapsed time). A flow efficiency of 15% means your items spend 85% of their lifecycle waiting, which is shockingly common in professional services. Understanding the difference between agile and waterfall approaches helps explain why Lean teams measure flow differently than traditional sequential teams.

See how your team is really performing

Track the agile metrics that matter in one place, with real-time dashboards that connect projects, people, and profitability.

Start free

The agile metrics worth tracking (and how to read them)

Now let's get into the specific metrics. For each one, I'll cover what it measures, how to calculate it, and the anti-patterns that signal something is off. If you want ready-made project structures to pair with these metrics, the Teamwork.com agile software development template is a good starting point.

Velocity

Velocity is the total story points (or equivalent units) your team completes in a sprint. Calculate it by summing the points of all fully completed user stories at sprint end. Partially completed work doesn't count. For more on how sprint cycles work in practice, including how product leads use them to meet deadlines, that guide has practical examples.

Velocity=(Story Points of completed stories per sprint)\text{Velocity} = \sum(\text{Story Points of completed stories per sprint})

What good looks like: consistent velocity across sprints, with a stable average that varies by no more than 10-15%. A team with velocities of 42, 45, 39, 43 over four sprints has a healthy, predictable pace.

What bad looks like: wild swings (20, 55, 15, 60) signal inconsistent estimation, scope changes mid-sprint, or team members being pulled to other work. A consistently rising velocity also warrants scrutiny. It might mean the team is improving, or it might mean story point estimates are inflating.

Cycle time and lead time

These two metrics are frequently confused. Here's the distinction.

Criteria
Cycle time
Lead time
Starts when
Work actively begins on an item
A request enters the backlog
Ends when
The item is marked done
The item is delivered to the customer
Includes wait time
Best for
Measuring team execution speed
Measuring end-to-end responsiveness

Cycle Time=Completion DateStart Date of Active Work\text{Cycle Time} = \text{Completion Date} - \text{Start Date of Active Work}

Lead Time=Completion DateRequest Date\text{Lead Time} = \text{Completion Date} - \text{Request Date}

For example, if a user story enters the backlog on Monday, sits for five days, gets picked up the following Monday, and finishes by Wednesday, the cycle time is 3 days and the lead time is 10 days. That seven-day gap is pure wait time, and it's often where the biggest improvements hide.

In my experience, teams that focus on cycle time alone miss the upstream bottlenecks. A team with a two-day cycle time looks fast, but if items sit in the backlog for three weeks before anyone touches them, the customer's experience is still slow.

Sprint burndown

A sprint burndown chart plots remaining work (y-axis) against time (x-axis) across a sprint. The ideal line slopes steadily downward from total committed points to zero by sprint end.

Anti-patterns to watch for:

  • Flat line until the end, then a cliff: Work is being batched and marked complete at the last minute, not genuinely progressing daily.

  • Burndown goes up: Scope is being added mid-sprint. This is a planning discipline issue, not a performance issue.

  • Steady burndown that never reaches zero: The team is consistently overcommitting. Reduce sprint scope until the team reliably finishes what it starts.

For release-level progress tracking across multiple sprints, release burndown and burnup charts provide the bigger picture.

Cumulative flow diagram

A cumulative flow diagram (CFD) shows how many work items are in each state (backlog, in progress, testing, done) over time. The bands of color should flow smoothly from left to right.

Read it like this: if the "in progress" band is widening while the "done" band stays flat, work is piling up. That's a bottleneck. If the "testing" band balloons, your QA process can't keep up with development output. The goal is consistent band widths, meaning work moves through your pipeline at a steady rate.

The CFD is particularly useful for teams transitioning between frameworks. If you're moving from Scrum to Kanban, or running a hybrid approach, the CFD gives you a framework-agnostic view of how work actually flows. It doesn't care about sprints or story points. It just shows you where items pile up and where they flow.

Throughput and WIP limits

Throughput counts completed items per time period. Unlike velocity, it doesn't care about story points or estimation. A team that completes 12 user stories per week has a throughput of 12, regardless of their size.

WIP limits cap how many items can be in progress simultaneously. The relationship is direct: lower WIP usually means higher throughput, because team members focus on finishing work instead of starting new items.

Pro tip

Start with a WIP limit of one active item per team member, plus one buffer slot. Adjust after two weeks based on whether the team feels focused or starved for work. Most teams set WIP too high at first.

Quality metrics that agile teams forget to track

Speed metrics dominate most agile dashboards. Quality metrics rarely show up, which is a blind spot.

  • Escaped defect rate measures how many bugs make it to production after a release. Calculate it as defects found post-release divided by total defects found (pre-release + post-release). A lower rate means your testing catches more issues before customers see them.

  • Defect density tracks defects per unit of code, usually per thousand lines. It's a useful long-term trend indicator: if defect density increases after a new feature push, your quality process has a gap.

  • Test coverage measures the percentage of code executed during automated testing. The industry standard is around 80%. Going significantly higher usually produces diminishing returns, and going below 60% means large portions of your codebase are untested.

Data point

According to Teamwork.com's "How To Prove Value Beyond Price" report, the high-value position for project managers is shifting from "keeping things on track" (status updates, chasing deadlines) to "making things predictable" (spotting early warning signs, tightening feedback loops, controlling speed and quality). Quality metrics are how you make that shift concrete.

The metrics nobody puts on a dashboard (but should)

The metrics above measure your process. These next two measure whether your process is actually working for the people involved.

  • Customer satisfaction (CSAT or NPS) is the ultimate outcome metric. Are you delivering something people value? Regular post-delivery surveys or Net Promoter Score tracking give you direct signal on whether your agile process is producing the right results. A team with high velocity and low CSAT is shipping the wrong things, fast.

  • Team happiness is the leading indicator most teams ignore. Stressed, burned-out teams ship more defects, miss more deadlines, and eventually lose their best people. Measure it through pulse surveys, retrospective feedback, or even a simple 1-10 score at each agile sprint review. The pattern I keep seeing is that team happiness drops before delivery metrics do. It's an early warning system, if you're willing to look at it.

Self-audit checklist

  • Is your metrics stack balanced?

  • You track at least one process metric (velocity, cycle time, or throughput).

  • You track at least one quality metric (escaped defects, defect density, or test coverage).

  • You track at least one outcome metric (CSAT, NPS, or business value delivered).

  • You track at least one people metric (team happiness, burnout signals, or retention).

  • Your total active metrics count is between three and five.

If you checked fewer than three boxes, you have blind spots. If you checked all five but your total metrics count exceeds 10, you're probably drowning in data.

Best practices for using agile metrics without making your team hate you

Metrics can drive continuous improvement or create a culture of surveillance. The difference comes down to how you implement them.

  • Pick three to five metrics, not fifteen. Every additional metric beyond the core set dilutes focus. Choose metrics that map directly to decisions your team needs to make this quarter. When a metric stops informing decisions, retire it. A useful test: for each metric on your dashboard, can you name the specific decision it helps you make? If the answer is "it's nice to know," that metric is noise. If the answer is "it tells me whether we need to rebalance workload," that metric earns its place.

  • Review metrics in retrospectives, not status meetings. Metrics belong in the conversation about how to improve, not in the conversation about who's behind. When Invanity, a digital agency, moved to weekly metric reviews in Teamwork.com, they cut project planning time by 50% and reduced weekly workload management by 80%. The time they saved on manual tracking went directly into the retrospective conversations that actually improved their process.

  • Use metrics for learning, never for blame. A velocity drop after a team member goes on leave is expected, not a failure. A cycle time increase during a complex technical migration is predictable. Context matters more than numbers.

  • Evolve your metrics as the team matures. A team just adopting Scrum should start with velocity and sprint burndown. Six months later, they might add cycle time and escaped defects. A year in, customer satisfaction and team happiness complete the picture. Don't try to track everything from day one. If you're setting up agile for the first time, the Teamwork.com Agile Project Management hub has some helpful resources to get started.

One of the simplest things we've done at Teamwork.com to shift the culture around metrics is changing the language. Instead of "why did velocity drop?" (which sounds accusatory), we ask "what changed this sprint that affected our throughput?" The second question invites analysis. The first invites defensiveness. If your metrics discussions consistently produce defensiveness instead of curiosity, the problem is the culture around the metrics, not the metrics themselves.

How Teamwork.com helps you track what matters

The agile metrics covered in this guide are only useful if you can access them without spending your week assembling data from five different tools. What I've seen across Teamwork.com customers is that the shift from manual metric tracking to real-time visibility changes how teams use data entirely.

Before joining Teamwork.com, I spent hours each week pulling data from separate time tracking, project management, and reporting tools into spreadsheets just to answer basic questions about team capacity and project health. That's time that should go toward actual delivery. One of the reasons we built our reporting and resource management tools the way we did is to eliminate that manual assembly work and give teams the answers they need without the spreadsheet gymnastics.

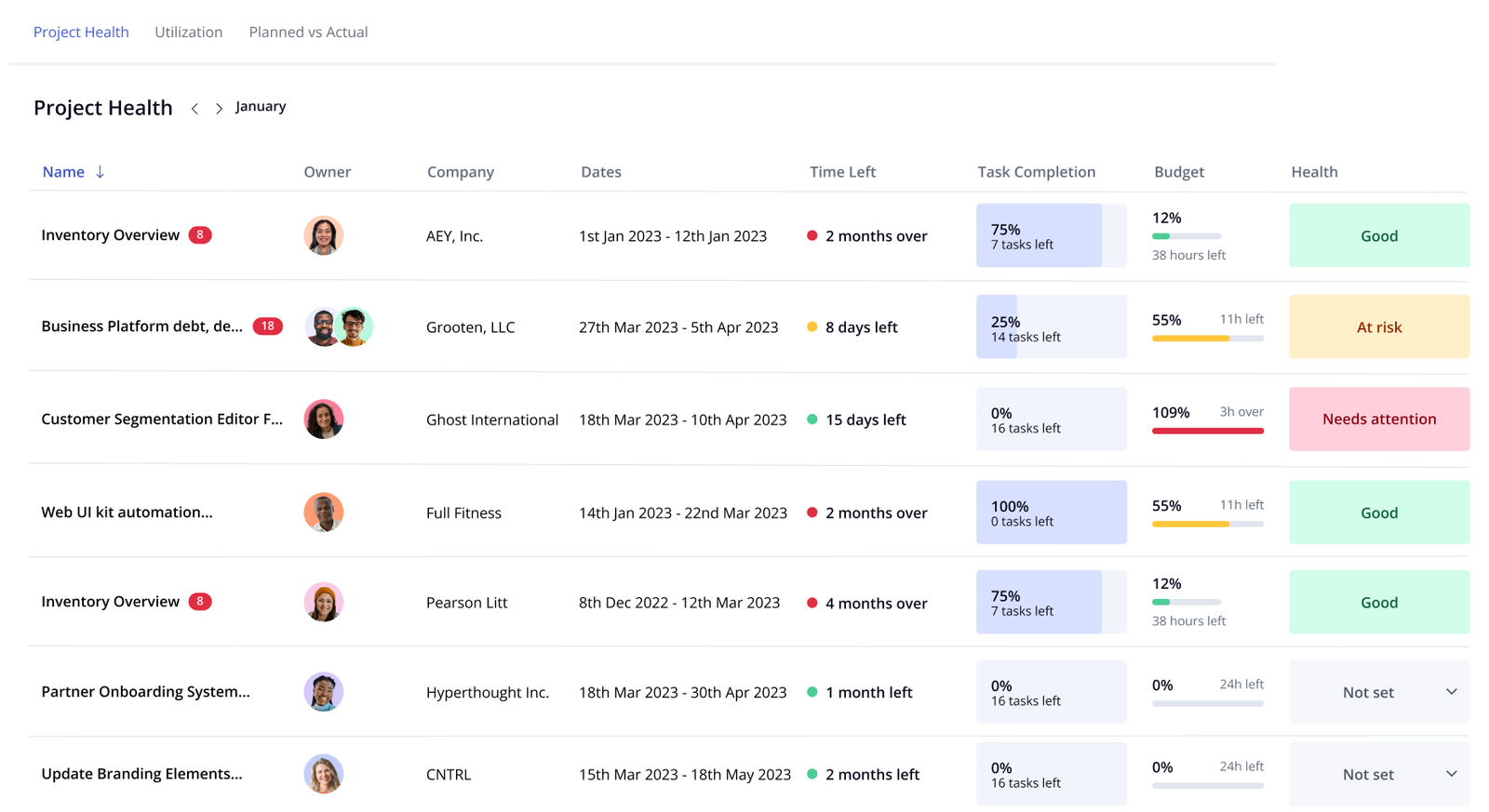

See every project's status at a glance: the Project Health Report shows tasks completed, budget remaining, and timeline progress in a single view, so you spot risks before they become problems.

Blog post image

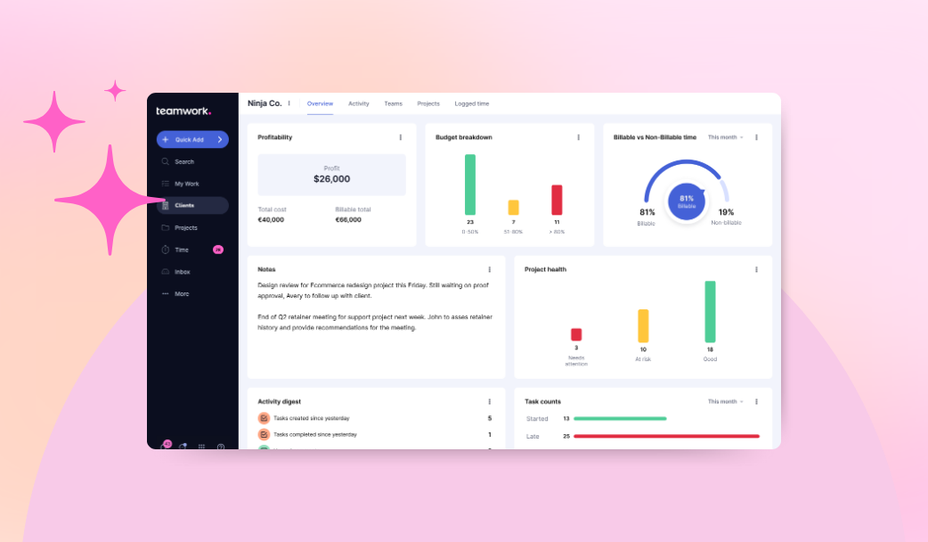

Know who's overbooked and who has capacity: the Workload Planner gives you real-time visibility into team allocation across all active projects, so you can rebalance before burnout sets in.

Blog post image

Track billable vs. non-billable time with actual targets: utilization reporting lets you set utilization goals per person and monitor progress in real time, so your capacity metrics are grounded in reality, not guesswork.

Blog post image

Let AI surface the patterns you'd miss manually: the AI Utilization Summary delivers instant snapshots of who's overbooked and underutilized, matching capacity data to roles and skills so you spot imbalances before they cascade.

Blog post image

Stop losing hours to manual rescheduling: the AI Smart Scheduler automatically adjusts schedules when priorities shift or someone takes unexpected time off, resolving the resource conflicts that typically consume two to three hours weekly.

Blog post image

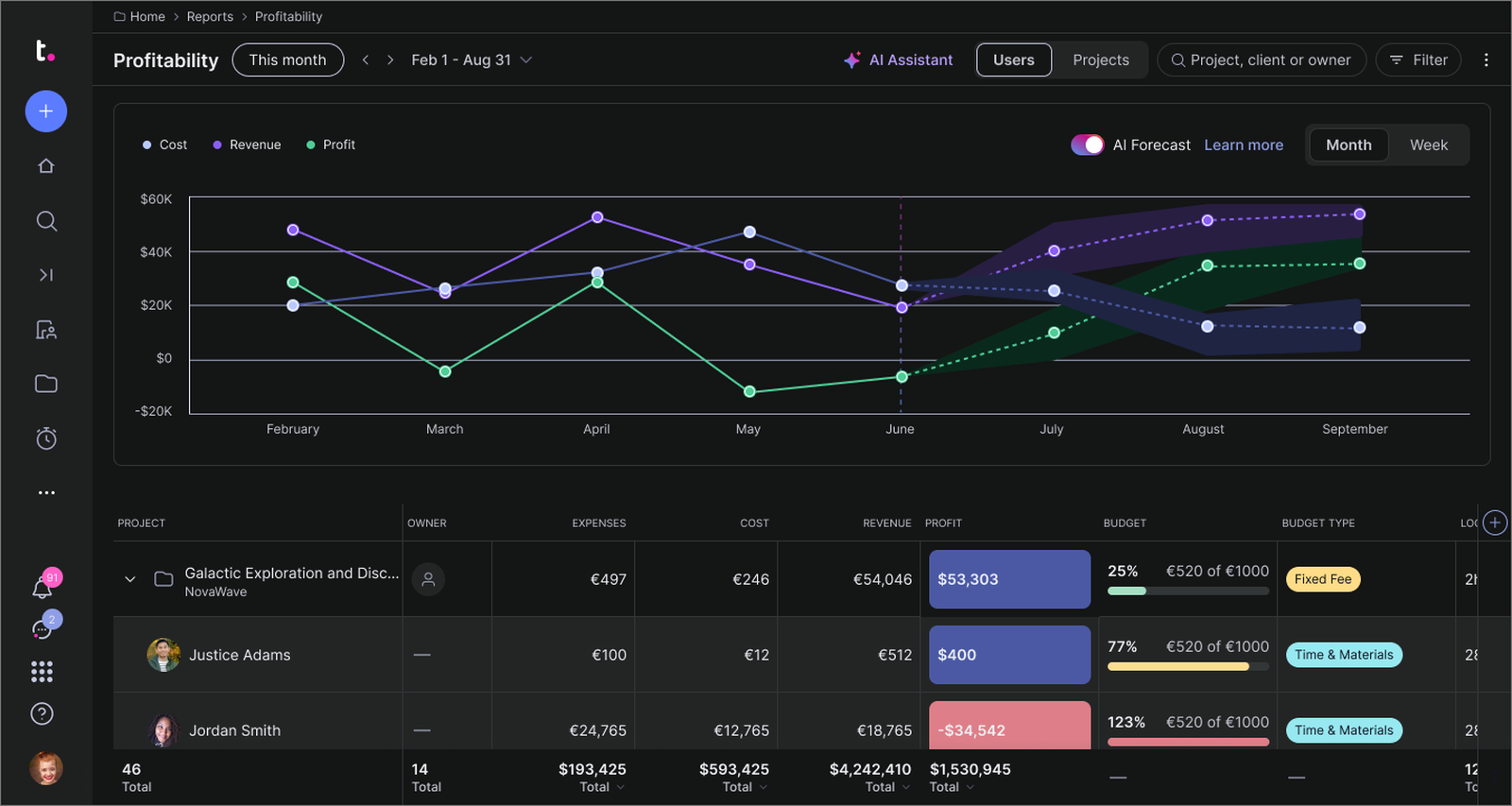

Connect delivery metrics to profitability: profitability reporting tracks revenue, costs, and margin by project in real time, so you can see whether fast delivery is actually translating into profitable delivery. Because at the end of the day, a team with great velocity and terrible margins isn't winning. Connecting speed metrics to financial outcomes is how you close the loop between agile performance and business results.

Blog post image

See how Teamwork.com connects your projects, people, and profits with real-time reporting and AI-powered insights.
Start free

FAQ

What are agile metrics?

Agile metrics are quantitative measures that track the progress, quality, and effectiveness of agile teams and projects. Common examples include velocity (work completed per sprint), cycle time (duration from start to finish of a task), and sprint burndown charts. They help teams identify bottlenecks, forecast delivery, and drive continuous improvement.

What is the difference between agile metrics and KPIs?

Agile metrics are broader data points that measure process efficiency, such as cycle time or throughput. KPIs are a focused subset tied to specific business goals, such as on-time delivery rate or customer satisfaction score. Every KPI is a metric, but not every metric is a KPI.

Which agile metrics should a Scrum team track?

Scrum teams should prioritize velocity (story points completed per sprint), sprint burndown (remaining work plotted against time), and commitment reliability (planned vs. completed work). These three metrics cover forecasting, real-time progress, and estimation accuracy.

What is the difference between lead time and cycle time?

Lead time measures the total duration from when a request enters the backlog to when it's delivered. Cycle time measures only the active work period, from when development starts to when the item is completed. Lead time always includes cycle time plus any waiting or queue time.

How many agile metrics should a team track?

Three to five well-chosen metrics provide the best balance between visibility and focus. Cover at least one process metric, one quality metric, and one outcome or satisfaction metric. Adding more without a clear decision each metric informs creates dashboard clutter that teams stop looking at.

How do agile metrics differ by framework?

Scrum teams track sprint-based metrics like velocity and burndown because work happens in fixed iterations. Kanban teams track flow metrics like cycle time, throughput, and WIP because work is continuous. Lean teams focus on lead time and flow efficiency to minimize waste. Choosing metrics that match your framework ensures you're measuring what you can actually influence.
