Handle scope creep: summary and key takeaways
The real cost isn't time: Scope creep silently converts billable hours into unrecoverable write-offs, compressing margins project by project.
Prevention is a financial discipline: The teams that avoid scope creep treat scope definition like a contract, not a suggestion.
Change control is non-negotiable: A documented process for evaluating every "quick add" protects both the relationship and the budget.
Visibility kills creep early: Real-time budget and time tracking surfaces overruns before they snowball into margin problems you can't fix.
Scope creep doesn't announce itself. It shows up as "a small tweak" here and "one more round of revisions" there. By the time you notice, the project that was supposed to be profitable is bleeding money.
I've spent years managing projects inside professional services firms and now at Teamwork.com. The pattern is always the same: small, untracked additions that seem harmless but collectively eat the entire margin.
This guide breaks down how to detect scope creep early, prevent it with financial discipline, and manage it when it happens. You'll walk away with a five-step framework, a self-audit checklist, and a clear picture of the tools that make scope control practical. The goal is straightforward: keep your projects profitable from kickoff to close.
What is scope creep?
I find the most frustrating thing about scope creep is that it rarely looks like a crisis when it starts. It begins as a reasonable request, and before anyone flags it, the project's financial foundation has shifted underneath you.
Scope creep is the uncontrolled expansion of a project's requirements, deliverables, or goals beyond the original agreement. It happens without corresponding adjustments to time, budget, or resources. According to PMI's Pulse of the Profession, 52% of projects experience scope creep. For a deeper look at what causes it and how it plays out in agency project management, we have a full breakdown of scope creep.
Why scope creep is a profitability problem, not just a planning one
Before I joined Teamwork.com, I managed client accounts at a mid-size agency. The projects that went sideways financially almost never failed because of bad estimates. They failed because scope expanded in small, undocumented increments that nobody tracked until the damage was done.
The compounding cost of "just one more thing"
Every unmanaged scope addition is unbilled work. A 30-minute "quick favor" for a client doesn't stay 30 minutes. It triggers rework in adjacent deliverables, extends review cycles, and pushes other tasks back. Across a portfolio of 20 or 30 active projects, those small additions compound into serious margin erosion.
Here's the math that most teams don't run. If you have 10 active projects and each absorbs just 5% more unbilled work than planned, you've given away half a project's worth of revenue for free. That's not a rounding error. That's a line item on your P&L.
For example, say your average project generates $50,000 in revenue with a 30% target margin. A 5% scope overrun on each of 10 projects means $25,000 in unbilled labor. That's your entire margin on one project, gone.
Team burnout and utilization drain
Scope creep doesn't just hit the budget. It hits people. When unplanned work keeps landing on the same team members, their billable utilization drops while their actual hours climb. They're working harder but generating less recoverable revenue.
A pattern we see across Teamwork.com customers is teams reporting 80%+ utilization on paper. But the real productive output is closer to 60%, because the gap is filled with untracked scope additions. That 20-point gap is where your margin disappears.
Client relationship damage
The irony of scope creep is that teams accept extra work to keep clients happy. But the end result is the opposite. Projects deliver late, invoices come in over budget, and the client conversation shifts from "great work" to "why did this cost so much?"
The relationship erodes because nobody had the discipline to say, "Yes, we can do that, but here's what it changes." Good stakeholder management can prevent this cycle before it starts.
The hidden cost most teams miss: opportunity cost
There's a layer of damage beyond the direct financial hit. Every hour your team spends on unplanned scope additions is an hour they can't spend on other billable work. On a fully loaded team, scope creep doesn't just compress the margin on one project. It blocks the team from starting the next project on time.
I've watched this cascade effect play out repeatedly in my prior career. One scope-crept project delays the kickoff of the next two, which means your pipeline backs up. Revenue recognition shifts to the right. And your quarterly forecast falls apart because of work you did for free three months ago.
How to spot scope creep before it becomes a crisis
The teams that catch scope creep early have one thing in common: they're watching numbers, not just project plans. The warning signs are always in the data weeks before anyone raises a flag in a status meeting.
Budget burn rate accelerating without new deliverables
If your project is 40% through the timeline but 60% through the budget, something is wrong. This mismatch is the single most reliable early indicator of scope creep. You're spending faster than planned, but the deliverable list hasn't grown. That means untracked work is eating the difference.
The fix is simple in theory: set budget thresholds that trigger alerts before you hit the red zone. When the system notifies you at 75% budget consumed, you still have room to course-correct. At 100%, it's too late.
Here's a quick benchmark table to calibrate your scope creep alarm:
Timeline progress
Tasks appearing that nobody remembers approving
Check your task list against the original scope document. If you find tasks that don't trace back to a signed-off deliverable, that's scope creep. It doesn't matter if someone added them with good intentions. Unapproved work is unapproved cost.
I recommend a simple audit: export your task list, sort by creation date, and flag anything added after the scope was locked. Then trace each flagged task back to an approved change request. No approval trail? That's your scope creep.
Timeline slipping while scope "hasn't changed"
This is the most common smoke signal. The team insists the scope is the same as day one, but the deadline keeps moving. In my experience, the scope has changed. It just hasn't been documented. Small verbal agreements, informal Slack requests, and "while you're at it" emails add up into real work.
A weekly comparison of planned versus actual task counts will surface this drift. Do it before it becomes a full-blown schedule crisis.
Team working overtime but project isn't moving faster
When people are putting in extra hours but the milestone chart isn't advancing, the extra effort is going somewhere. Usually it's being absorbed by unplanned scope additions that don't appear on any Gantt chart or task board.
This is where utilization data becomes critical. If individual team members show high logged hours but low task completion rates, the gap is almost always untracked scope work. I've seen this pattern play out repeatedly: a developer logs 45 hours in a week, but only 30 hours map to tracked tasks. Those missing 15 hours? They went to client requests that never made it into the project plan.
The fix is to make untracked work visible. Require every team member to log all hours against specific tasks. When someone spends time on work that doesn't have a task, they create one and tag it as "unplanned." Over a two-week sprint, the volume of unplanned tasks tells you exactly how much scope creep you're absorbing.
The scope creep early warning dashboard
If you want a single view that catches all four warning signs, build a weekly dashboard that tracks these five metrics side by side:
Metric
This isn't about creating more reports. It's about looking at the right five numbers every week so you catch problems before they compound.
5 steps to handle scope creep and protect your margins
The following framework is not complicated, but it requires consistency. The teams that follow it reliably protect their margins. The ones that skip steps are the ones posting write-offs at quarter end.
Step 1: Lock scope in writing before work begins
This sounds obvious, and yet I see it skipped more often than any other step. A verbal agreement on "what we're building" is not scope definition. You need a written scope document that lists every deliverable, every exclusion, every assumption, and every boundary.
The document should answer three questions. What are we delivering? What are we explicitly not delivering? What happens when someone asks for something outside this list?
If your team doesn't have a scope template, start with a simple table:
Get this signed before a single billable hour is logged. We cover the full process in our project scope management guide. If you need a head start, our project scope template can save you from building this from scratch.
For example, one approach that works well for fixed-fee engagements is to include a "buffer clause" in the scope document. This clause allocates a specific number of hours (say, 10% of the total estimate) for minor scope adjustments. Anything beyond that buffer triggers the formal change process. This gives clients some flexibility while protecting your margin.
Step 2: Build a change control process that people actually use
A change control process is only effective if it's lightweight enough that people don't bypass it. I've seen teams create 12-step approval workflows that nobody follows because they're too slow. The change gets made informally, and the process exists only on paper.
What I recommend, and what we see work across Teamwork.com customers, is a five-step process:
Step
The key is that Step 2 always includes a cost estimate. When stakeholders see that their "small change" adds 20 hours and $3,000 to the project, many of those requests vanish on their own.
For a real-world benchmark: McKinsey research on large capital projects shows that budget overruns of 80% are common when change control is weak. Even on smaller client projects, uncontrolled changes routinely add 20–30% to the original scope.
Step 3: Make time and budget data visible in real time
End-of-month reporting is how firms realize they've been overservicing for four weeks straight. Real-time visibility into hours logged, budget consumed, and margin status is the single most effective scope creep defense I've found.

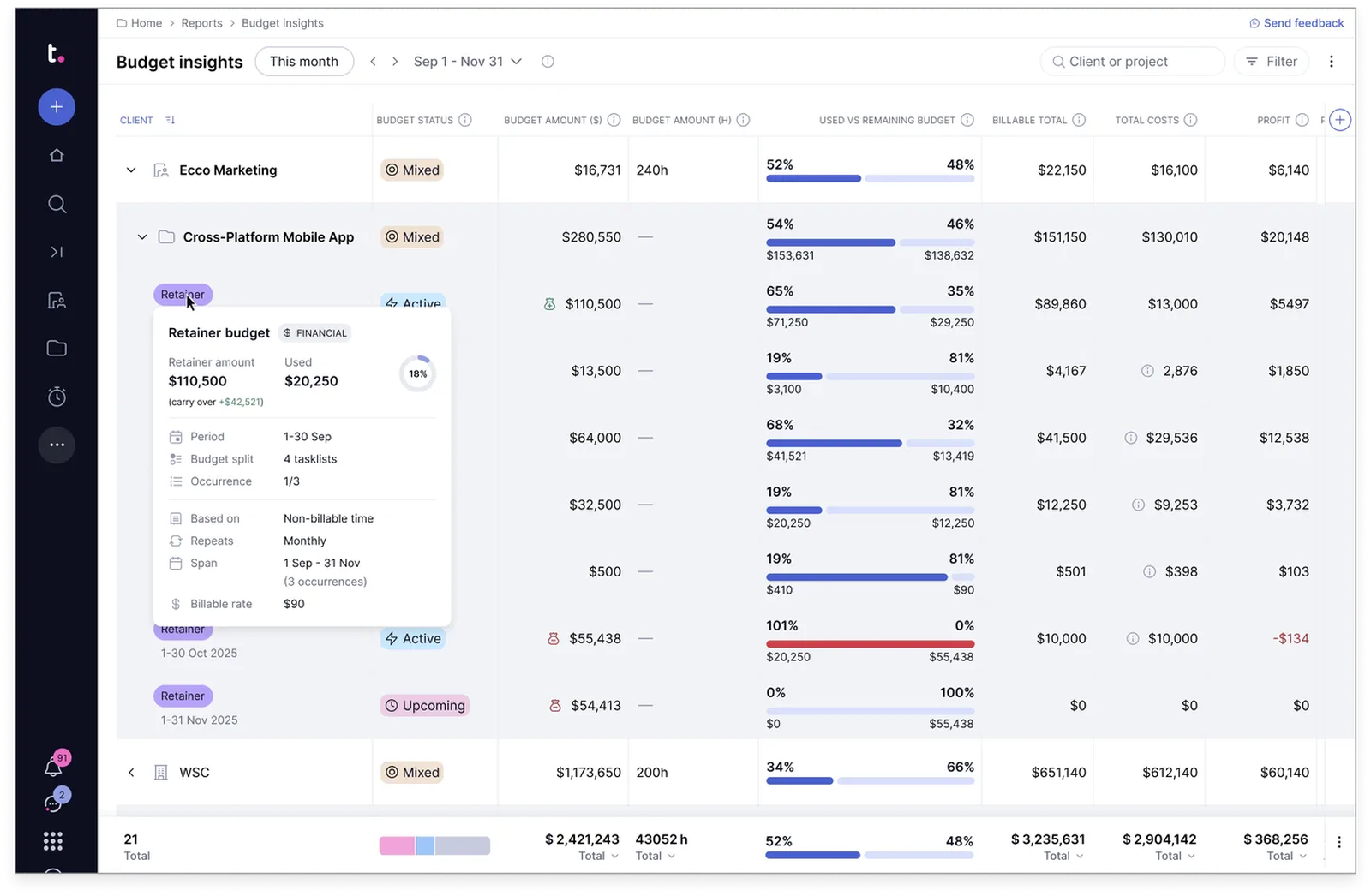

The reason we built budget alerts into Teamwork.com the way we did is because we've seen clients live through too many end-of-quarter surprises. We want our customers to see margin erosion while there's still time to course-correct.
When Farotech, a digital marketing agency, was juggling multiple tools to manage projects and track time, they faced exactly this problem. Their workflows were scattered and they had no unified view of where time and money were actually going. After consolidating into a single platform, they gained the visibility to catch overruns before they compounded.
A good rule of thumb is to set automated budget alerts at three thresholds: 50%, 75%, and 90% of your project budget. The 50% alert is your early warning. The 75% alert is your decision point: pause non-essential work, renegotiate, or accept the overrun. The 90% alert means all remaining work must be pre-approved.
Step 4: Communicate trade-offs, not just "no"
Nobody likes hearing "no." But everybody understands trade-offs. When a stakeholder asks for an addition, the response should never be a flat rejection. It should be: "We can do that. Here's what it changes."
Frame every scope addition as a choice between three outcomes: extend the timeline, increase the budget, or remove something else from the deliverable list. This isn't confrontational. It's responsible.
In my experience, this approach actually strengthens client trust. It shows you're managing their investment seriously, not just nodding along and hoping the budget holds. I've found that presenting a simple trade-off table makes the conversation concrete:
The language matters too. "We can't do that" shuts down the conversation. "We can do that if we adjust the timeline by one week" opens a productive negotiation. The client gets to decide what matters most to them, and you get a documented, approved change.
One technique I've found effective is presenting trade-offs in writing within 24 hours of the request. A quick email with the three options (extend, expand budget, swap) forces the decision out of the hallway and into the record. If the client doesn't respond, the default is "no change." This removes the ambiguity that feeds scope creep.
Step 5: Run weekly scope health checks
A 15-minute weekly review is the cheapest insurance policy against scope creep. Compare planned tasks against actual tasks. Check the budget burn rate against timeline progress. Ask whether any new work has entered the project since last week.
This doesn't need a formal meeting. It can be a quick dashboard review using project reporting tools that show time remaining versus budget remaining. What matters is that someone looks at the numbers every single week. Don't wait for a milestone review to catch problems three weeks old.
Self-audit checklist
Are hours tracked ahead of the original estimate?
Have any new tasks appeared since the last review that weren't in the SOW?
Is the budget burn rate exceeding the timeline completion percentage?
Has any team member flagged "extra work" that doesn't map to a deliverable?
Has the client made requests outside the formal change process?
Run through these five questions every Friday to catch scope creep early. If you answer yes to two or more, you have scope creep. The question is how much.
Common mistakes that let scope creep in
In my years inside professional services teams, and now watching customers work through this at Teamwork.com, I see the same four or five mistakes repeated. They're not complicated, but they're persistent.
Treating the SOW as a formality
Teams rush through scope documentation to get to the "real work" faster. The SOW becomes a box-checking exercise instead of a working contract. Then, when scope starts creeping, there's nothing concrete to point back to.
The fix: treat the SOW as the most important deliverable of the first week. If the scope definition isn't clear, nothing built on top of it will be either. I've watched teams spend three hours debating pixel alignment on a homepage but only 20 minutes defining what "website redesign" actually includes.
The SOW should be specific enough that any team member can read it and answer: "Is this task in scope or out?" If that answer requires a phone call to the PM, the SOW isn't finished.
Saying yes to "just five minutes of work"
There's no such thing as five minutes of work on a complex project. A client's "quick question" triggers a design review. That surfaces a dependency, which requires a conversation with another team member. The five-minute request becomes a two-hour detour, and nobody logged it.
According to the same Teamwork.com 6 Strategic Shifts for 2026 report, 43% of business leaders see shorter timelines for deliverables compared to five years ago. When timelines are already compressed, every unplanned addition hits harder.
Pro tip
Create a "parking lot" document for every project. When a client asks for something outside the current scope, add it to the parking lot instead of saying no. Review the parking lot at each milestone and decide together what moves into scope (with a change order) and what stays parked for Phase 2. This technique preserves the client relationship without letting scope expand unchecked.
Gold plating deliverables nobody asked for
Gold plating happens when team members add features, polish, or functionality beyond what was specified. Usually with good intentions. The problem is that gold plating costs time and money that comes directly off the project margin, and the client didn't ask for it.
Pro tip
Set clear "definition of done" criteria for every deliverable. When the team knows exactly what "finished" looks like, there's less temptation to keep polishing. You can define these criteria using task templates and standardized checklists that lock in acceptance criteria before work begins.
Skipping post-mortem analysis
Teams that don't review what went wrong after a scope-crept project are guaranteed to repeat the same mistakes. A structured post-mortem should identify three things: where scope expanded, why the change control process failed, and what the financial impact was.
This review is the foundation for preventing the same pattern on the next project. A phase-gate approach can build these review checkpoints directly into your delivery process so they don't get skipped under deadline pressure.
Not tracking the financial impact of accepted changes
Even when teams run a proper change control process, they often fail to track the cumulative financial impact of approved changes. Each individual change gets approved. But nobody is watching the running total.
I recommend maintaining a simple change log with a running cost column:
Change #
When the running total hits 15–20% of the original budget, that's your signal to pause and reassess. Either the original scope was underestimated, or the client's needs have genuinely evolved enough to warrant a contract renegotiation. According to Harvard Business Review's research on project overruns, a key driver of runaway costs is incremental commitment bias. Each small approval feels reasonable in isolation, but the running total becomes unsustainable.
How to handle scope creep with the right tools
What I've found makes the difference between catching scope creep and missing it entirely comes down to connected data. When time tracking, budget tracking, and project health live in separate tools, the signals get lost. When they're unified, scope creep becomes visible before it becomes expensive.
Here's how specific capabilities help you stay ahead of scope creep:
Budget tracking and alerts
)
The first line of defense against scope creep is knowing where your project budget stands at all times, not just at month end. Set budget thresholds that trigger automatic notifications when spending crosses 50%, 75%, and 90% of the allocated amount. This way, you're making decisions with runway left, not scrambling after the money is spent.
Time tracking
)
Billable versus non-billable visibility is the data foundation for catching scope creep. When you can see which tasks are eating non-billable hours, you can trace those hours back to unplanned scope additions. Time tracking that's integrated into your task management means data is captured where the work happens. No more reconstructing timesheets from memory on Friday afternoon.
Profitability reports
)
Real-time margin visibility per project, per client, and per team member turns scope creep from a vague concern into a quantifiable signal. When you can see that Project X's margin has dropped from 35% to 22% in two weeks, you know exactly where to investigate. You don't need to wonder whether scope is creeping. The numbers tell you.
Pro tip
Set up a weekly profitability dashboard review for all active projects. Sort by margin delta (the gap between planned and actual margin). The projects showing the steepest decline are your scope creep candidates. If you want to quantify the revenue impact, try running the numbers through a revenue gain calculator.
Intake forms
)
Scope creep often starts at the very beginning, when project requirements are captured informally. Standardized intake forms ensure that every new project follows the same structure: objectives, deliverables, exclusions, timeline, and budget. When the intake is structured, the scope is structured. When the intake is a casual email, the scope is whatever anyone remembers.
Project Health Report
)
A single dashboard showing time remaining, budget remaining, and overall project status gives you the scope health check without a manual audit. When time remaining is dropping faster than the deliverable list is shrinking, you've got a scope problem. This is the view I wish I'd had at every firm I worked at before joining Teamwork.com.
FAQ
What is the difference between scope creep and a legitimate scope change?
Scope creep is the uncontrolled addition of work without adjusting time, budget, or resources. A legitimate scope change goes through a formal process where someone documents the request, the team assesses impact, and a decision-maker approves or rejects it. The distinction is about whether the change was evaluated and agreed upon, not about its size.
What are the most common causes of scope creep?
The top causes are poorly defined project requirements, the absence of a change control process, and miscommunication between stakeholders and the delivery team. The desire to please clients by saying yes without assessing impact is another major driver. PMI's research on scope management confirms that weak requirements gathering and missing change control are consistently the primary culprits.
Can scope creep ever be positive?
In rare cases, managed scope expansion reveals genuine improvements. A client's request might surface a better approach or a higher-value deliverable. The key is that the addition goes through a formal evaluation process. The team needs to understand the cost and make a deliberate decision. Unmanaged additions are never positive, even if the work itself is good.
How does scope creep affect project profitability?
Every hour of unplanned, unbilled work directly reduces your project margin. Scope creep converts planned billable time into write-offs and increases non-billable utilization. It often triggers overtime that further compresses returns. For fixed-fee engagements, the impact is especially severe because revenue is capped while costs keep climbing.
What is gold plating in project management?
Gold plating means delivering beyond the agreed specifications without client authorization. It sounds generous, but it consumes budget on features nobody requested. It also introduces risk and raises client expectations for future projects. The best defense is a clear "definition of done" for every deliverable.
How often should you review project scope?
Weekly scope health checks are the minimum effective frequency. A brief 15-minute review comparing planned versus actual tasks catches drift before it compounds. Check the budget burn rate against timeline progress and flag any new work entries since the last review.
)
)
)
)
)
)
)
)
)
)
