Project budget template: Summary & key takeaways
What it is: A project budget template is a reusable structure for planning, tracking, and controlling every cost on a project, from labor to contingency.
Why it matters: Large projects run 45% over budget on average, so a template that compares planned versus actual spend protects your margin before overspend becomes a write-off.
The four components: Every solid project budget covers labor, materials and equipment, overhead, and a contingency reserve, which together form the cost baseline you track against.
Spreadsheet vs. software: A spreadsheet works for one-off projects; once you juggle multiple client projects and need real-time overspend alerts, you've outgrown it.
The client-work angle: For agencies and services firms, a budget isn't just cost control, it's the difference between a profitable project and one that quietly eats your margin.
You planned the project down to the last hour. Then a client "just one more thing"-ed their way past your estimate, and by month-end the margin was gone. I spent years in professional services watching budgets slip exactly like that, and the fix was rarely a smarter spreadsheet formula.
This guide gives you five project budget templates you can use today and a step-by-step way to build a budget with real numbers. You'll also get the four components every budget needs and a straight answer on when to leave spreadsheets behind. Let's keep your costs where you planned them.
What is a project budget template, really?
A project budget template is a reusable framework for estimating, tracking, and controlling the costs of a project across labor, materials, overhead, and contingency. It acts as your cost baseline: the planned spend you measure actual spend against as work happens.
The value isn't the file itself. It's the discipline of comparing what you planned to spend with what you actually spent, early enough to do something about it. For the full walkthrough of stages, overhead, and margin, our project budgeting guide goes deeper than I will here.
One distinction trips people up: the difference between a budget and a cost baseline. A project budget is the total approved funding for the work. The cost baseline is the time-phased version you actually measure performance against. In plain terms, the budget is the number you agreed to, and the baseline is the yardstick you hold each week's spend against. A good template gives you both, so you're never guessing whether you're ahead or behind at any point in the project.
Every project budget leaks somewhere, and it costs real money
I keep seeing the same quiet pattern across service teams: nobody notices the budget slipping until the invoice looks smaller than the effort. By then the money's already spent. The budget didn't blow up in one dramatic moment; it bled out through untracked scope changes.
The data backs up how common this is. In their study of more than 5,400 IT projects, McKinsey and University of Oxford found that large projects run 45% over budget on average while delivering 56% less value than predicted. A separate Harvard Business Review analysis of 1,471 projects put the average overrun at 27%, with one in six projects running 200% over budget. That's not a rounding error. That's the difference between a healthy year and a painful one.
Those are the projects that don't just miss margin, they take a chunk of the business with them. A budget template won't stop scope from changing. It'll just make sure you see the change while you can still price it.
What I've found is that the overrun almost never announces itself. It arrives as a series of small, reasonable-sounding yeses: one extra revision, a quick call that becomes three, a "while you're in there" request. Each one is defensible on its own. Added up, they're the difference between the margin you quoted and the margin you kept. A template's whole job is to make that sum visible before the project ends, not after.
For client work, the stakes are sharper. Scope moves because clients ask it to move, and every unbudgeted request chips at your profitability. A generic internal project can absorb a little slippage. A client project bills a fixed number, so slippage comes straight out of your margin. Our own research puts a number on how much that stings.
One of the reasons we built budget tracking into Teamwork.com is that spreadsheets go stale the moment scope shifts, and mid-project changes are exactly when you need a live view of your margin. When budget, time, and reporting sit in one place, a scope change updates your numbers instead of hiding in a tab nobody opened.
Here's the connection most budgeting advice misses: your budget and your billable utilization are the same story told twice. When a project runs over on labor, someone worked hours you can't bill, and your utilization drops with your margin. I use the billable utilization rate calculator to sanity-check that a budget's labor assumptions are actually achievable before I commit to them. A budget that assumes 100% billable time is a budget that's already wrong.
The practical takeaway is simple. A budget template isn't a finance chore you do once and file away. It's the earliest warning system you have for a project quietly turning unprofitable, and for services teams that warning is worth more than the template itself.
How do you build a project budget?
To build a project budget, define the scope, break the work into tasks with a work breakdown structure, then estimate labor, materials, and overhead for each task. Add a contingency reserve for risk, review the assumptions with stakeholders, and track planned versus actual spend as the project runs so you can course-correct early.
Here's the six-step framework I've relied on more times than I can count. Each step is something you can do in an afternoon, not a quarter.
Step 1: Define the scope
Write down what's in and, more importantly, what's out. In my experience, teams that skip the "out of scope" list lose the most margin, because every gray-area request defaults to "sure, we'll cover it."
Step 2: Break work into a work breakdown structure
A work breakdown structure splits the project into tasks and sub-tasks you can actually cost. You can't estimate a vague deliverable. You can estimate "design three landing page mockups."
Step 3: Estimate labor, materials, and overhead
Cost each task by role and hours, then add materials and a share of overhead. Labor is almost always the largest line, so get your billable and cost rates right before anything else.
Step 4: Add a contingency reserve
Ring-fence a buffer for the risk you can't itemize yet. I'll cover how much in the next section, but skipping this step is the most common budgeting mistake I see.
Step 5: Review assumptions with stakeholders
Walk the budget past whoever owns the client relationship and whoever delivers the work. Assumptions that look fine on paper fall apart when the delivery lead says "that task takes twice as long."
Step 6: Track planned vs. actual
Set the approved numbers as your cost baseline, then compare actual spend against it weekly. Planned vs. actual tracking is how you catch a 10% overrun at week three instead of a 40% overrun at delivery.
Now the part competitors skip: real numbers. Say you scope a website project at 100 hours. Your team splits into a designer at $85/hour cost rate and a developer at $95/hour, roughly 50 hours each. Labor lands at $4,250 plus $4,750, so $9,000. Add $500 in stock assets and software, plus 10% overhead ($900), and your cost baseline is $10,400.
A 10% contingency on that $10,400 baseline gives you a $1,040 buffer. That's roughly 11 extra developer hours at $95, so it absorbs one unplanned revision cycle without touching your margin.
If you bill the client $16,000, your profit is $5,600. Your profit margin looks like this:
A 35% margin is healthy going in. But if the developer needs 70 hours instead of 50, that's $1,900 in unplanned labor, and your margin drops to roughly 23% before anyone raises a hand. That's the exact leak weekly tracking catches. To keep the tracking honest, I lean on a budget vs actual tracker template so the variance is visible, not buried.
Retainers work the same way, just on a repeating clock. Say a client pays $8,000 a month for 80 hours of support. Your blended cost rate is $60/hour, so your monthly cost baseline is $4,800 and your target margin is 40%. The trap is quiet overspend: if the team logs 95 hours one month, that's an extra $900 in cost, and your margin slips to 33% for a month nobody flagged. Roll a couple of those months together and the retainer that looked profitable on paper isn't. Tracking hours against the retainer weekly, not at renewal, is what keeps that from happening.
Notice what both examples have in common. The budget didn't fail at the estimate. It failed in the gap between planned and actual, and the only fix is looking at that gap often enough to act on it.
What goes into a project budget
The four components of a project budget are labor costs, materials and equipment, overhead or indirect costs, and a contingency reserve. Labor is usually the biggest line, overhead covers shared costs like software and admin, and contingency protects you when scope shifts. Together they form the cost baseline you track against.
Here's how the components break down in practice.
Component
Contingency is the line most teams underfund, and it's the one that saves them. A contingency reserve is money you set aside for risks you can't itemize yet, like a client revision cycle you didn't quote.
In my experience, 5–15% of total project cost is a sensible range. I push toward the higher end for fixed-fee work or anything novel, because those are the projects where "we've never done this before" turns into unplanned hours. For a repeat project with a known client, the lower end usually holds. Tie your labor lines to accurate rates and you can allocate resources with far more confidence.
One nuance I've learned the hard way: contingency is a reserve, not a slush fund. If you spend it on the first small overrun without asking why, you've just quietly absorbed scope creep instead of surfacing it. I treat every draw on contingency as a flag worth a conversation, because a pattern of "we used the buffer again" usually means the estimate, not the buffer, needs fixing.
The other components are more predictable, but each has a trap. Labor gets underestimated when you forget non-billable time like internal reviews. Overhead gets ignored entirely on smaller projects, which makes them look more profitable than they are. Materials and equipment are usually accurate, because they come with invoices, but they're also the costs people forget to add to the budget at all.
Five budget templates for five kinds of client chaos
I've tested every one of these Teamwork.com budget templates on real client work, and each solves a different billing headache. Rather than pick a favorite, match the template to how you charge the client. Here's the quick version before I get into each one.
Template
Use the notes below to pick, then jump into the linked setup docs.
Time & Materials Project Budget template
When I'm running a task-based project and want to catch overspend early, this is my default. The Time and Materials Project Budget template tracks progress against budget whether you're billing by the hour or a set fee, and flags problems before they compound. It's best for one-off projects that need detailed, task-level budgeting.
Retainer Project Budget template
Retainers punish sloppy tracking, because unspent hours vanish and overspent ones eat next month. The Retainer Project Budget template rolls any surplus or deficit from one period to the next automatically, so you always know where you stand. It's my go-to for ongoing support and brand-management work; here's more on how to manage recurring revenue with retainers.
Task List Budget template

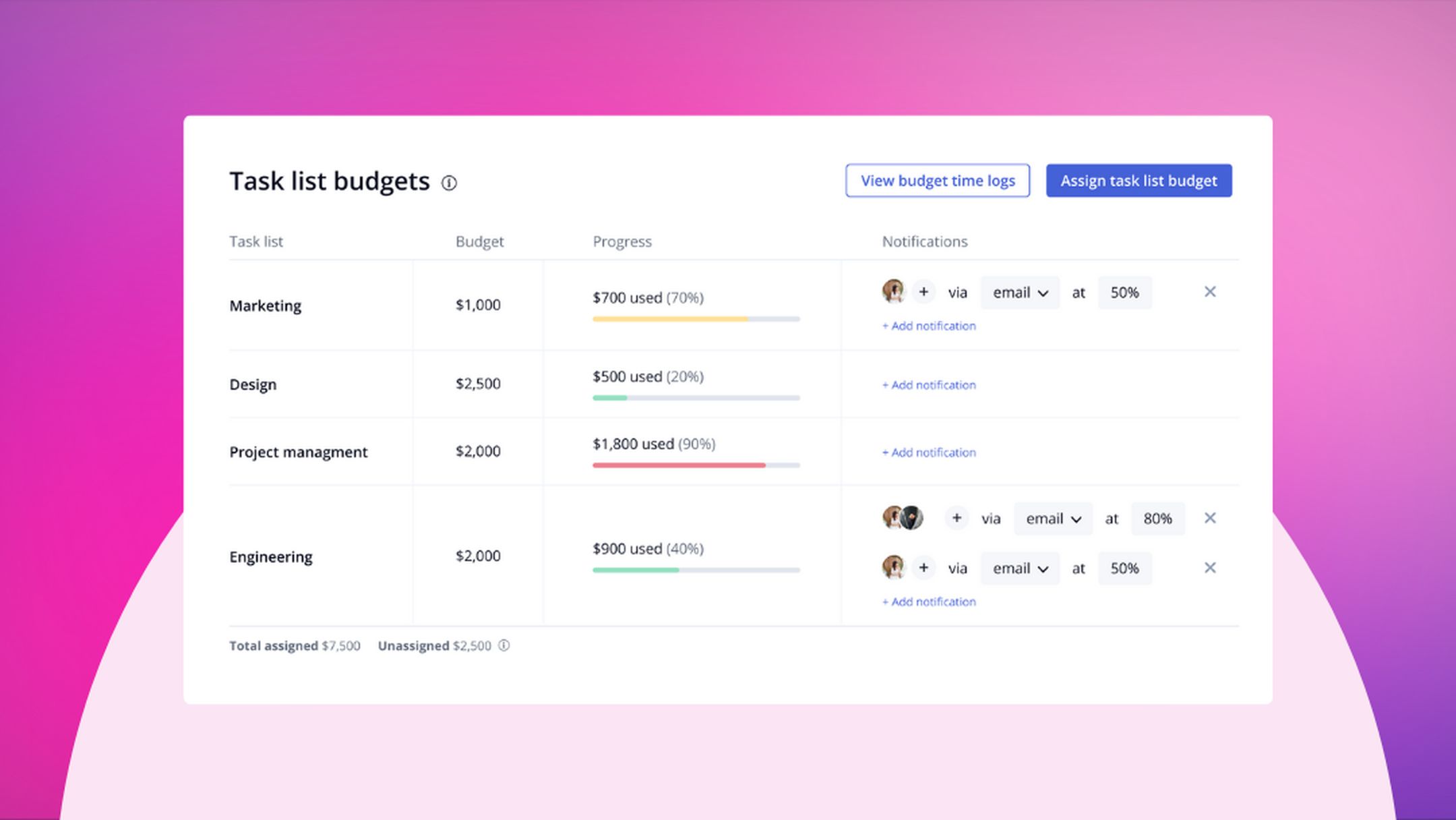

On big projects with several teams, one project-level number hides where the money's actually going. The Task List Budget template lets you set budgets for specific workstreams like design or development, so you spot a single team's overspend before it drags the whole project. I reach for this whenever more than two people own separate deliverables.
Project Budget Expenses template
Not every cost is an hour worked, and the ones that aren't tend to slip through. The Project Budget Expenses template tracks travel, software, and other one-off spend so your view of project profitability stays accurate. It's the template I add the moment a project involves anything beyond labor.
Fixed Fee Project Budget template
Fixed-fee work is where margin quietly dies, because the price is locked but the effort isn't. The Fixed Fee Project Budget template shows costs stacking up against the agreed price, so you can act the moment a task runs hot. It also gives clients clean visibility, which builds the trust that wins the next project.
Two more templates round out the set. A project profitability tracking template ties budget to billable hours and margin in one view, and you can browse the full library of project management templates if none of these fit exactly.
When should you ditch the spreadsheet for software?
The honest answer most roundups won't give you: a spreadsheet is fine, right up until it isn't. I ran budgets in spreadsheets for years and they worked, for a while. What broke them was volume: more client projects, more scope changes, more people needing the same number to be current.
A spreadsheet can't alert you when a task crosses 90% of budget. It won't tie a logged hour to a live margin. And every manual update is a chance for the number to be wrong. Here's the test I use.
The move to project budgeting software is less about features and more about getting one live number everyone trusts. The real advantage isn't a prettier interface. It's that your budgeting data, your time tracking, and your reporting stop living in separate files that disagree with each other.
Think about the decision in three tiers. If you run one or two simple projects at a time and rarely change scope, a spreadsheet is genuinely fine, and I won't pretend otherwise. If you're at a handful of concurrent projects and starting to feel the manual-update drag, you're in the yellow zone where a tool starts paying for itself. And if you're managing many client projects where a single missed overrun wipes out a month's margin, you're firmly in the red. At that point the spreadsheet is a liability dressed up as a habit.
Pro tip
Log hours straight against the budget as work happens so overspend shows up live, not at renewal; the Time Tracking in Teamwork.com feeds every logged hour into the same margin view.
The estimating stage matters here too. Getting rates and scope right at quoting and costing work is what makes the budget realistic in the first place, and a spreadsheet rarely carries those rates cleanly into tracking. Software closes that loop: the rate you quote becomes the rate you track against, with no re-keying and no drift.
The budgeting mistakes I see over and over
Across teams in my prior career and the customers we work with at Teamwork.com now, the same four mistakes show up again and again. None of them are exotic. All of them are avoidable.
Under-scoping from the start. What I've found is the biggest culprit isn't scope creep itself, it's a vague scope that invited the creep. If the estimate is fuzzy, every request feels in-bounds.
Skipping contingency. Teams that budget to the exact dollar have no room when reality arrives. A 10% buffer isn't padding, it's the price of not renegotiating mid-project.
Tracking only at the project level. A green project-level number can hide a badly overspent workstream. Track at the task-list level and the problem surfaces while it's still small.
Updating monthly instead of weekly. Monthly tracking tells you about a fire after the building's gone. Weekly tracking catches the smoke. This one change recovers more margin than any other I've seen.
Treating the budget as done once it's approved. A budget is a living document, not a signed contract you file away. What I keep seeing is teams pour effort into the estimate, get sign-off, then never look at it again until the project's underwater. The estimate is the easy 20%. The tracking is the 80% that actually protects your margin, and it's the part most teams skip.
Pro tip
Set budget threshold alerts so you're notified the moment a project crosses your chosen limit; the cost management software in Teamwork.com pings you before overspend becomes a write-off.
How Teamwork.com keeps budgets on track
)
I've found that the teams who stay on budget aren't more disciplined, they just have fewer places for numbers to hide. Here's how we bring budgeting, tracking, and forecasting into one view at Teamwork.com.
Set budgets that match how you bill. Whether you charge fixed fee, time and materials, or retainer, you can set the right budget type and rates per project. This is the same budgeting and profitability engine the templates above are built on.
Catch overspend before it lands. Get an alert the moment a project crosses your chosen budget threshold, so you can act while there's still margin to protect. Budget threshold alerts turn tracking from a monthly autopsy into a live signal.
See project health at a glance. Know instantly which projects are green, yellow, or red on budget and timeline with the Project Health Report, so you drill into the outliers instead of reading every project. It's the view I'd open first every Monday.
Predict profitability without the number-crunching. Get an instant read on whether a project will stay profitable with the AI Profitability Forecaster, part of TeamworkAI, which turns historical revenue and cost data into a forward view. Spend less time in spreadsheets and more time protecting margin.
Build the project in minutes, not hours. Turn a scattered client brief into a fully structured project with the AI Project Wizard, so budgets, tasks, and timelines start aligned instead of stitched together later. Setup that used to take 30 to 45 minutes takes a couple of clicks.
The through-line is unified data. When SugarCRM brought projects, time tracking, and billing into Teamwork.com, they hit near-perfect invoicing accuracy, crediting less than $20K on over $10M in annual invoicing. That's the payoff of one connected number instead of five disagreeing files, and it's the same reason our customers improve billable utilization by an average of 21.8% after a year on the platform.
A project budget template gives you the structure; the tracking is what keeps it honest.
FAQ
How do you write a budget for a project?
Writing a project budget starts with defining the scope and breaking the work into tasks with a work breakdown structure. Estimate the cost of each task across labor, materials, and overhead, then add a contingency reserve for risk. Review the assumptions with stakeholders, and track planned versus actual spend as the project runs.
What are the four components of a project budget?
The four components of a project budget are labor costs, materials and equipment, overhead or indirect costs, and a contingency reserve. Labor is typically the largest line item, overhead covers shared costs like software and admin, and contingency protects you when scope shifts. Together they make up the cost baseline you track against.
What should you include in a project budget?
Include labor costs for your team and any contractors, direct expenses like software and subscriptions, and overhead such as office space and admin. Always add a contingency line for unexpected costs, and a planned-versus-actual column so you can track variance as the project runs.
What is the 50/30/20 budget rule, and does it apply to projects?
The 50/30/20 rule splits personal income into needs, wants, and savings, so it doesn't map directly to project budgets. For projects, a more useful split is direct labor, materials and expenses, and a contingency reserve. Treat it as a reminder to always ring-fence a buffer rather than allocate every dollar.
How much contingency should a project budget include?
A common contingency range is 5–15% of total project cost, depending on risk and uncertainty. Push toward the higher end for fixed-fee or novel work, where unplanned hours are more likely, and toward the lower end for repeat projects with a known client.
Excel or project budgeting software, which should you use?
Use Excel for one-off or simple projects where a manual update once in a while is fine. Move to project budgeting software when you manage multiple client projects, need real-time overspend alerts, or want budgets tied to live time tracking and reporting.
)
)
)
)
)
)
)
)
)
