Project scoping for agencies: Summary & key takeaways
Scope is a revenue boundary: It defines what you deliver, what you charge for, and where your responsibility ends.
A longer document doesn't protect margin: The pricing model you scope against and a live change process do.
The Margin-First Scope test: Every scope line needs a deliverable, a boundary, an acceptance test, and a change-trigger.
Paid discovery is a scoping decision: Charging for the thinking filters serious clients and pays for work you give away.
Tight scoping compounds: Deliberate scoping means less replanning mid-project and more deadlines hit.
Project scoping for agencies is the difference between a profitable engagement and one you deliver half for free. I've read hundreds of agency scope documents, and the ones that hold margin aren't the most detailed. They're the ones where every promise ties to a price, a boundary, or a trigger for a paid change. This guide gives you a margin-first way to scope, a seven-step process, and the pricing decisions that make it stick.
What does project scoping actually mean when the client is paying?
What I keep seeing across agencies is scope treated as a planning artifact for the delivery team. The client, though, reads it as a contract about money. That gap is where margin disappears. For an agency, project scoping means defining a client project's outcomes, deliverables, and boundaries before work starts. Both sides then agree on what's included, what isn't, and what "finished" looks like.
The word that matters most is boundaries. Internal scope answers "what will we build?" Client-facing scope answers a second question: "what won't we do without charging for it?" For example, a website scope might promise eight page templates, cap revisions at two rounds, and bill any extra page as a change.
Client-facing scope carries a commercial job internal scope never does. It sets the expectation the client holds you to. It's the reference point for every "is this included?" call. Get it vague and you've handed the client the pen.
A precise scope isn't a defensive document. It signals you've done this before and know where projects go sideways. I've found clients relax when the boundaries are clear. Clarity is what lets them say yes to a change without feeling nickel-and-dimed.
This is where agency scope diverges hard from in-house scope. When an internal team scopes a project, an extra week or a few added tasks moves a date. When an agency does the same for a fixed fee, that extra week comes straight out of profit, because the price was already agreed. The stakes of a vague line aren't schedule slippage; they're margin. That's why I treat scoping as a commercial skill first and a planning skill second. The planning keeps the work organized. The scoping keeps the work worth doing.
At Teamwork.com, we see the same pattern across our customers: the scoping problem isn't vagueness. No one wrote down the commercial edges. The deliverables were clear; the exclusions, the definition of done, and the change-order trigger were not.
A scope document isn't a statement of work, and it isn't your high-level requirements. Keep them distinct. The statement of work sits downstream of the scope, and your high-level requirements feed into it.
Why a fatter SOW never saved anyone's margin
Because more detail alone doesn't protect margin, adding pages to your scope rarely changes what happens when the client pushes. Plenty of agencies answer a painful project by writing a longer template, then lose margin there too. The volume of documentation was never the variable. Honestly, I'd take a one-page scope with a real change-trigger over a twenty-page one without.
The pressure is real, and it's getting worse. According to PMI's Pulse of the Profession research, 52% of projects experience scope creep, up from 43% five years earlier. In Teamwork.com's own 2026 research, 66% of senior leaders said clients are now more demanding but less willing to pay.
A detailed scope fails for one reason. It describes the work but doesn't decide what happens when the work changes. Miss the boundary and the trigger, and your scope is just a tidy list of things you'll over-deliver.
The Margin-First Scope: a test for every line you commit to
I judge a scope by running each line through the same four questions. It's saved more projects than any template I've used. Most scopes list deliverables and stop. A margin-first scope treats the deliverable as one-quarter of the job.
Every meaningful scope line needs a Deliverable, a Boundary, an Acceptance test, and a Change-trigger. Miss one, and you leave a gap the project will find.
Scope element
Take a website build at a fixed fee. The deliverable is eight page templates. The boundary caps revisions at two rounds and excludes copywriting. Acceptance is written sign-off on staging before launch. The change-trigger is any page beyond the eighth, which you bill at a stated rate. Now "can you add a few more pages?" has a home. It's a change, not a fight.
The same test works on retainers, where the failure mode differs. Say you retain a client for twelve content pieces a month. The boundary is that unused pieces don't roll over. Acceptance is a two-day review window. The change-trigger is any request that pushes past twelve. Without those three parts, a retainer becomes an all-you-can-eat buffer.
The four-part test isn't extra paperwork. On a handful of core lines, it's a few added sentences per deliverable. What it changes is where the pressure lands. Instead of absorbing ambiguity on your own time, every soft edge becomes a decision the client made with you.
The test also gives your team a shared language. When a designer flags that a request "isn't in the deliverables," or an account manager notes there's "no acceptance criteria for this yet," they're pointing at a specific gap, not just grumbling that a client is being difficult. That shared vocabulary is what turns scope from a document the account lead owns alone into something the whole delivery team can defend. I've found the strongest agencies scope out loud together, so the person doing the work and the person facing the client hold the same line.
I keep the scope out of a document nobody reopens. A standardized intake and brief process turns an agreed scope into tasks. Every project starts the same shape, so the boundaries travel with the work.
How to scope a client project in seven steps
When I scope a new engagement, I don't start with deliverables. I start with what the client is actually buying, then work down to the tasks. The pattern I see fail most is jumping to a deliverables list before anyone agrees on the outcome. I've found these seven steps keep the commercial logic and the delivery plan connected.
Step 1: Start with the client's outcome, not the deliverables list
I ask what has to be true for the client to call this a success. A "new website" isn't an outcome. "A site the in-house team can publish to without a developer" is. Anchoring on the outcome gives you a reason to include or exclude everything else.
The outcome protects you later. When a mid-project request doesn't move the agreed outcome, that's your evidence it belongs in a change order. It isn't part of the current budget.
Here's how that plays out. Say a client asks for a rebrand, and you scope it as "a logo and a style guide." Three weeks in, they want social templates, email headers, and a pitch deck too. If your agreed outcome was "a logo and a style guide," every one of those is a change. If the outcome was "everything we need to relaunch the brand," you just signed up to define, design, and deliver an open-ended list for a fixed fee. The outcome sentence you write in week one decides which of those two projects you're running.
Step 2: Turn outcomes into specific, quantified deliverables
Vague deliverables are where margin leaks fastest. "Social content" invites forty assets. "Twelve static posts and four short-form videos a month" sets a countable ceiling. Numbers separate a deliverable from an open tab.
For each deliverable, I name the format, the quantity, and the output. If a line can't be counted or checked off, you haven't scoped it fully yet. This is also where I break bigger outputs into a work breakdown structure so estimates map to real tasks.
I hold this level of specificity even when the client is in a hurry. The ten minutes it takes to quantify a deliverable beats the ten hours you'll argue about it in month two.
Step 3: Write the exclusions before the client asks
In my experience, exclusions are the most-skipped section in agency scopes, and the most valuable. PMI's practitioners recommend defining both sides of the boundary during planning, not during a dispute.
I state plainly what we are not doing: copywriting, stakeholder wrangling beyond one round, third-party licensing, content migration. Named that way, the absence is a decision rather than an oversight.
A useful test is to write the exclusions as the mirror image of your deliverables. If the deliverable is "eight page templates," the exclusion is "additional pages, e-commerce functionality, and third-party integrations, unless added as a change." If the deliverable is "a brand style guide," the exclusion is "applying the brand to existing collateral." Every deliverable has a shadow list of nearby work the client may assume is included. Writing that shadow list down is what stops the assumption becoming an argument. It takes ten minutes and saves the awkward mid-project conversation where you and the client each believed something different was agreed.
Step 4: Define "done" with acceptance criteria
I give every deliverable a test for "finished," or revision rounds run forever. Acceptance can be as simple as "client sign-off in writing on the staging link." Or "approval from the named decision-maker within five business days."
Tie acceptance to a specific person and a specific window. "Pending client feedback" with no owner and no deadline turns a two-week phase into a two-month one.
Then write in a default. If the client doesn't send feedback within the agreed window, you treat the deliverable as accepted and start the next phase. That single line ends the stalled-timeline problem I see most: a client who goes quiet while your team holds the schedule open for free.
Step 5: Map stakeholders and approval layers
I've learned surprise decision-makers are a scoping problem disguised as a communication problem. Before you commit, name who approves what. Cap how many approval layers a deliverable passes through.
The trap is the stakeholder who appears in week four with strong opinions and no earlier involvement. You can't prevent it, but you can scope around it. State that one named contact consolidates all feedback. New reviewers introduced mid-project may trigger a revision round.
Step 6: Pressure-test scope against capacity and margin

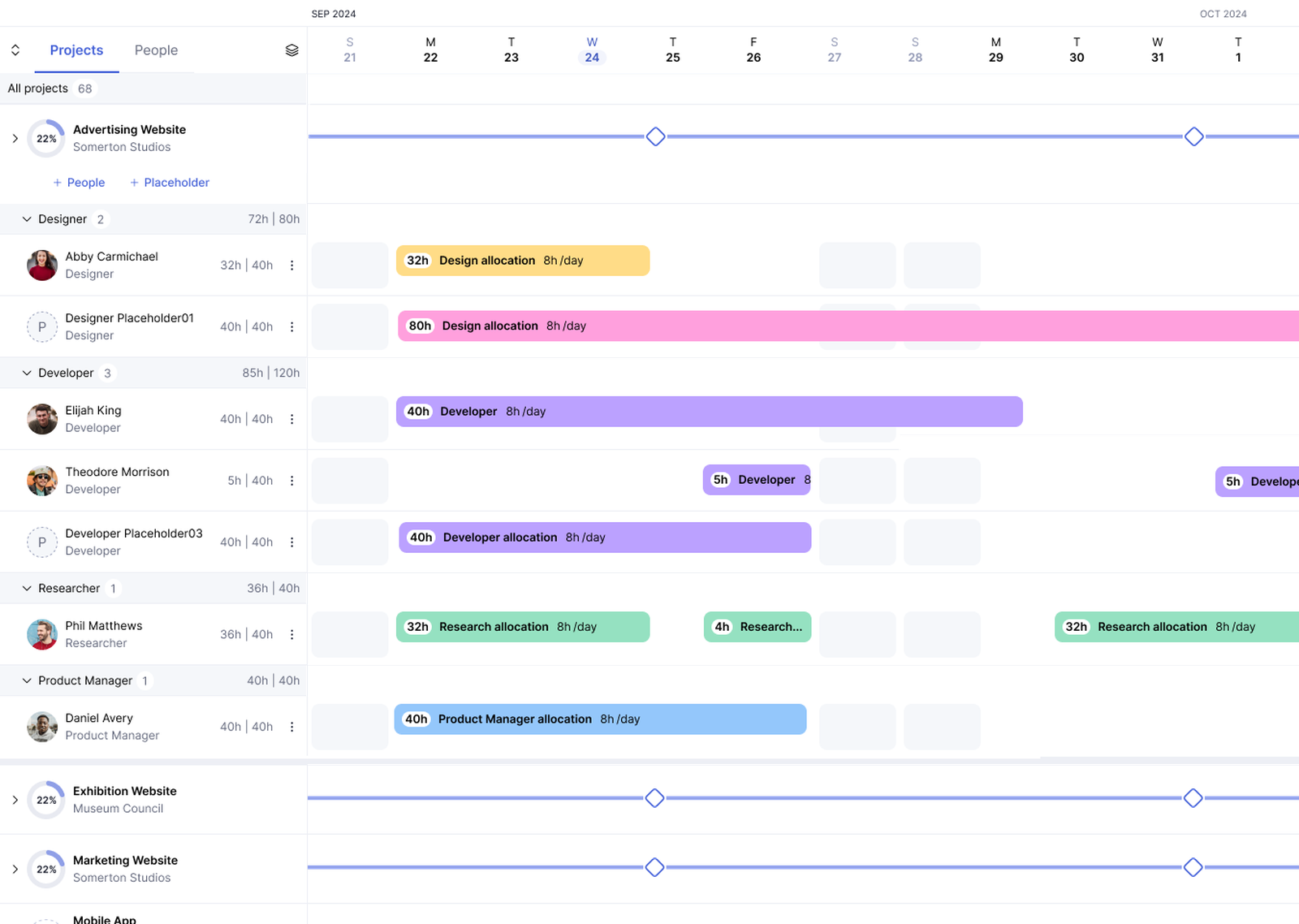

A scope you can't staff profitably isn't a scope; it's a wish. Before I sign, I check the committed hours against who's actually available. Then I check what the work must earn per hour to clear the target margin.
This is the step agencies skip under deadline pressure. It's also the one that decides whether the project makes money.
The math is worth doing out loud. Suppose you quote a project at $30,000 fixed fee, and your blended cost rate is $75 an hour. That budget buys roughly 400 hours before you break even, and you want a 30% margin, so your real ceiling is about 280 billable hours. If the scope, once you break it into tasks, needs 340 hours to deliver, you've lost the margin before the kickoff call. Better to see that gap now and either reprice, re-scope, or trim the deliverables than to discover it in the final month.
A resource and workload view shows capacity at a glance, so "we'll find a way" becomes a number you can trust. To sanity-check the economics, I use a billable utilization rate calculator to benchmark the target.
When a 40-person digital agency, Invanity, tightened how it planned and resourced client work, it saw real numbers. Planning time dropped 50% and on-time delivery rose 20%. See the Invanity customer story.
Step 7: Set the change-trigger and sign-off ritual
I decide, in writing, what turns a request into a paid change and who approves it. A one-line rule works. Anything outside the agreed deliverables or exclusions gets a quick estimate and a yes before it starts.
Then I make sign-off a ritual, not an afterthought. A short, consistent approval step at kickoff and each milestone keeps the change-trigger from becoming a suggestion everyone ignores.
The part agencies dread is pricing the change itself, so I keep it mechanical. Every change order names the extra work, the hours, the cost, and the new timeline impact, in the same format every time. When the format is consistent, the client stops reading it as a penalty and starts reading it as a normal part of how you work. I've found the agencies that lose money on changes aren't the ones who charge too little. They're the ones who never send the change order at all, because raising it felt awkward in the moment. A pre-agreed trigger and a template take the awkwardness out, because the client already said yes to the process when they signed the scope.
Pro tip: I turn the change-trigger into a saved project template so every new scope starts with the boundaries already in place, and creep has nowhere to hide.
How does your pricing model decide how tight your scope has to be?
Once those seven steps are in place, the next question is pricing. Early in my career I priced near-identical deliverables three different ways, and the version that made money on a retainer lost it on a fixed fee. The scope hadn't changed; the commercial model had. Before you decide how detailed to get, decide who carries the risk.
Pricing model
Fixed-fee work is where a loose scope does the most damage. Every hour you didn't account for comes straight off your margin. That's the model where the four-part test earns its keep.
On a retainer, the risk shifts. The danger isn't a single overrun. It's a slow pile-up of "quick asks" that eat the hours you'd planned for higher-value work.
Time and materials looks safest, and in one sense it is. But it has its own scoping demand. The client sees the meter running, so a vague estimate reads as a lack of control. I scope the estimate and reporting cadence as tightly as a fixed-fee deliverable.
Many agencies blend these across one account, which is fine as long as each slice gets the discipline its model demands. A common pattern is a fixed-fee build followed by a monthly retainer for support. The trouble starts when the retainer quietly absorbs work that should have been a change order on the build, or when build-phase requests get parked "for the retainer" and never get priced at all. If you run a hybrid, draw the line between the two clearly in the scope, and decide up front which bucket a given request falls into.
The rule of thumb: the more risk you carry, the more of the boundary you write down. Whichever model you use, I treat live margin visibility as part of the scope. To spot a drifting fixed-fee project early, budget and profitability tracking shows planned versus actual while there's still time to act.
Should you charge for scoping? Make the case for paid discovery
That pricing risk starts even earlier, the moment a prospect asks for a free scope. The situation I get asked about most is exactly this one: detailed scoping work handed over before any budget commitment exists. You build a proper plan, send it over, and never hear back. Or worse, you watch it walk into a competitor's pitch. If that sounds familiar, you're not bad at sales. You're giving away the most valuable thing you make.
Free scoping hands over expensive thinking before a client commits. I've come to treat a free, detailed scope as a bigger red flag than a client who pushes back on price. Teamwork.com's 2026 research named the pattern: 23% of firms reported clients disingenuously prospecting for work. The takeaway was blunt. Stop giving away strategy, and start pricing the scoping phase.
I package discovery as a fixed-fee engagement with its own deliverables. A requirements summary, a recommended approach, and a costed plan for the build. Price it at a fraction of the project, and credit it against the full engagement if the client proceeds. That removes the "why would I pay for a quote?" objection, because the client keeps a plan either way.
The numbers make the case on their own. A paid discovery phase priced at, say, 5-10% of the likely project turns weeks of unpaid pre-sales work into a small revenue line and a much sharper scope. Even when a client doesn't proceed, you're paid for the thinking instead of absorbing it. And when they do proceed, the build scope is grounded in real requirements rather than the optimistic guesses you'd otherwise carry into a fixed fee. Agencies that move the scoping work behind a paid discovery gate tend to cut their fixed-fee overruns sharply.
Paid discovery does two jobs. It pays you for the scoping work you already do, and it filters out the clients who were never going to sign. The clients who balk are usually the hardest to scope and the slowest to pay. It costs you the time-wasters and keeps the clients who value the work.
The scope-creep moments that quietly drain agency margin
Even when you charge for discovery, margin still slips through small day-to-day moments. Scope creep rarely shows up as one big demand. It arrives as a series of reasonable-sounding small ones. I won't rehash the mechanics; our guide to scope creep covers the causes. But these are the moments I see cost agencies the most. Managing the relationship around them is its own discipline, covered in our client project management guide.
Client-supplied assets that arrive late: Copy, logins, and approvals are the top hidden delay. Name who owns each input, and what happens when it slips.
The silent free revision round: "One more tweak" is fine once. By the fourth, you're funding it. Your acceptance criteria let you say "that's round three of two."
No change-trigger, so everything is a favor: Without an agreed trigger, every request is a judgment call. Agencies almost always err toward yes.
Phase-one and phase-two blur into one budget: When later-phase ideas leak in, you deliver phase two for a phase-one fee. Write the phase boundary into the scope.
How to scope client projects in Teamwork.com
Because those creep moments hit margin in real time, I use a tool that shows me money, not just tasks. That's exactly where generic project management tools fall short. They track work beautifully and tell you nothing about whether it's profitable. As the agentic PSA built for client delivery, Teamwork.com connects the scope to the resourcing, budget, and invoice in one place. Here's how I would use it when scoping.
Once the scope is agreed, the next risk is losing those boundaries during handoff. Start every project the same way, and they stop getting lost. Standardized intake and brief forms turn an agreed scope into a structured project, with tasks already shaped around your deliverables and exclusions.
)

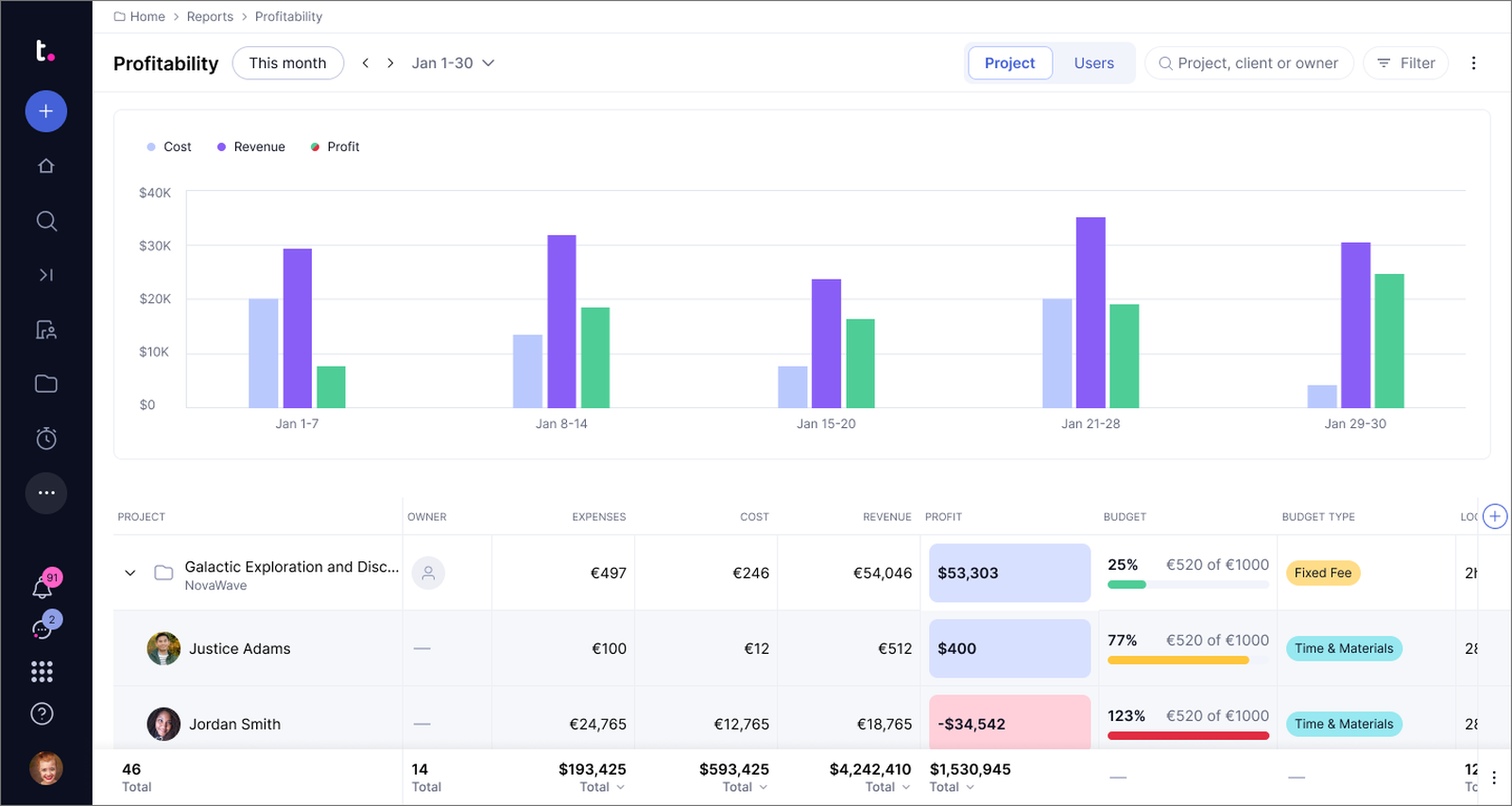

A strong scope still fails if margin drift stays invisible. Spot a drifting fixed-fee project early, and you can act. Budget tracking and profitability reports show planned versus actual against the scope while you can still do something about it.
)
A scope only works commercially if the team can actually deliver it at the promised pace. Know a scope is deliverable before you promise it. The Workload Planner and Resource Scheduler show who's overbooked or free, so you pressure-test capacity at Step 6 instead of finding the problem in week three.
)
Even a well-staffed project loses money when small extras stay hidden. Catch unbilled creep before it becomes a write-off. Time tracking splits billable from non-billable, so the hours piling up against a deliverable are visible early.
)
Past delivery data is what turns scoping from optimism into a repeatable commercial decision. Forecast cost and margin from real work, not a hopeful guess. Teamwork AI, including the AI Forecaster and AI Utilization Summary, projects both from your historical delivery data.
)
The final gap is what happens after a change is approved. Turn it into billed work without re-keying anything. Connected quote-to-cash and invoicing pushes the change you scoped and signed off straight into the bill, closing the loop most tools leave open.
Scoping questions agencies ask when margin is on the line
What is project scoping for an agency?
Project scoping for an agency means defining a client project's outcomes, deliverables, and boundaries before work begins. Both sides agree on what's included, excluded, and what "done" means. Unlike internal scoping, it doubles as a commercial boundary that protects margin.
What's the difference between a project scope and a statement of work?
Scope confusion usually surfaces at billing time, so the distinction matters. A project scope defines what the project will and won't include. A statement of work is the contract that turns that scope into agreed terms, timelines, and payment. You scope first, then formalize it in the SOW.
How do agencies prevent scope creep?
Agencies prevent scope creep with explicit exclusions, written acceptance criteria, and a formal change control process. The document alone isn't enough; the client has to agree to the boundary in writing. Reviewing live budget-versus-actual data catches creep while there's still time to act.
Should agencies charge for discovery or scoping?
Yes. Charging for discovery pays you for the thinking that produces a scope, and it filters out clients who were never going to buy. Package it as a standalone deliverable, such as a scoped roadmap the client owns.
What is the 80/20 rule for project managers?
A handful of deliverables usually drive most of a client's outcome, which is the 80/20 rule in practice. The Pareto principle holds that roughly 80% of results come from about 20% of the work. In scoping, protect that vital 20% first.
What are the 5 C's in project management?
Most project managers group the 5 C's into communication, coordination, collaboration, control, and closure. Together they keep a project aligned from kickoff to sign-off. In scoping, control and closure matter most: control governs changes, and closure ties to your acceptance criteria.
)
)
)
)
)
)
)
)
)
