How to build a project timeline in Excel (and when to move beyond it)

Blog post image

Building project timelines in Excel: Summary & key takeaways

  • Excel is familiar, not optimal: Most project managers default to Excel for timelines because it's already installed and requires no procurement process, but it wasn't designed for project scheduling.

  • Three methods exist: You can build a Gantt-style timeline using stacked bar charts, create a quick milestone visual with SmartArt, or filter date-based data with PivotTable timelines.

  • Manual maintenance is the real cost: Every date change, dependency shift, or status update requires manual edits across cells, formulas, and charts.

  • Collaboration is the breaking point: Excel timelines fall apart when multiple team members need to update progress, track dependencies, or view personalized task lists in real time.

  • Purpose-built tools exist for a reason: Once your projects involve dependencies, resource allocation, or client-facing deadlines, a dedicated platform saves more time than Excel ever will.

I've built more Excel timelines than I care to admit. They always started the same way: a clean spreadsheet, a few task rows, some color-coded cells, and the quiet confidence that this one would actually stay up to date. It never did.

This guide walks you through exactly how to build a project timeline in Excel, covering three methods from detailed Gantt charts to quick milestone visuals. I'll also share the signals I've learned to watch for that tell you it's time to move beyond spreadsheets altogether.

What is a project timeline (and why does Excel end up being the default)?

A pattern I kept seeing in my prior career is teams reaching for Excel the moment they need to visualize a project schedule. Not because it's the best tool. Because it's the path of least resistance.

A project timeline is a visual representation of tasks, milestones, and deadlines arranged in chronological order. It shows your team what needs to happen, when it's due, and how tasks relate to each other. For professional services teams delivering client work, timelines are what keep promises on track.

So why does Excel become the default? Three reasons come up over and over:

  1. It's already there. No software request, no procurement approval, no IT ticket. Excel is on every work laptop.

  2. Everyone knows the basics. Your team can open a spreadsheet and start entering tasks without training.

  3. It feels flexible. You can customize columns, add formulas, and build exactly the structure you want.

The problem is that flexibility comes with a maintenance tax. According to Teamwork.com's 6 Strategic Shifts for 2026 report, 43% of professional services teams say clients now expect shorter timelines for deliverables. When deadlines are tightening, spending hours maintaining a spreadsheet timeline is time you can't afford.

What Excel gives you
What it doesn't
Familiar interface
Real-time collaboration
Custom column structures
Automatic dependency tracking
Formula-based calculations
Resource visibility across projects
Conditional formatting for visual cues
Automated status updates
Free (if you have Microsoft 365)
Scalability for complex projects

How to create a project timeline in Excel: the stacked bar chart method

In my experience, this is the method that gives you the most usable result. It's also the most involved to set up. Think of it as building a basic Gantt chart: you'll get horizontal bars showing each task's duration across a date axis.

Before you open Excel, you need three things ready. First, a complete task list broken down to individual deliverables. Second, estimated start and end dates for each task. Third, a clear understanding of which tasks depend on others. Skipping this prep step is the number one reason Excel timelines end up messy. I've seen teams jump straight into the spreadsheet and spend twice as long reorganizing tasks they listed in the wrong order.

The process takes roughly 30 to 60 minutes for a first build. After that, you'll have a reusable template. (If that sounds like a lot of work, AI-powered project setup can generate the same result in minutes.)

Set up your data table

Start by creating four columns in a fresh Excel sheet: Task Name, Start Date, End Date, and Duration. List every task in your project, one per row. Be specific with task names. "Website redesign" is too vague. "Create wireframes for homepage" is actionable.

For example, a client onboarding project might look like this:

Task name

Start Date
End Date
Duration
Kickoff meeting
06/02/2026
06/02/2026
0
Gather project requirements
06/03/2026
06/06/2026
3
Create project scope document
06/07/2026
06/10/2026
3
Client approval on scope
06/11/2026
06/13/2026
2
Build project plan
06/14/2026
06/18/2026
4
Assign resources
06/19/2026
06/20/2026
1
Begin execution
06/21/2026
06/21/2026
0

Leave the Duration column blank initially. In the next step, you'll add a formula to calculate it automatically.

A few formatting tips that save headaches later. Use consistent date formatting across every cell (MM/DD/YYYY works well in the US locale). Avoid merging cells anywhere in your data table. Keep task names descriptive enough that anyone on your team understands the task without asking.

Insert a stacked bar chart

In the Duration column, enter a formula to subtract the Start Date from the End Date. In cell D2, type =C2-B2. This calculates the number of days between the two dates. Drag the formula down to fill all rows.

Now select all values in the Start Date column. Go to the Insert tab, find the Charts section, and select the 2D Stacked Bar Chart. An empty chart will appear on your sheet.

If the chart looks blank or wrong at this stage, don't worry. You haven't added the duration data yet. The next step brings the chart to life.

Add task durations to the chart

Right-click the chart and select "Select Data." Click Add under Legend Entries. For the Series Name, click the Duration column header. For the Series Values, select all the duration numbers. Click OK.

Next, you need to add task names. Right-click the chart again, select "Select Data," and click Edit under "Horizontal (Category) Axis Labels." Select all your task names from the Task Name column. Click OK twice.

Your chart now has start dates and durations plotted. It won't look like a proper timeline yet, but you're close.

Format the chart into a Gantt-style timeline

This is where the stacked bar chart transforms into something resembling a Gantt chart. Three formatting steps make the difference:

  • Reverse the task order. Right-click the task names on the vertical axis and select "Format Axis." Check the "Categories in reverse order" box. Your first task now appears at the top. Without this step, your timeline reads bottom-to-top, which is counterintuitive for anyone reviewing it.

  • Hide the start date bars. Right-click the blue (start date) portion of any bar. Select "Format Data Series." Under Fill, choose "No fill." Under Border, choose "No line." The blue bars disappear, leaving only the duration bars, which now show when each task starts and how long it runs.

  • Remove the dead space. Right-click the first start date in your data table. Select "Format Cells" and note the number under "General." Go back to your chart, right-click the date axis at the top, select "Format Axis," and set the Minimum bound to that number. This pulls your first task's bar to the left edge of the chart.

Customize colors and remove blank space

Right-click any duration bar and select "Format Data Series." Reduce the gap width to 10–20% to close the space between bars. Choose a color that matches your team or client brand.

You can also add data labels to show task names or durations directly on each bar. Right-click any bar, select "Add Data Labels," then format them to show the category name instead of the value.

Hard truth

The Excel Gantt chart you just built looks like a timeline, but it doesn't act like one. It won't alert you when a task is overdue. It won't shift downstream dates when a dependency slips. It won't show you who on your team is overbooked. Every one of those things requires manual intervention, every single time something changes.

For teams managing multiple concurrent client projects, this manual overhead compounds fast. A timeline that takes 45 minutes to build might take 3 to 5 hours per week to maintain. Once dates start shifting, the overhead compounds fast.

You now have a working Gantt-style timeline in Excel. It updates automatically when you change dates in the data table. For a simple project with 10 to 15 tasks, this works well enough to share with stakeholders. For anything larger, the maintenance burden starts to outweigh the value, which is exactly where the limitations section of this guide comes in.

Get real-time scheduling, dependency tracking, and collaborative timelines that update themselves.
Try Teamwork.com

Two faster methods (and when each one actually makes sense)

In my experience, most teams skip both of these methods because they don't know when to use them. Not every situation calls for a full Gantt chart build. Sometimes you need a quick milestone visual for a client presentation or a way to filter project data by time period. Excel offers two lighter methods that solve different problems.

Create a quick timeline with SmartArt

In my experience, SmartArt timelines work best for high-level milestone views: showing a client "here are the five key delivery dates" without getting into task-level detail.

Go to Insert, find SmartArt under Illustrations, and select Process. Choose the Basic Timeline layout. A simple arrow-based graphic appears with text placeholders. Click each placeholder to add your milestone name and date. Use the plus icon in the text pane to add more milestones.

SmartArt timelines are fast to build, taking five minutes or less. The tradeoff is that they show no duration, no dependencies, and no task-level detail. They're presentation aids, not project management tools.

You can customize colors and styles through the SmartArt Design tab. Change the overall theme, switch between timeline layouts, or adjust individual element colors. The result is a polished visual that works in slide decks and project proposals, but it won't help you manage the day-to-day work.

Pro tip

Use SmartArt timelines for stakeholder kickoff decks. They show the "what and when" without overwhelming non-technical clients with Gantt chart detail.

Use PivotTable timelines to filter by date

PivotTable timelines are different from project timelines. They're a filtering tool, not a scheduling tool. If you have a table of tasks with dates, a PivotTable timeline lets you slide a date range filter to focus on specific months or quarters.

To set one up, create a PivotTable from your task data (Insert → PivotTable). Click inside the PivotTable, go to the PivotTable Analyze tab, and select Insert Timeline. Check the date field and click OK. A slider appears that lets you filter the table by months, quarters, or years.

This is useful when you're reviewing project data retrospectively. For example, filtering to see which tasks slipped in Q2 or how many deliverables were completed in a given month. It's not useful for building a forward-looking project schedule.

One scenario where PivotTable timelines genuinely add value: post-project reviews. If you've been tracking tasks and dates in Excel throughout a project, the PivotTable timeline lets you slice the data by time period to identify where delays clustered. That insight feeds directly into better time estimates for future projects.

Method

Best for
Setup time
Limitations
Stacked bar chart (Gantt)
Detailed task scheduling with durations
30–60 minutes
Complex setup, no dependency tracking
SmartArt
Milestone presentations for stakeholders
5 minutes
No durations, no task detail
PivotTable timeline
Filtering historical data by date range
10–15 minutes
Not a scheduling tool

Excel timeline templates: faster start, same limitations

In my experience, templates save teams real time on first builds, especially when the deadline is tomorrow. If building a timeline from scratch sounds like too much work, project timeline templates can save setup time. Excel includes a few built-in options (File → New → search "timeline"), and Microsoft's template library has additional free downloads.

Templates give you a pre-formatted structure to fill in. The tradeoff is less control over the layout and limited customization compared to building from scratch.

Skip the spreadsheet setup entirely

Build project timelines in minutes with templates, Gantt charts, and AI-powered scheduling, all in one platform.

Start free

Where Excel timelines break down (and the signs you've outgrown them)

In my years managing delivery before Teamwork.com, I watched teams defend their Excel project management setup long past the point where the spreadsheet was costing them more time than it saved. It's a pattern I still see across our customers today.

According to Teamwork.com's 6 Strategic Shifts for 2026 report, 33% of professional services teams say they experience derailed project timelines. And a huge contributor is the tools they're using to manage those timelines. Here's where Excel consistently breaks down.

Here's a quick contrast to make the gap tangible:

What most teams do with Excel timelines
What a purpose-built tool handles automatically
Email the file to five people, hope they update it
Everyone updates their own tasks in the same live view
Manually shift downstream dates when one task slips
Dependencies auto-adjust across the entire timeline
Create a new sheet for each project, copy-paste formatting
Clone a template and launch a new project in minutes
Chase team members for status updates via Slack
Automated notifications trigger when tasks are due or overdue
Guess at team workload based on memory
Workload views show real-time capacity across all projects
  • No real-time collaboration. Desktop Excel allows one editor at a time. Even with Excel Online, simultaneous editing creates merge conflicts in complex spreadsheets. When five team members need to update their task progress, the file becomes a bottleneck rather than a coordination tool.

  • Manual dependency tracking. Excel doesn't understand that "client approval" must finish before "begin design" can start. You track this in your head or with color-coded notes. When one task slips, you manually update every downstream date. On a 30-task project, that's an afternoon of rework every time a single deadline shifts. Tools with Gantt charts and dependency linking handle this rescheduling automatically.

  • Version control chaos. "ProjectTimeline_v3_FINAL_revised_ACTUAL.xlsx" isn't a joke, it's a reality I lived for years. When the timeline lives as a file attachment, nobody is ever sure they're looking at the latest version. I've sat in client meetings where two team members presented different versions of the same timeline. A cloud-based platform with project templates eliminates this by keeping one live source of truth.

  • Zero resource visibility. Excel shows you tasks and dates. It doesn't show you who's overloaded, who has capacity, or whether your designer is double-booked across three client projects next week. You only discover the conflict when someone misses a deadline. That's exactly why resource scheduling tools exist.

  • No automated alerts. Nobody gets notified when a deadline passes. You discover overdue tasks when a client asks for a status update, which is the worst possible time to find out.

At Teamwork.com, we see this tipping point play out with our customers regularly. Norwest Engineering, for example, was managing complex engineering projects in Excel before switching to Teamwork.com. The move gave them better collaboration and team adoption across projects that had simply outgrown what spreadsheets could handle.

What to look for when you're ready to move beyond Excel

What I've seen across professional services teams is that the evaluation question is almost never about features. It's about which tool actually reduces your coordination overhead. When the signs above start stacking up, the question shifts from "how do I make this spreadsheet better" to "what should I use instead." The evaluation comes down to five capabilities that Excel alternatives can't replicate in a spreadsheet.

Capability

Why it matters
What to look for
Real-time updates
Everyone works from one source of truth
Cloud-based platform with automatic saves and notifications
Dependency tracking
Downstream dates adjust when upstream tasks slip
Visual dependency linking with automatic rescheduling
Resource visibility
Prevents overallocation and burnout
Workload views showing capacity across projects
Collaboration
Team members update their own tasks directly
Per-task commenting, file sharing, and status updates
Templates and automation
Repeatable project structures set up in minutes
Project templates with pre-built task lists and timelines

Don't evaluate tools based on feature lists alone. What I recommend, and what we see work across Teamwork.com customers, is running a real project through the trial. Set up your most common project type, invite two or three team members, and see whether the tool reduces your coordination overhead within the first week.

Here's a simple three-step evaluation process that works:

  1. Pick your most representative project. Choose a client engagement that reflects your typical complexity: 20 to 40 tasks, 3 to 5 team members, and at least a few task dependencies.

  2. Set it up in the trial. Rebuild the project in the tool, assign team members, and link dependent tasks. Time how long this takes compared to your current Excel setup process.

  3. Run it for one full week. Have team members update their tasks, log time if applicable, and use the tool's built-in communication features. At the end of the week, compare how much time you spent on timeline maintenance versus your typical Excel week.

In my experience, teams that follow this process make a confident decision within two weeks. The ones who skip it end up switching tools again six months later.

Pro tip

Start your evaluation with your messiest project. Teamwork.com's Workload Planner shows you capacity gaps that spreadsheets hide, and you can test it with real projects during a free trial.

How Teamwork.com replaces Excel timelines for client work

One of the reasons we built Teamwork.com the way we did is because we wanted to eliminate wasted setup time for our customers, and give them a system that actually keeps pace with how client work changes.

Here's what that looks like in practice.

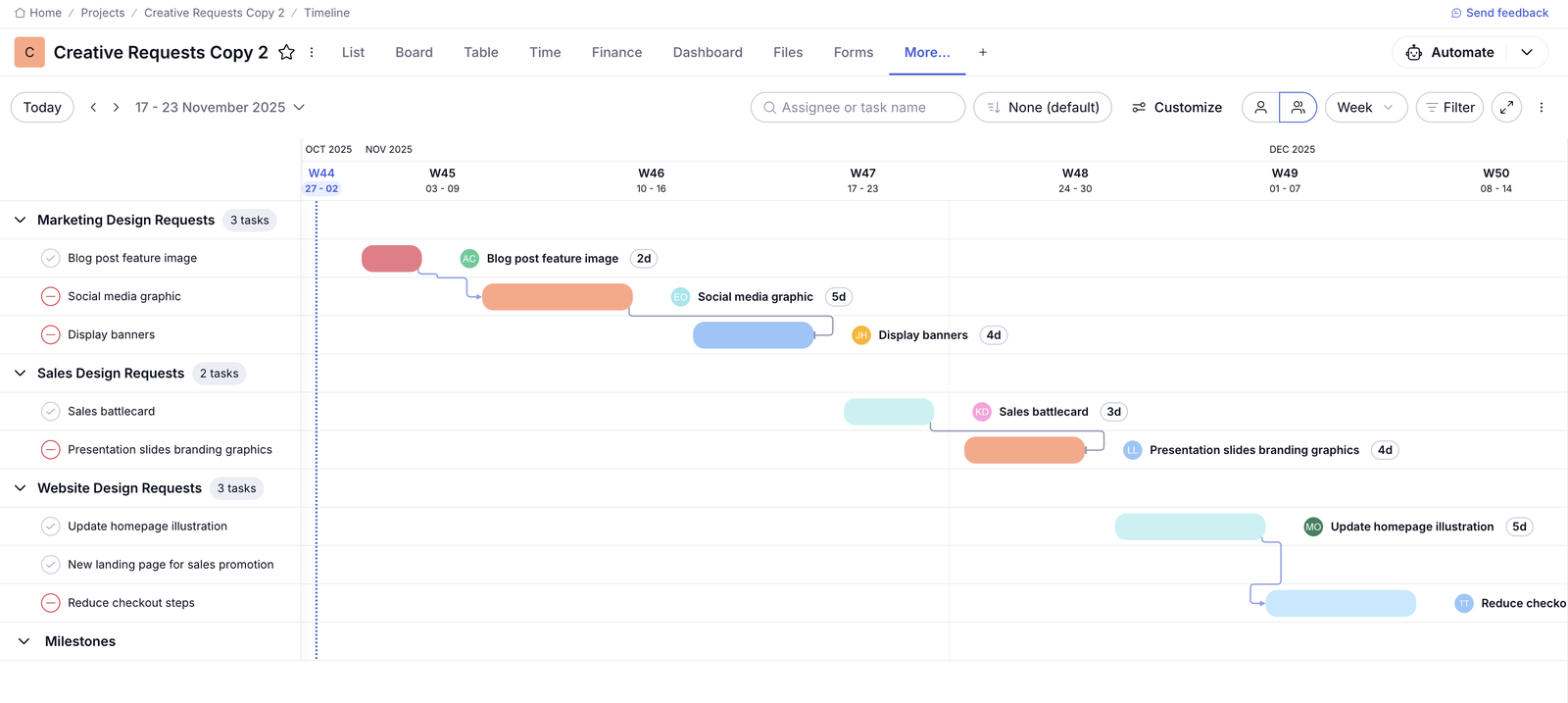

Get a visual timeline that automatically adjusts when dates shift. Gantt charts with dependencies let you drag a task to reschedule it and link dependent tasks so downstream dates update in real time. No manual formula recalculation required. This is exactly what we built at Teamwork.com to address the manual rework that eats up delivery leads' time.

Blog post image

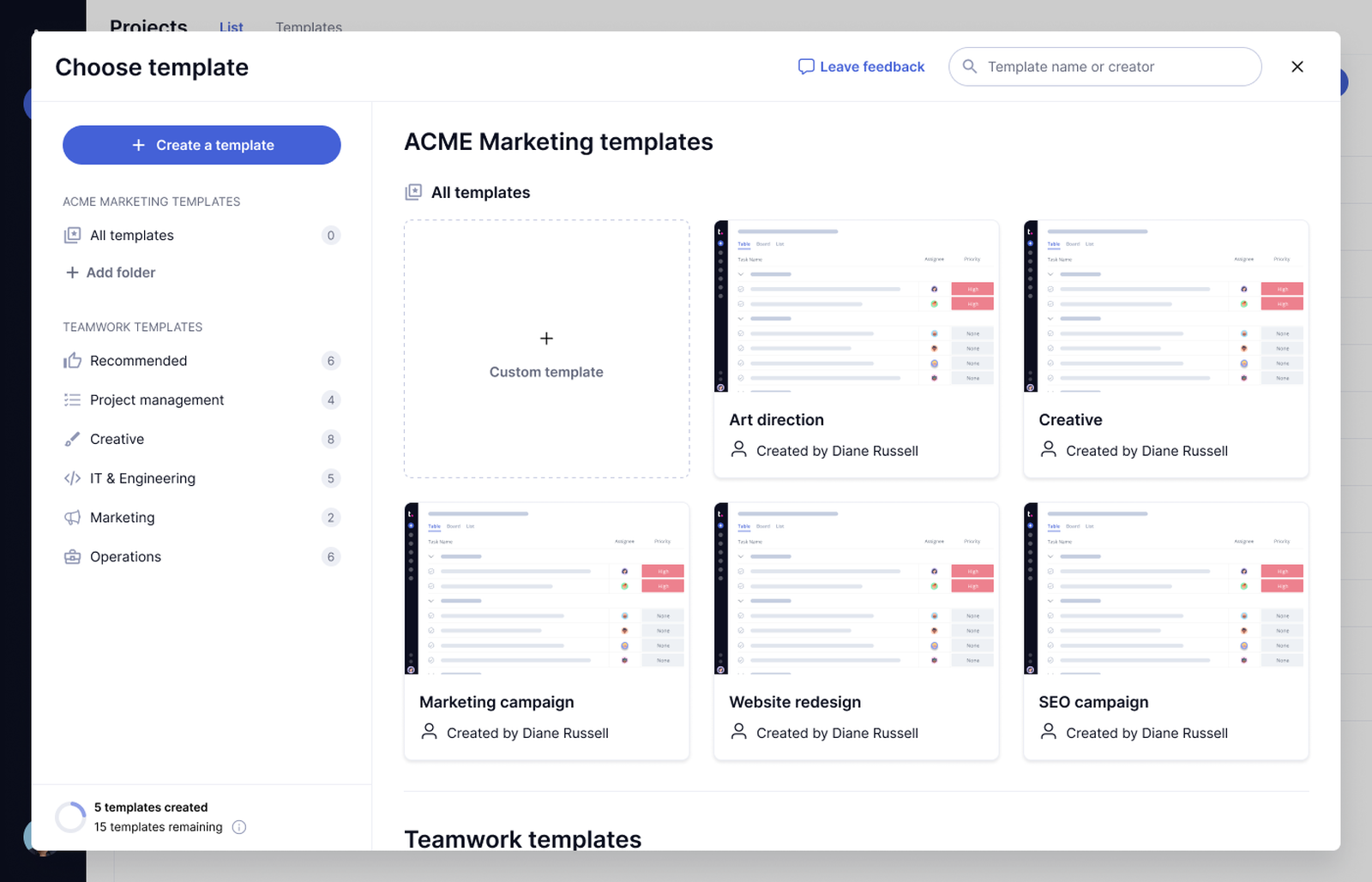

Stop rebuilding your client onboarding timeline from scratch every time. Project templates let you save your most common project structures and reuse them. Clone a template and customize it in minutes. One pattern we see across Teamwork.com customers: teams that invest 30 minutes in a proper project template save hours of rework on every project that follows.

Blog post image

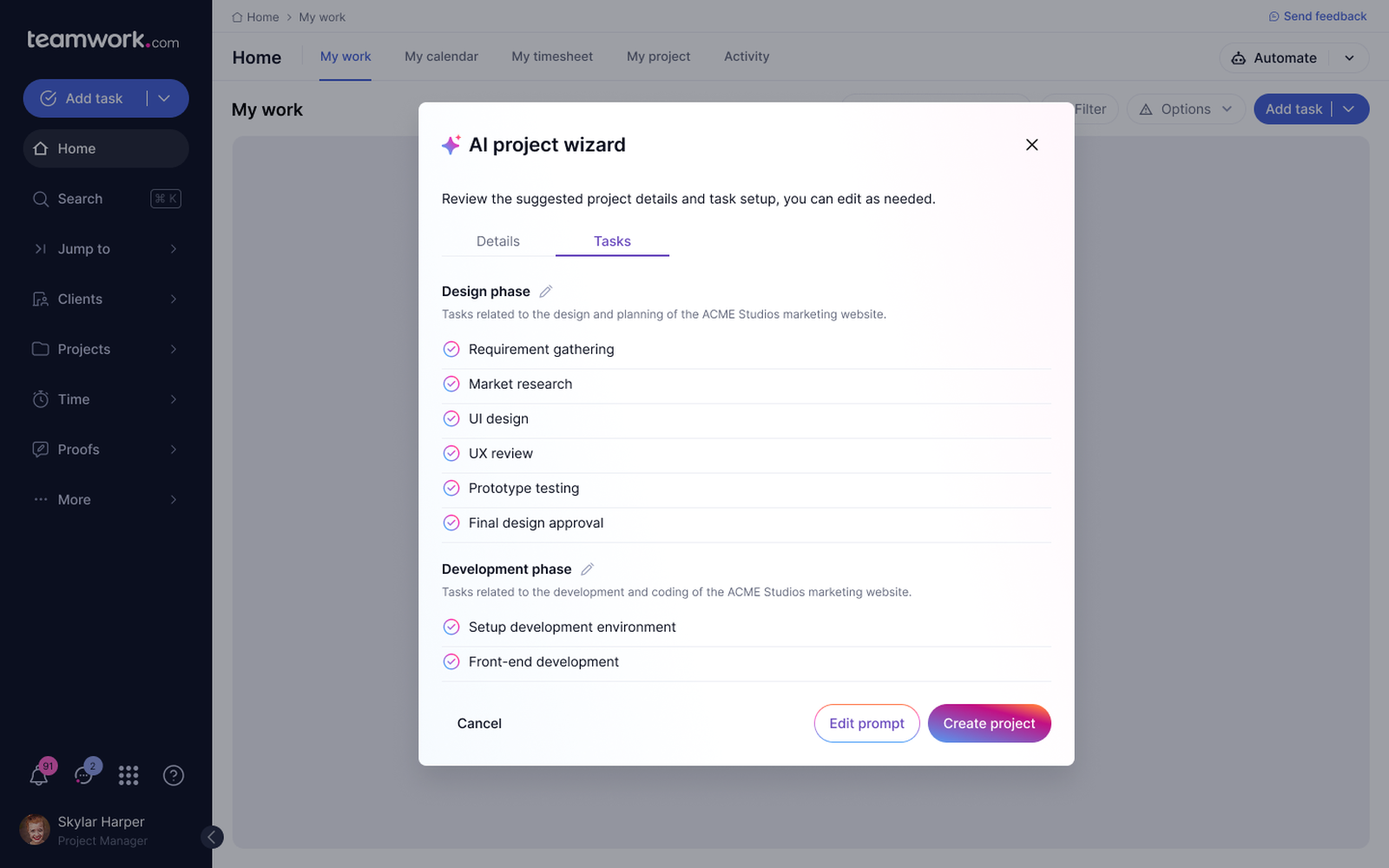

Go from brief to full project plan in minutes. The AI Project Wizard generates tasks, milestones, and suggested timelines from a pasted client brief. It's how we help teams get from "we won the work" to "the project is set up" without staring at a blank spreadsheet trying to remember what tasks they used last time.

Blog post image

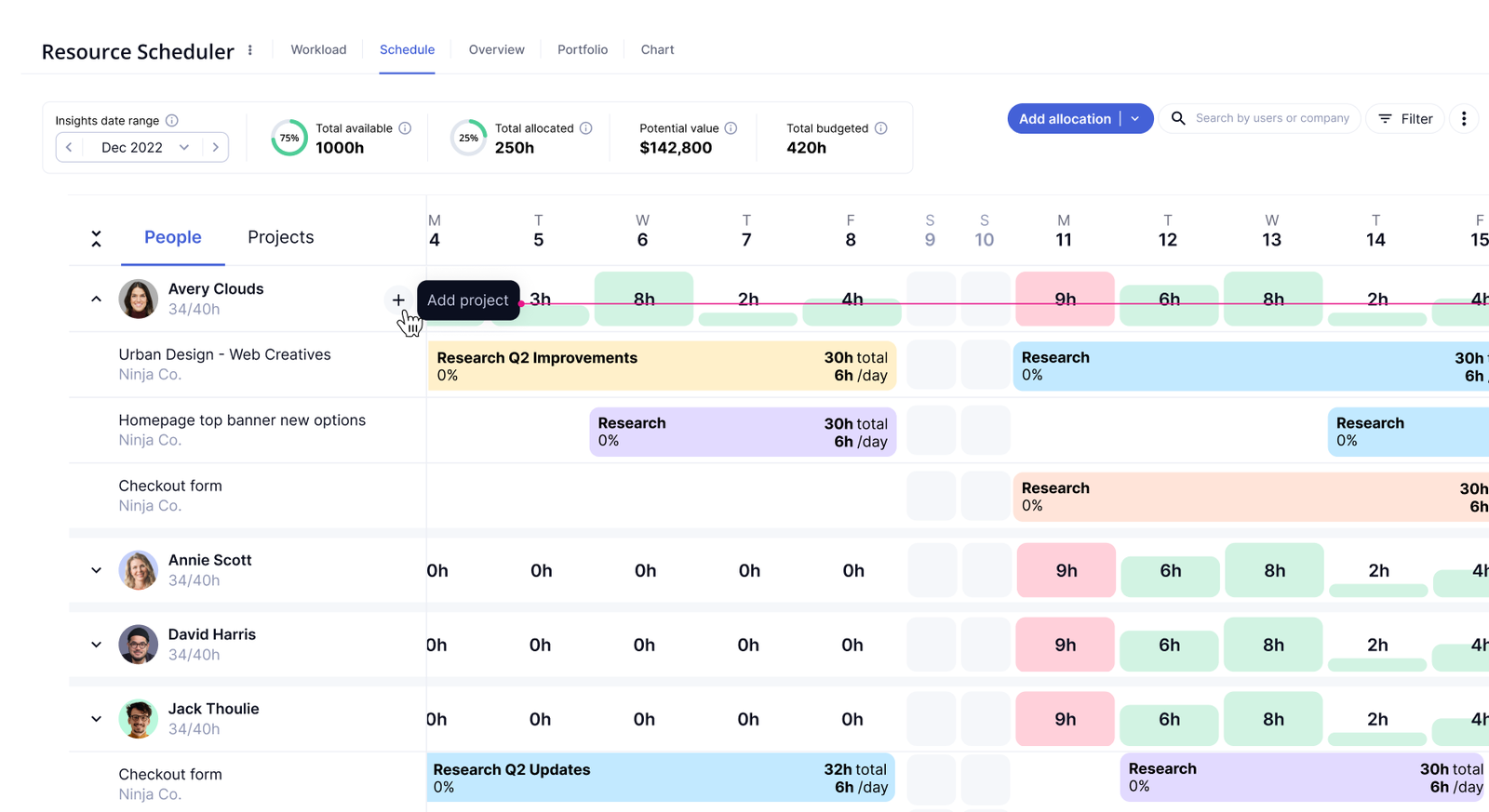

See who's available, who's overbooked, and where capacity exists across your entire team. Resource scheduling gives you that visibility months in advance. This is what prevents the burnout and missed deadlines that come from guessing at workloads. You can see tentative bookings alongside confirmed work and model different scenarios before committing.

Blog post image

Spot imbalances before they turn into missed deadlines. The Workload Planner shows each team member's real-time capacity at a glance. You can see whether assigning a new task will push someone past their limit, and redistribute work before it becomes a problem. I check it every Monday to catch overallocation early.

Blog post image

See how Teamwork.com replaces your Excel timelines with collaborative Gantt charts, templates, and AI-powered scheduling.
Start free

FAQ

Does Excel have a project timeline template?

Yes. Excel includes a few built-in timeline templates that you can find by going to File → New and searching for "timeline" or "Gantt chart." Microsoft's online template library also offers free downloads. These templates give you a pre-formatted starting point, but they're static and require manual updates for any changes to dates or task order.

How do I create a Gantt chart timeline in Excel?

You build it using a stacked bar chart. Set up a data table with task names, start dates, end dates, and durations. Insert a 2D stacked bar chart, add the duration data series, then format the chart by hiding the start date bars and reversing the task order. The full step-by-step process is detailed in the stacked bar chart method section of this guide.

What are the limitations of using Excel for project timelines?

The biggest limitations are the lack of real-time collaboration, no automatic dependency tracking, manual update requirements, and zero resource visibility. For simple projects with fewer than 15 tasks and a single owner, Excel works fine. Once you have multiple team members, task dependencies, and client deadlines, the maintenance overhead outweighs the convenience.

What is the difference between a project timeline and a Gantt chart?

A project timeline is any visual representation of tasks and deadlines in chronological order. A Gantt chart is a specific type of timeline that uses horizontal bars to show task durations, start and end dates, and dependencies between tasks. In Excel, a SmartArt timeline shows milestones only, while a stacked bar chart timeline functions as a basic Gantt chart.

How do I track project progress in Excel?

Add a "Status" column to your task table with values like "Not started," "In progress," and "Done." Use conditional formatting to color-code cells based on status. You can also add a "% Complete" column for more granular tracking. The downside is that every update is manual: you or your team members must open the file and update the status for each task individually.

Can Excel handle task dependencies for project timelines?

Not natively. Excel doesn't have built-in dependency logic. It can't automatically adjust downstream dates when an upstream task slips. You can simulate dependencies using formulas (setting a task's start date equal to the previous task's end date plus one day), but this approach is fragile. Inserting or deleting rows can break the formula chain. There's no visual indicator of which tasks depend on which. For projects with more than a handful of dependencies, purpose-built project scheduling tools handle this automatically.
