Margin control for professional services: the ops system that protects delivery profit

Blog post image

Margin control: Summary & Key Takeaways

  • Margin control is an ops practice: It is the weekly system that keeps project revenue, delivery cost, and variance visible while work is still running, not a month-end spreadsheet rebuild.

  • The Margin Control Loop has four gates: Baseline, Signal, Intervene, and Learn. Each gate has an owner, a threshold, and a decision, so margin problems get handled mid-delivery.

  • Late visibility is the real failure mode: Most firms do not lose margin in one dramatic decision. They lose it in delayed timesheets, absorbed scope, and staffing choices that never touch a live cost rate.

  • Billing model changes the control levers: Fixed-fee work needs phase burn control. T&M needs realization and write-off discipline. Retainers need over-servicing limits.

  • Tools only help when data is connected: Time, cost rates, budgets, and staffing have to live in one operating view. Fragmented stacks hide the signal until the P&L is already red.

Margin control is not a finance vocabulary quiz. In professional services, it is the operating system that decides whether a client project still pays for itself while your team is still delivering it.

I spent years on the delivery side of agencies watching "healthy" projects quietly bleed. The decks looked fine, the status calls sounded fine, and then finance closed the month and the delivery margin was gone. At Teamwork.com, one reason we connect projects, resources, and financials in one agentic PSA is that control has to happen in the same place the work happens.

If you searched "margin control" and landed in ERP sales-order rules, trading collateral, or page layout settings, you are in a different universe. This guide is for client service ops: the people who price work, staff it, track it, and still own the number when the invoice goes out.

What margin control actually means for client delivery

I still hear "margin control" used as if it were a month-end formula. In client delivery it is an operating practice: you set a defendable project margin at kickoff, watch live cost and revenue against that baseline, and intervene before the final invoice is the first honest report.

It is related to project profitability, but it is not the same thing. Profitability is the outcome. Control is the system that protects the outcome while you still have moves left.

If you need the definition stack (gross margin, delivery margin, realization, and the rest), start with our guide to project profitability metrics every agency should track and pair it with the agency profit margin glossary entry. This article will not re-teach the formulas. It will teach the operating rhythm that makes those formulas useful mid-week, not mid-postmortem.

Why you only see the damage after the budget is gone

The pattern I keep seeing across mid-size services teams is not a missing calculator. It is a delayed operating picture. Time lands in one tool, staffing lives in a spreadsheet, budgets sit in finance, and nobody owns the live margin number until someone rebuilds it after the fact.

That lag is expensive in 2026. In Teamwork.com's 6 Strategic Shifts for 2026 research with senior leaders in client service businesses, 66% say clients are now more demanding but less willing to pay for work. When expectation rises and willingness to pay does not, every hour of invisible cost becomes a commercial problem, not just an admin problem.

The same research found 27% say clients moving the budget mid-project is their top frustration. If your control system only updates when the budget has already moved and the work is already done, you are always negotiating from a weaker position.

Here is the failure shape in plain numbers. A fixed-fee engagement is sold at $80,000 with a 35% target delivery margin, so direct delivery cost should stay near $52,000. By week six, the team has burned 60% of planned hours while only 40% of scope is complete, because senior people covered junior gaps and two "quick" client requests never became change orders. Nobody sees the projected final cost until timesheets catch up two weeks later, and by then the remaining work still needs the expensive people and the margin target is already fiction.

I have sat in those recovery meetings. The conversation stops being about craft and starts being about who absorbs the hit. That is not a culture problem first. It is a control problem first.

That is why I treat margin control as a client service ops job, not a quarterly finance ritual. Finance still owns the chart of accounts. Ops owns whether the delivery machine is allowed to run blind.

The commercial pressure is not abstract. When 33% of leaders say clients are more convinced they can do jobs themselves using AI (same 2026 research), your internal cost discipline becomes part of how you prove value. You cannot defend price if you cannot defend delivery economics in real time.

The Margin Control Loop: four gates that keep profit alive mid-delivery

If you only remember one thing from this guide, make it this: margin control is a loop, not a report. I call it the Margin Control Loop. Four gates. Every live client project runs through them on a weekly cadence. Skip a gate and you are back to hoping the P&L is kind.

Gate

Question it answers
Owner
Default threshold
Decision if breached
Baseline
What margin are we defending?
Ops + sales/delivery lead
Target GM set before kickoff
Do not start without costed plan
Signal
Are we still on that path?
PM + ops
50% and 75% budget burn checks; projected margin floor
Escalate same week
Intervene
What do we change now?
Ops + resourcing
Staffing mix, scope, timeline, or commercial path
One named action within 5 business days
Learn
What does the next quote inherit?
Ops + estimating
Estimate vs actual by phase
Update rate card or template assumptions

Gate 1: Baseline (the number you defend)

Before kickoff, lock three things: sold revenue, costed delivery plan, and target margin. Cost rates have to be real internal costs, not bill rates wearing a costume. If the baseline is a vibes-based spreadsheet, every later signal is noise, and teams that skip this gate spend the project arguing about whether the original number was ever serious.

Gate 2: Signal (live variance you can act on)

Signal is where most "profitability programs" die. You need budget consumed versus progress, projected final cost, and margin at completion updating as time and expenses land. I want phase-level burn, not only project-level totals, because a project can look fine in aggregate while one phase is already underwater. That is the week you still have options.

Gate 2 fails in predictable ways. People track tasks and call it control, track revenue and call it control, or track utilization and call it control. None of those alone answers "are we still on the sold margin path?" You need the join between progress, cost, and commercial structure.

I also want explicit owners. If "everyone watches the dashboard," nobody watches the dashboard. PM owns the project signal, ops owns the portfolio sort and the intervention standard, and finance partners on definitions. That split keeps the loop from turning into another shared drive nobody opens.

Gate 3: Intervene (ops moves, not post-mortems)

Intervention is not a stern Slack message. It is a concrete move: re-staff to the lowest capable cost rate, freeze non-critical scope, open a change order, pull timeline, or stop work that is clearly non-billable theater. The rule I use is simple. If a signal trips a threshold, someone names the intervention within five business days. No intervention means you accepted the new margin in silence.

Worked example for Gate 3: projected margin on a $120,000 fixed-fee build drops from 38% to 24% because design is over on hours and engineering is about to staff two seniors for a stretch a mixed team can finish. Intervention options include reassigning one senior, moving a non-critical module to phase two with a change order, or accepting the lower margin with an executive sign-off. What is not an intervention is "we will try harder." Hope is not a control lever.

Gate 4: Learn (feed actuals into the next quote)

Control without learning just makes you faster at repeating the same miss. Compare estimate versus actual by phase. If integration always overruns by 15%, the next baseline has to carry that truth.

This is also where AI forecasting earns its keep, not as magic, but as a faster read on staffing risk. When the signal is connected to actual delivery data, prediction stops being a separate finance hobby.

Pre-start forecasting still matters. If you need the five-step method for predicting margin before you commit, use how to forecast project profitability before work starts. Margin control does not replace that work. It keeps the forecast honest after kickoff, when reality starts rewriting the plan.

The same is true for broader project financial management. That playbook covers the financial operating model, and this article is the weekly control loop inside it. Link out when you need the full financial stack. Stay here when you need the ops cadence that stops late surprises.

The numbers that matter when you are controlling margin (not just reporting it)

I only trust a short control set that changes behavior the same week. You do not need twenty KPIs on a vanity dashboard.

Control metric

What it tells you mid-delivery
Practical tripwire
Target vs projected delivery margin
Whether the sold economics still hold
Projected margin drops below your sold target floor
Budget burn vs % complete
Whether cost is outrunning progress
50% budget used at under ~35-40% complete
Billable utilization on the assigned team
Whether capacity is producing revenue
Sustained dips below your planned band
Estimate at completion (EAC)
Where cost is heading if nothing changes
EAC exceeds baseline cost by more than ~10%
Unapproved scope / change-order lag
Whether free work is eating the baseline
Any client request in delivery with no commercial path after one week

For formulas, benchmarks, and deeper metric design, stay on the metrics guide linked above and financial project reports. The control question is simpler: which two numbers would force a staffing or scope conversation this Thursday?

Utilization deserves a special note. High utilization with the wrong cost mix can still destroy margin, and low utilization with perfect timesheet hygiene still starves revenue. Pair utilization with projected margin or you will "win" the wrong game. If you want a quick benchmark helper, I point teams at the utilization rate calculator as a planning check, not a substitute for live project cost.

Fixed-fee, T&M, and retainer: how the control system changes

People ask for one universal margin dashboard. Billing model decides which levers actually move.

Model

Primary control risk
Signal to watch hardest
Default intervention
Fixed fee
Cost overrun on locked revenue
Phase burn vs progress; EAC
Re-staff, descope, or commercial change
Time & materials
Realization and write-offs
Billable mix, unbilled time, discounting
Approval gates before write-down
Retainer
Over-servicing against a monthly box
Hours vs retainer cap; scope creep inside the box
Explicit out-of-scope path and hour fences

I am blunt about fixed fee: it is where weak control looks like heroics. The team "just gets it done," finance smiles at revenue, and delivery margin quietly dies. T&M fails differently, because revenue can look strong while write-offs and slow approvals hollow the realized number. Retainers fail when the monthly relationship becomes an unlimited service desk.

For the commercial model tradeoffs in more depth, use retainer vs project profitability. Here the point is control design: match the gate thresholds to how money is earned.

Where margin control breaks (and the ops fix for each break)

I can usually name the break before I open the dashboard. The pattern repeats across services teams.

Scope that never becomes a line item

The classic break is familiar. A "tiny" request lands in chat, someone does the work to keep the client happy, and the baseline never changes. If you need the full process for locking scope and change control, read how to handle scope creep and protect your margins. The control fix is simple and non-negotiable: no delivery effort without a home in the budget structure.

Senior people doing junior work because they were free

Availability is not a cost strategy. When a senior consultant covers a mid-level task for two weeks, you can still hit the deadline and miss the margin by a wide margin. Ops owns the mix. Signal the cost rate impact the same week the assignment changes.

Timesheets that arrive after the damage

If time is a month-end archaeology project, Gate 2 is dead. Late time is not a personality flaw in your team. It is a system design failure. Make logging easy, remind automatically, and block billing milestones that depend on approved time. If billable capture itself is broken, fix that foundation with a tighter process for tracking billable hours before you blame the margin report.

Change orders tracked as vibes

A change order that lives in email is not a change order. It needs its own budget line, revenue path, and cost tracking. Otherwise you will "approve" work while the original margin still carries the weight.

The fix is not more heroics from delivery. The fix is earlier commercial structure around the work that is already happening.

Spot margin risk before the last 10% of delivery

Connect time, staffing, and budgets so projected margin updates while you can still intervene.

Start free

A practical weekly rhythm for client service ops

Frameworks fail when they stay on a wiki page. Here is the cadence I want running every week.

Monday: portfolio signal scan (about 30 minutes)

Review every active client project against the Margin Control Scorecard: projected margin, burn vs progress, open change-order lag, and staffing cost flags. Sort by risk, not by favorite client.

Midweek: intervene on the top three risks

Do not boil the ocean. Pick the three projects with the worst projected margin movement, name one intervention each, assign an owner, and write the decision where delivery and ops both see it.

Friday: learn and reset baselines for anything that changed

If scope, staffing, or commercial terms moved, update the baseline the same week and carry estimate-vs-actual notes into the next quote template. This is also when I glance at capacity for the following week so Monday is not a surprise fire drill.

When you want a simple starter structure for the scorecard data, the project profitability tracking template and budget vs actual tracker are practical shortcuts. Templates do not replace the loop. They remove the excuse that you needed a perfect system before starting.

If you are building the scorecard for the first time, keep columns boring. Capture project name, billing model, target margin, projected margin, burn %, complete %, open change requests, next intervention, and owner. Colour is optional. Clarity is not.

The honest part of weekly rhythm is political. Someone will push back on a change order, someone will want to "just finish it," and your job in ops is to make the cost of that choice visible the same week, not after the credit note. For teams that still sell work without a costed plan, start smaller: run the loop on the ten largest active projects for four weeks, prove the interventions, then expand. A perfect portfolio process that never launches is still a spreadsheet fantasy.

Tool categories that support margin control (without another spreadsheet)

I have watched teams buy another reporting layer and still miss margin by a week. You do not need a twelve-tool beauty pageant. You need coverage across the loop.

Category

What it should control
Failure mode if used alone
Delivery workspace
Tasks, milestones, progress
Progress without cost
Time and expense capture
Actual effort and direct cost inputs
Hours without rates or budgets
Resourcing
Who is assigned at what cost and capacity
Availability without margin impact
Project financials / PSA layer
Budgets, margin, forecasts, billing handoff
Finance numbers disconnected from delivery
Reporting layer
Portfolio risk views
Pretty charts fed by stale exports

Generic task tools fail Gate 2 because they were never built to hold money. Traditional PSA tools can hold money and still fail if the delivery team refuses to live in them, so the inputs rot. The category case for an agentic PSA built for cost and profitability is boring on purpose: resourcing, financials, and delivery have to share one truth or the loop collapses.

I will not re-run a full software listicle here. If you need tool comparisons, use the existing Teamwork roundups on project profitability software and tools to track projects and profitability. This guide stays on the operating system those tools should serve.

Before you buy anything new, write down which gate is broken. Most stacks fail Gate 2 because time and cost never meet, some fail Gate 1 because quotes ignore internal cost, and some fail Gate 3 because risk is visible and nobody has authority to re-staff. Buying another reporting layer on top of a broken gate usually adds noise.

Also watch for the false economy of the Frankenstack. The same Sprint to AI research found 58% of leaders use 3-5 separate tools to get work done, and 92% say current tech falls short. Data management and reporting sit among the top gaps. More tools without a single operating picture is how margin stays invisible while everyone feels busy.

How Teamwork.com turns the Margin Control Loop into daily work

I judge margin software on one test: can a delivery lead and an ops lead see the same risk without exporting three CSVs?

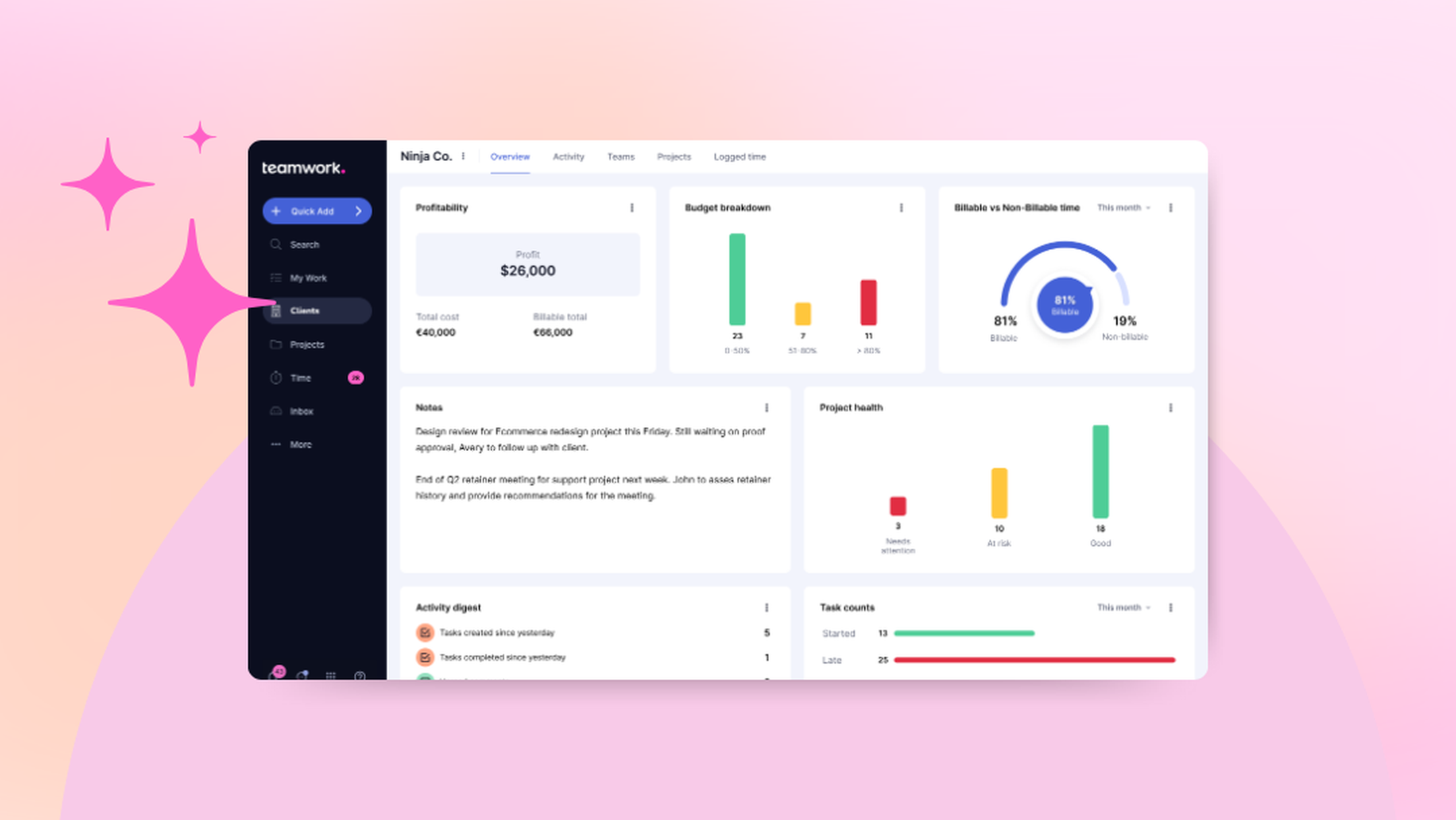

Budgets and live profitability tied to delivery

See cost and margin move as work happens. Budgeting and profitability views keep Gate 2 honest instead of waiting for a finance rebuild.

Blog post image

When OIC Advisors gained 360° visibility across active projects, they spent far less time manually generating reports. That is the point. Control dies when the picture is two weeks late.

Time that actually feeds cost

Require time against the work, then multiply by real cost rates so burn is not a guess. Time tracking timers, timesheets, and reminders exist to protect Gate 2, not to feed a compliance ritual.

Blog post image

Workload and utilization with commercial context

Balance who is overloaded before you "solve" a deadline by throwing expensive people at cheap work. Capacity planning and the Workload Planner are where I catch the staffing decisions that quietly rewrite margin.

Blog post image

AI that shortens the loop without inventing numbers

Let AI surface capacity and forecast risk from your own actuals. Teamwork AI features like the AI Utilization Summary and AI Forecaster help Gate 3 and Gate 4 when time and cost data is clean. They do not replace the baseline. They make the next intervention faster.

Blog post image

Quotes that start with margin visibility

Start the loop before delivery. Quoting and costing with margin visibility turns sold work into a baseline you can defend, then converts into a live project without re-keying the commercial story.

Blog post image

SugarCRM unified projects, time tracking, and billing and reached near-perfect invoicing accuracy: less than $20K credited on $10M+ in annual invoicing. That is what connected quote-to-cash looks like when control is not a side spreadsheet.

I am not going to pretend software alone creates discipline. If nobody owns Gate 3, the prettiest dashboard is decoration. What software can do is remove the honest excuse that the data was too hard to assemble in time to act.

Product mentions outside a dedicated tools section only work when they answer a gate. Budget alerts support Signal, workload views support Intervene, quote margin supports Baseline, and AI forecast supports Learn. If a feature cannot map to a gate, it is decoration in a margin control article.

One more practitioner note: AI Teammates and AI utilization signals help when the inputs are trustworthy. If timesheets are fiction, the forecast will be confident fiction. Clean the capture first. Automate second.

Run client delivery with projects, resources, and financials in one place.
Start free

FAQ

What is margin control in professional services?

Margin control in professional services means setting a target project margin, watching live delivery cost and revenue against it, and intervening while the project is still running. It is not limited to ERP sales-order price floors or trading collateral rules.

How do you track margins across multiple projects?

Track margins across projects with one shared definition of revenue and direct cost, real cost rates on people, weekly projected margin by project, and a portfolio view sorted by risk. Centralize time and expenses into the same system that holds budgets so you are not reconciling three exports every Friday.

How do you calculate project margin?

Calculate project margin as (project revenue − direct project costs) ÷ project revenue × 100. Direct costs usually start with labour at internal cost rates plus project expenses. For net views, allocate overhead carefully and keep the method consistent across the portfolio.

What is a healthy project margin for agencies and consulting firms?

Healthy margin depends on which margin you mean and how you allocate overhead. Teamwork.com's project profitability metrics guide (linked earlier) puts typical agency gross or delivery margin nearer the 50-60% range and net profit margin nearer 10-20%, with the right target varying by model, seniority mix, and service line. Treat those ranges as orientation, then set tripwires against your own sold baseline. A "good" percentage on a tiny project can still be a weak business outcome if total profit is negligible.

What is the difference between project profitability and project margin?

Project profitability is the absolute profit in currency. Project margin is the percentage of revenue kept as profit. You need both: margin shows efficiency, profitability shows financial impact. A high-margin micro-project can matter less than a lower-margin flagship engagement.

Why does project margin slip late in delivery?

Project margin often slips late because cost signals arrive after staffing and scope decisions are locked, timesheets lag, and change work is absorbed into the original budget. Teams then throw senior capacity at unfinished work to hit a date. Late slip is usually early blindness wearing a calendar.
