Agency financial management: summary & key takeaways
The discipline: Agency financial management connects pricing, budgeting, resourcing cost, billing, and forecasting across every client and project.
The core problem: Margin rarely disappears at month-end. It leaks earlier, at five predictable points between the quote and the cash.
The framework: The Agency Margin Leak Map pinpoints those five leaks so you can see and stop them while there's still margin left to protect.

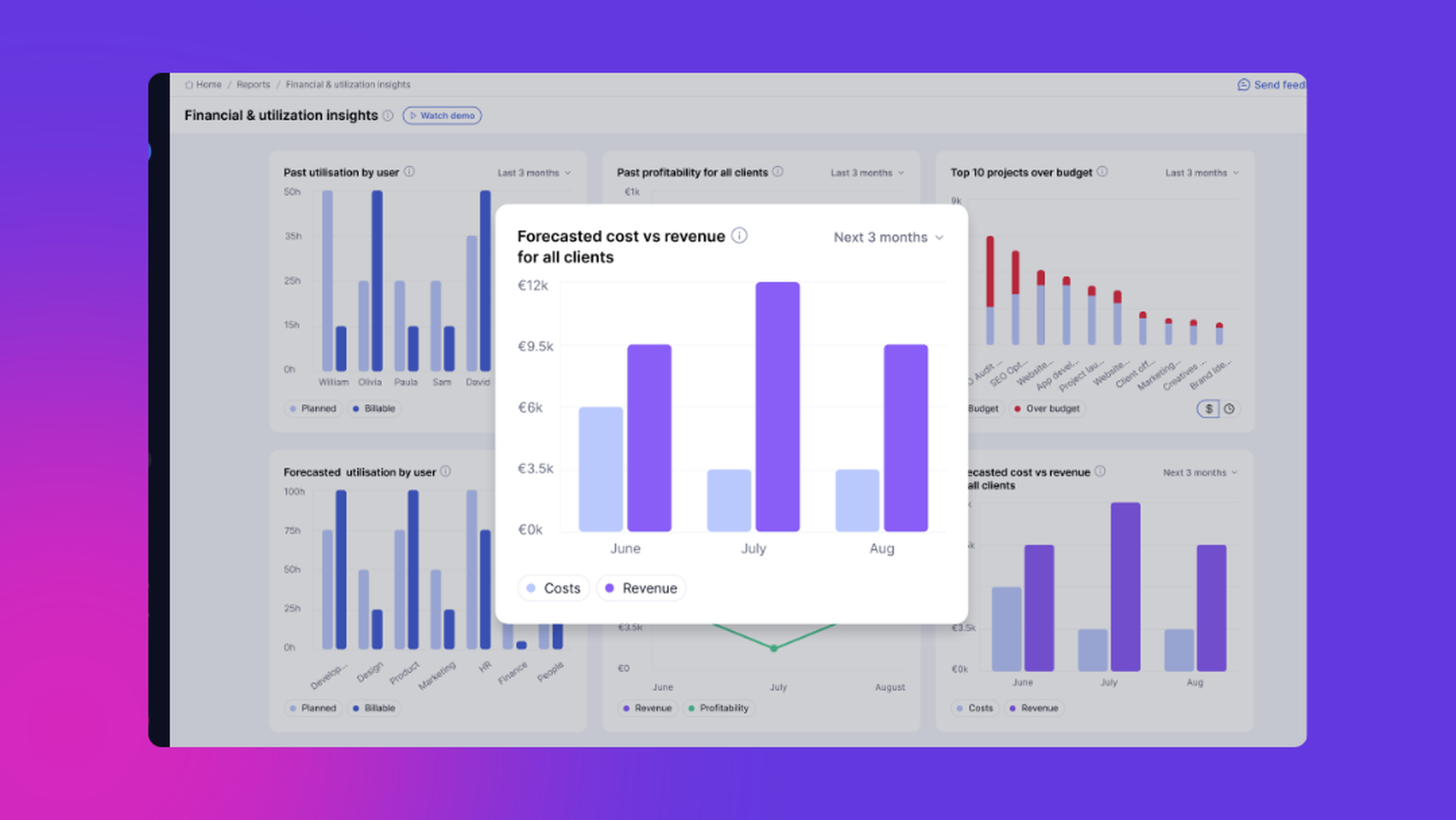

The numbers that matter: Billable utilization, rate realization, project and client margin, work in progress, and forecast variance show where you stand.
The fix: Connect project data to financial outcomes as delivery happens, so your decisions are live instead of a post-mortem.
Most agencies don't have a profitability problem. They have a visibility problem that turns into a profitability problem three weeks later. The money looked fine at kickoff and fine at the mid-point check-in. Then the project somehow closed five points of margin light.
I saw this happen on my own accounts more often than I'd like. This guide breaks down what agency financial management involves, where your margin quietly escapes, and how to catch it in time.
What agency financial management actually covers
Many agency leaders only find a margin problem after the invoice goes out, because pricing, staffing, and billing all live in different places. That gap is what this discipline closes.
Agency financial management is the practice of connecting how you price, budget, staff, bill, and forecast work. Done well, you see the true margin on every client and project as it happens. It's broader than budgeting a single job, and it's not the same as bookkeeping. Your accountant records what already happened; financial management is about the decisions you make before the invoice.
Think of it as five moving parts that have to talk to each other. You price the work, set a budget and staff it, track cost and time as it burns, bill and recognize the revenue, and forecast what's coming. When those five live in one connected picture, you can see a problem forming. When they live in five separate places, you find out at the end.
For example, take a retainer client who also asks for a one-off campaign on time and materials. This discipline tells you whether the retainer scope still fits the fee and what the campaign should cost to stay above target margin. It also tells you whether the people you'd assign are already overbooked. Bookkeeping tells you all of that long after the decision that mattered.
In most agencies this doesn't sit with one person, which is part of the problem. The account lead owns the quote, a project manager owns the budget, delivery leads own the hours, and finance owns the invoice. Each holds one piece of the picture, and no single view stitches them together.
I spent years in professional services watching those worlds sit in separate systems. Nobody could answer a simple question like "are we making money on this account?" until the quarter had already closed. Closing that gap with connected financials is one of the reasons I joined Teamwork.com.
If you want the project-level mechanics, our guide to project financial management covers the single-project view in depth. And if you need the baseline definition of the outcome you're chasing, agency profitability lays it out.
Why agencies lose margin they never see
Here's the uncomfortable truth about how agencies lose money: it almost never feels like a crisis. There's a small scope addition here, an unlogged revision there, an invoice that goes out two weeks late. Individually, none of it trips an alarm. Collectively, it's your entire margin.
Picture a fixed-fee project quoted at 40 hours. A round of "quick" extra revisions adds six hours, and a senior covers work a mid-weight was meant to handle, quietly raising the cost per hour. A few hours get logged a week late and never reach the client conversation. Together they can turn a 30% margin into a 12% one, and nobody ever decided to give away 18 points.
That's the pattern: budget overruns happen slowly, and then all at once. The reason they stay invisible is structural. The warning data lives in one place, the budget lives in a spreadsheet, and your finance lead hand-assembles the profit number once a month. By the time those three things meet, the work is done.
Data point: In Teamwork.com's 6 Strategic Shifts for 2026 research, 27% of services leaders said clients moving budget mid-project is their single biggest frustration. Another 66% said clients are now more demanding while being less willing to pay.
Those two numbers describe the squeeze every agency is in. Clients want more, faster, for less, and they change their minds mid-flight. AI is compressing delivery timelines too, so the window to spot a problem is shorter than it used to be. When your finances can't keep up in real time, the gap between plan and delivery becomes margin you'll never bill for.
The agency margin leak map: five places your money escapes
If margin leaks slowly and invisibly, the fix is knowing exactly where the leaks are. The same five leaks show up again and again. I call it the Agency Margin Leak Map. Walk your own agency through it and you'll usually find money escaping at two or three of these points.
Leak one: quote from history, not guesswork
Too many quotes get built from memory instead of actuals. Someone estimates the hours it "should" take, applies a rate, and sends it. Nobody checks what a comparable project actually cost last time, because that data is buried in closed timesheets nobody reopens. So the same underpriced job gets quoted again and again.
The fix is to price from actuals. Every quote should start with the real cost of the last two or three jobs like it, including the revisions that always happen. The pricing model matters less than the number being grounded in real cost. That grounding is exactly what a disciplined quoting and costing workflow enforces.
For example, say you quote a website build at 100 hours from the last one you remember. Similar jobs often run 15% to 40% over that remembered estimate once revisions land. Pricing from the real range is the difference between a healthy margin and a write-off. A pricing mistake also repeats on every future proposal until someone catches it.
The model you choose shapes where the risk sits. Fixed fee puts overrun risk on you, so it only works when your estimates are grounded in real history. Time and materials shifts that risk to the client but demands airtight time capture to bill fully, while retainers smooth revenue but quietly absorb scope unless you track period by period. None of these is safer than the others on its own; what makes any of them profitable is pricing from actuals and watching the burn once work starts.
Leak two: capture scope changes as they happen
Small extra requests quietly erode fixed-fee margin when nobody logs them, which makes this the leak nobody writes down. The fix is a lightweight change-order habit, not a bureaucratic one. When a client asks for something outside the original scope, log it against the project the moment it lands, even if you decide to absorb it. Do that and you can see how much "free" work a client is really getting, and you have the evidence to reprice the next project.
Leak three: the gap between what people cost and what you bill
Every person on your team has a cost rate and a bill rate, and the space between them is your margin. I've watched a blended utilization average hide the exact people who were losing money. A single agency-wide figure of 75% can easily contain someone sitting at 45%.
You close this leak by looking at utilization and realized rate per person and per project. If you want to benchmark where you stand, our billable utilization rate calculator is a quick way to pressure-test the number you think you're hitting.
Here's how quickly it adds up. When a delivery role costs one rate and bills at a much higher one, rework wipes out margin fast. Ten non-billable hours across a quarter, spread over a team, is real money. It never shows up as a line item, so it just lowers the margin on jobs you thought were healthy.
Leak four: bill for the work you actually deliver
Nothing stings more than paying for work you never invoice. I've found delivered hours sitting unlogged for weeks, retainers quietly absorbing out-of-scope requests, and pass-through costs that never reach a bill. Every one of those is revenue you earned and gave away for free.
The root cause is almost always disconnection. When the people delivering the work don't log against the same live budget finance bills from, the two drift apart. Work in progress piles up unbilled, and by the time anyone reconciles it, writing it off feels easier than clawing it back.
Consider a small agency of 10 to 20 people where each person leaves two billable hours unlogged a week. At typical bill rates, that's easily six figures a year, delivered and never invoiced. A connected system closes that leak. When SugarCRM unified projects, time tracking, and billing in one place, they credited under $20K on more than $10M in annual invoicing. You can read how in SugarCRM's story.
The point isn't the tool. Unless delivery and billing share one source of truth, unbilled work stays invisible until it's too late to invoice. The agencies that plug this leak make the log-as-you-go habit frictionless, so the number is always current.
Leak five: build forecasts you can trust
Most agency forecasts start as confident numbers based on gut feel, which is why they miss. If you can't see committed pipeline against real capacity and current burn, your forecast is a wish.
Forecasting from actuals, current utilization, and live budget burn turns that wish into a projection you can act on. This is where AI genuinely helps. AI-assisted forecasting can project margin from what comparable work actually cost, which matters most when a client shifts budget mid-project.
The cost of a bad forecast runs both ways. Forecast high and you hire ahead of work your team never wins, carrying salary against empty utilization. Forecast low and you turn away work or staff it with contractors at a worse margin. A forecast grounded in committed pipeline and real capacity lets you make the hire, or hold off, with confidence.
Before you move on, test your own agency against the map. Each question matches one leak, in order, so every "no" shows you where money is escaping.
Self-audit: where is your margin leaking?
Do you price new work from the actual cost of comparable past jobs?

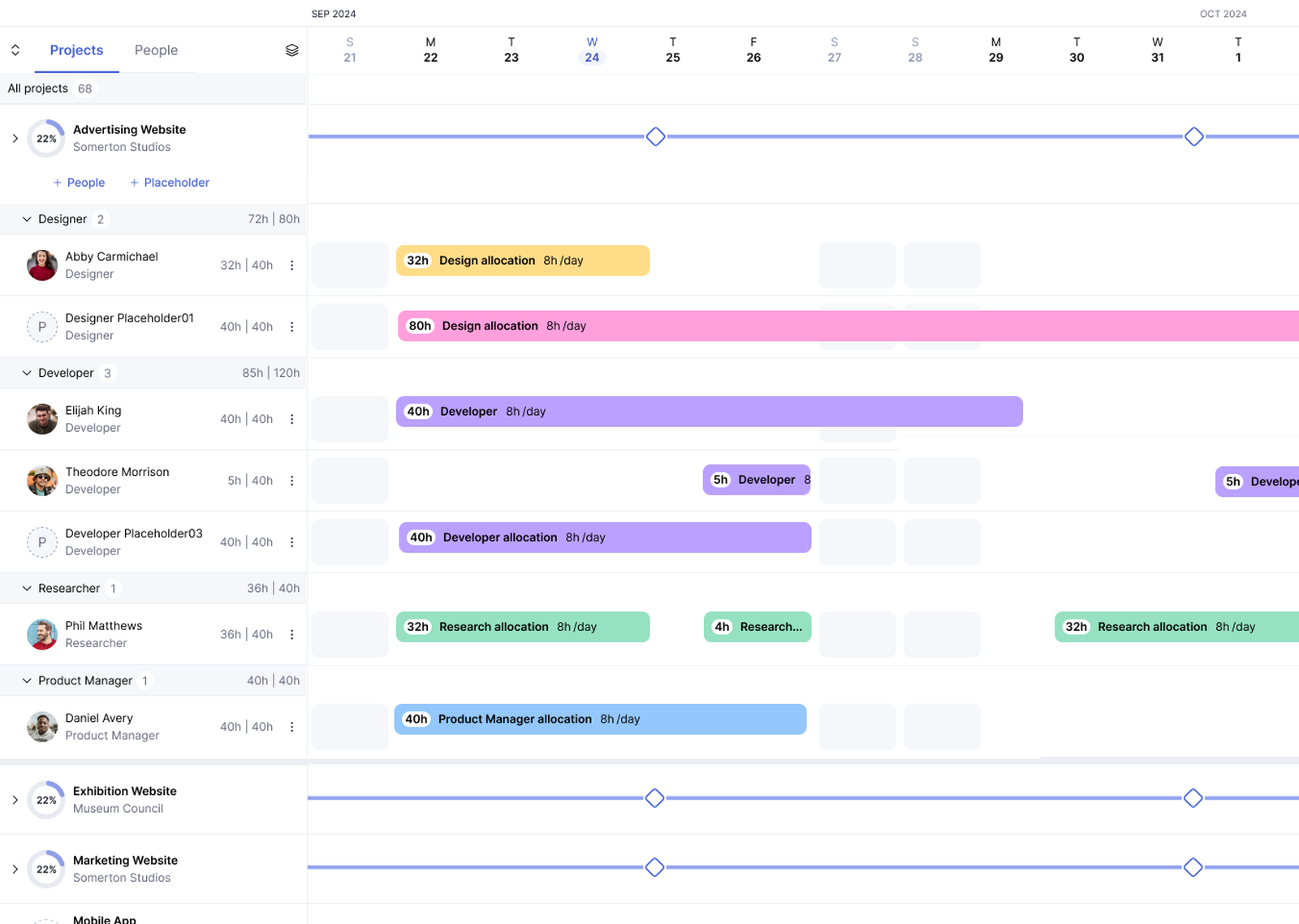

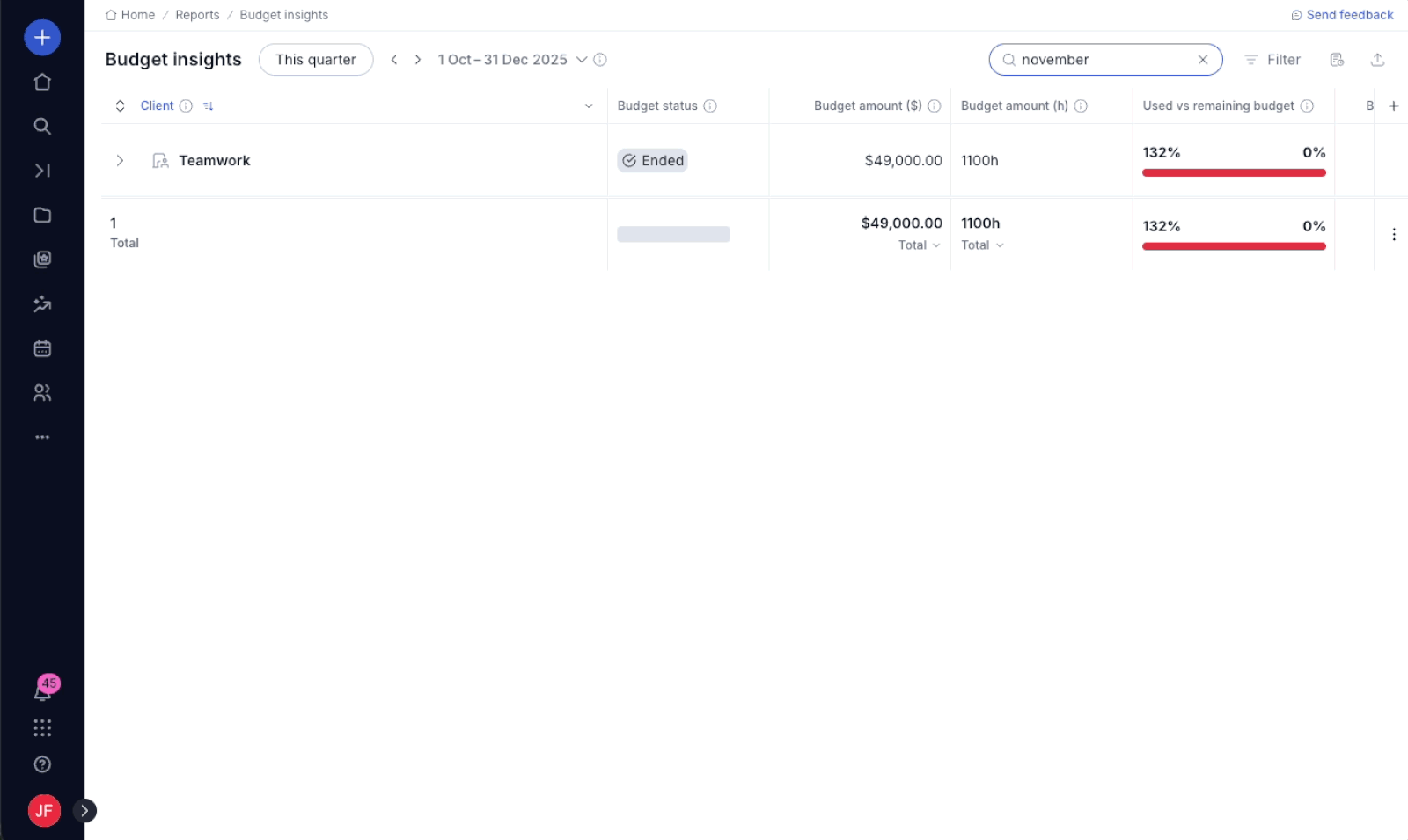

Can you see budget versus actual on a live project today, without asking anyone?

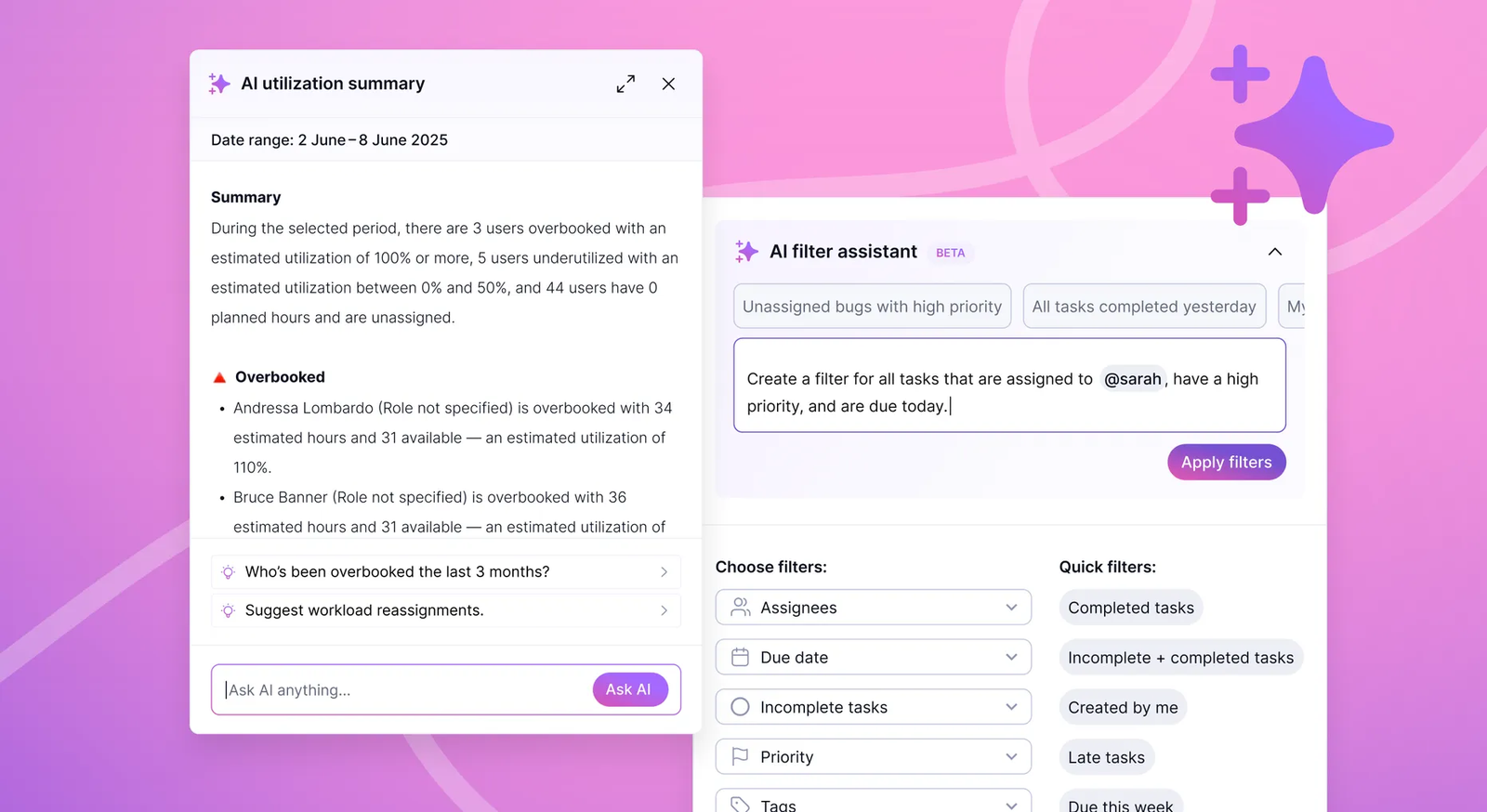

Do you track utilization per person, not just an agency average?
Is there any delivered work sitting unbilled right now?
Does your forecast reconcile pipeline against real capacity?
Two or more "no" answers mean you're managing finances after the fact, not as they happen. Start with the earliest leak you failed, because a quote built on guesswork makes every later number unreliable.
The five numbers that tell you if you're actually profitable
I watch these five numbers above almost everything else, because you can't plug a leak you can't measure. Track them and you'll spot every leak on the map before it reaches the P&L. Together they make up your Agency Financial Health Scorecard.
Metric
Two of these get misread constantly. Rate realization catches the discounting and write-downs that utilization hides. You can be 80% utilized and still bleed margin if you only collect 75% of your standard rate. Work in progress is the early-warning light for leak four, because a rising number means delivered work is stacking up faster than you bill it.
Cadence matters as much as the metrics themselves. I check utilization and budget burn weekly, margin per project at every milestone, and client-level margin monthly. Monthly is often the default because that's when the accounts close, but it means you're always looking at problems that started three or four weeks ago. Put live profitability reports on every project and move the operational numbers to a weekly cadence, and most leaks surface while you can still fix them.

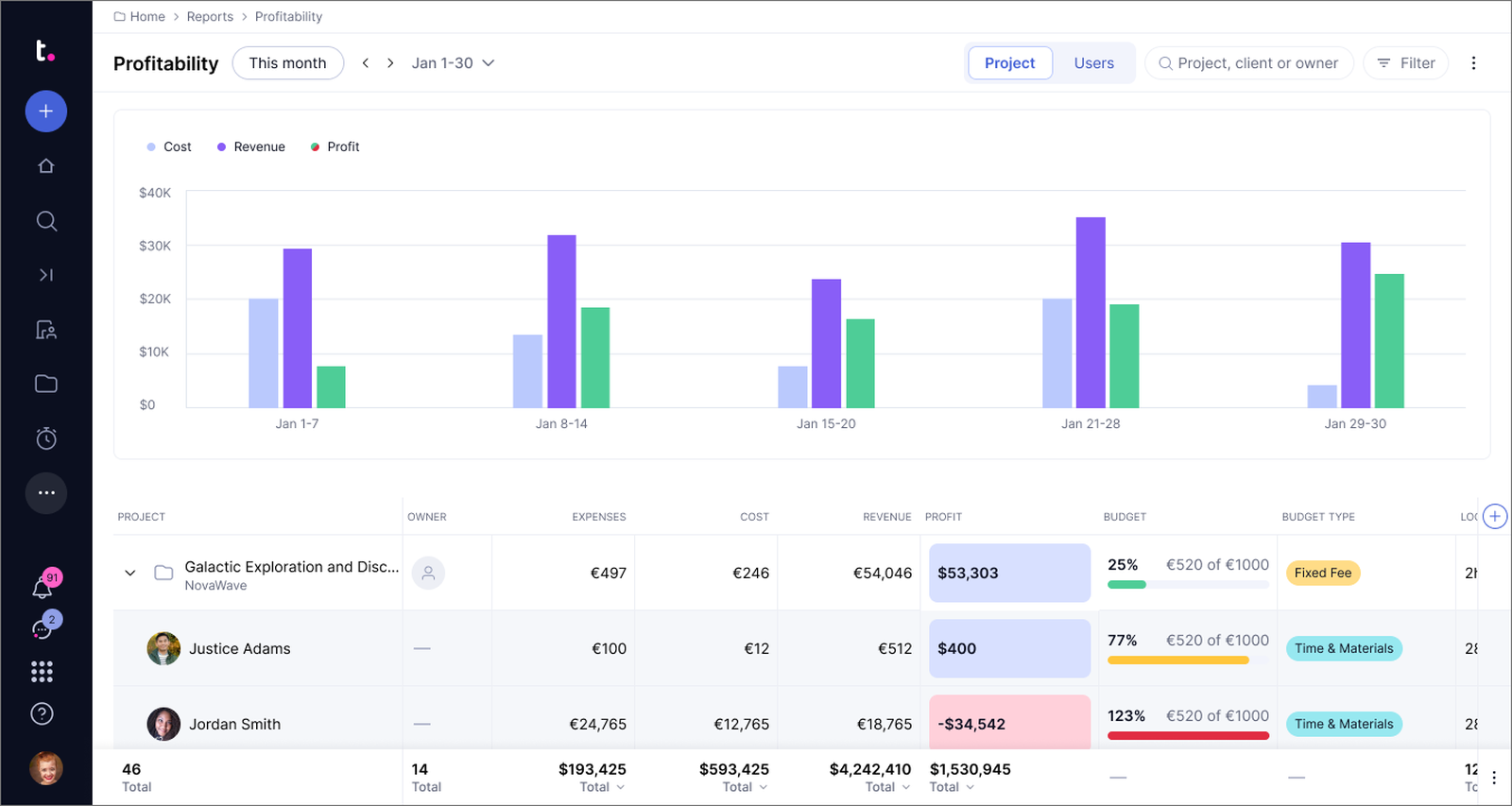

You should also separate project margin from client margin. A single project can look profitable while the client relationship loses money once you count unbilled calls, rushed revisions, and unlogged account management. Roll margin up to the client, not just the project. Your "best" account by revenue is often one of your worst by profit.
Numbers only matter when you can act on them. Take a mid-size agency running well below its target utilization. A 15-point gap, across a team billing at typical rates, is hundreds of thousands in billable capacity going unused over a year. Nobody decided to lose that money; it leaked one under-booked week at a time. If you want to size your own version of that gap, the revenue gain calculator does the math.
Where your project data ends and your accountant begins
A common question: doesn't our accounting software already do this? It's a fair one, and the answer is no. The two systems solve different problems. Your delivery platform is where quote-to-cash happens: estimates, budgets, logged time, live margin, and what to invoice. Your accounting system or ERP is where the general ledger, tax, and statutory reporting live once the money has moved.
Here's the handoff in practice. Your team logs time against a budget, that time becomes an approved invoice, and the invoice syncs to Xero or QuickBooks as a ledger entry. The delivery platform owns everything up to the invoice, and accounting owns everything after it. Problems start when you ask one system to do the other's job.
Expecting the accounting system to manage delivery economics is the classic mistake. It records transactions beautifully and tells you nothing about whether a live project is on track to make money. That's the operational layer, and it belongs where the work happens.
Cash flow is where the split gets expensive. Your accounts show what's been invoiced and paid. But the money you'll collect next quarter depends on work you're delivering right now and haven't billed yet. Seeing live WIP and upcoming milestones alongside your accounts is what lets you predict the gaps before they become a payroll problem.
When the invoice handoff is solid, finance stops re-keying numbers and the two systems stop disagreeing. When it's missing, someone spends the last week of every month reconciling by hand, and the margin picture is always a month stale.
Get the boundary right and the two systems reinforce each other. The operational layer produces trustworthy numbers as delivery happens, and accounting records them cleanly afterward. Our guide to managing project finances goes deeper on that operational side.
Five habits to fix so you protect agency margin
The leaks on the map usually come from the same handful of habits. Each one quietly limits profitability, even when demand looks strong. Here's a quick Margin Mistakes and Fixes reference.
Each of these shares one root cause: a decision made without the number in front of you. Pricing without actuals is a guess, and a monthly budget check is a post-mortem four weeks too late. A blended utilization figure hides the outliers who actually move your margin. Billing in arrears with no WIP view means you only find unbilled work once it's stale.
Notice the through-line: every fix moves a decision earlier, from after the invoice to during the work. When OIC Advisors connected their projects into one view, they gained a complete view across every active engagement. They also spent 100% less time manually assembling reports, which you can see in OIC Advisors' story. The reporting time vanished because the numbers were already connected.
Pro tip: If your team resists financial discipline because logging time feels like surveillance, reframe it. Time and budget data captured in the same tool people already use to run projects protects their projects from going underwater. That protects their weekends too.
The manual version rarely sticks. Everything above is doable in spreadsheets if you have the discipline and the hours, but margin visibility that depends on someone updating a sheet isn't really visibility. Generic project tools can't manage the money, and traditional PSA (professional services automation) platforms often go unused because teams resist them. Teamwork.com is an agentic PSA built to do both, and here's how it closes each leak on the map.
Spot budget overruns before they snowball. The hardest part of budget control is that overruns stay invisible until reconciliation, because generic project tools track tasks but not money. Budget tracking across fixed-fee, time and materials, and retainer models keeps the live number in front of you. A project trending over shows up while you can still act.
)
Catch a slipping account this week, not next quarter. Most agencies learn a project's true margin after it closes, when it's too late to change the outcome. Real-time cost and profitability management shows margin as delivery happens, so a slipping account becomes a conversation now.
)

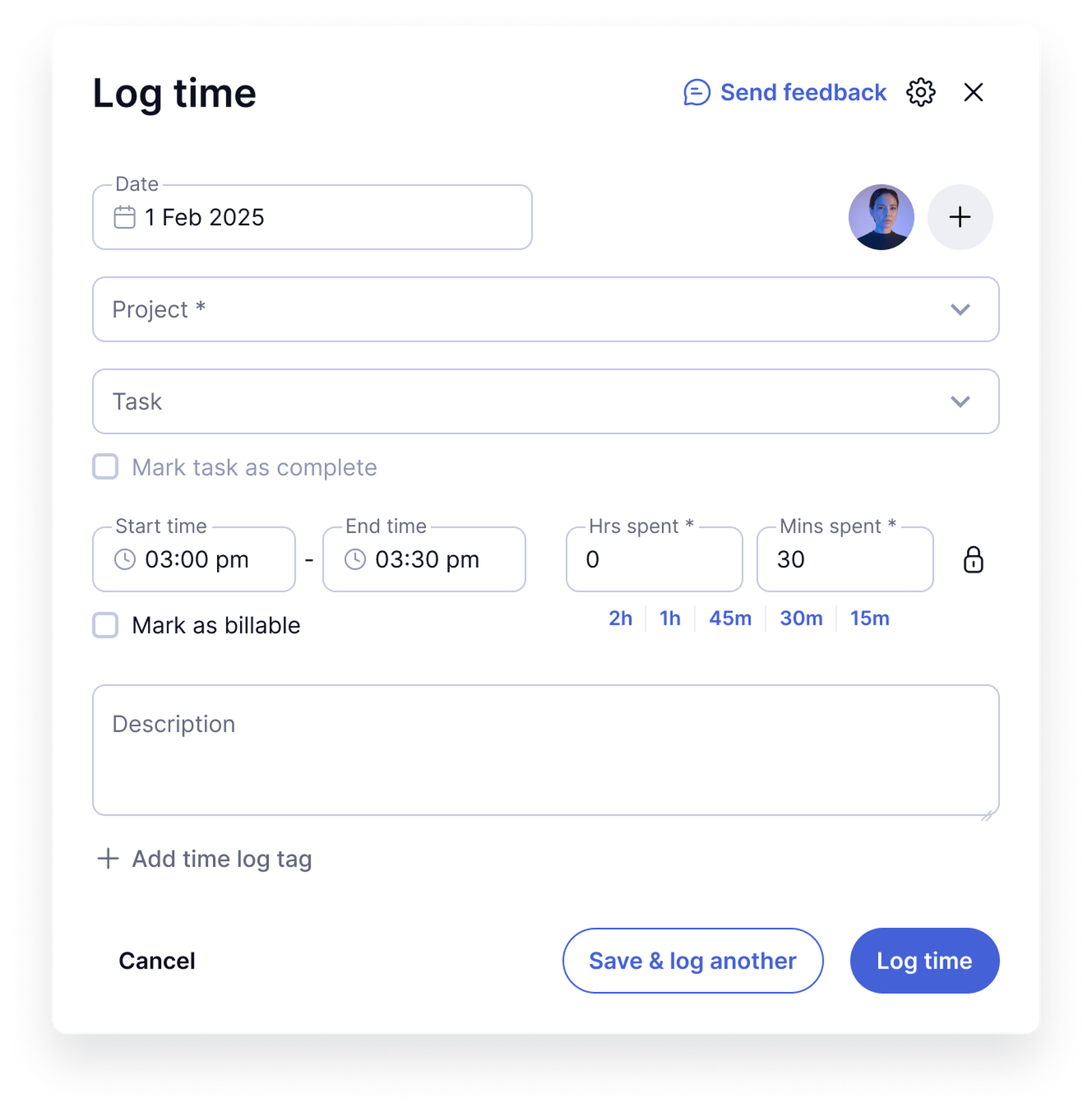

Make sure earned time reaches the invoice. When the people delivering the work log time against the same budget finance bills from, work in progress stops disappearing between systems. Built-in time tracking that flags billable and non-billable hours closes leak four at the source.
)
Rebalance staffing before idle capacity turns into lost revenue. Averages hide the people you're losing money on, and a quarterly review surfaces it too late. Resource management shows workload and cost against bill rate per person, so you can rebalance early.
)
Forecast margin and capacity with more confidence. A gut-feel projection falls apart the moment a client moves budget or a deal slips. AI Forecasting and team utilization summaries project from comparable costs and real availability. That's the difference between a forecast you defend and one you hope for.
)
None of this is theoretical. After moving to a connected platform, the consultancy Beyond the Chaos reported 1,000% ROI alongside 4x revenue growth. That kind of result comes from finally seeing and protecting margin on every project, as their Beyond the Chaos story shows. If any of the leaks on this map sounded familiar, you're not bad at your job; you've just been running the numbers in systems that were never built to talk to each other.
If you're not sure where to start, I'd pick one leak, not all five. Turn on live budget tracking for your next new project, get your team logging time against it from day one, and watch the margin number for a month. Once that habit sticks on one project, roll it out. Trying to fix all five leaks at once is how good intentions die in week two.
)
)
)
)
)
)
)
)
)
)
