Project cost management: Summary & key takeaways
Cost management is a discipline, not a task: It covers the entire project lifecycle, from initial resource planning through cost estimation, budgeting, control, and reporting.
Overruns are an operations problem: Budget blowouts don't just hurt finances; they cascade into resource chaos, missed deadlines, and client trust erosion.
The four-step process is your foundation: Resource planning, cost estimation, cost budgeting, and cost control form the backbone of every reliable cost management framework.
Visibility beats hindsight: Teams that track costs in real time catch problems before they compound; teams that rely on end-of-project reviews are always too late.
A cost management plan is non-negotiable: Without documented thresholds, escalation triggers, and reporting cadence, cost control is guesswork.
Every project I managed in my agency days started with the same optimistic spreadsheet. Three months later, that spreadsheet looked nothing like reality. The gap between the planned budget and the actual spend was never a math problem; it was a process problem.
In this guide, I'll walk you through what project cost management is and why it matters for professional services teams. You'll learn how to build a cost management process that holds up when projects get messy. I'll also cover common mistakes, practical frameworks, and how we approach cost management at Teamwork.com.
What is project cost management?
A pattern I kept seeing in my prior career, and still see at Teamwork.com, is teams confusing cost tracking with cost management. They're not the same thing.
Project cost management is the discipline of planning, estimating, budgeting, and controlling costs across a project's entire lifecycle. It's not one activity; it's a set of connected processes that work together to keep a project financially viable from kickoff to close-out.
Where cost tracking is reactive (recording what you've spent), cost management is proactive. It sets the financial guardrails before work starts, monitors spending as work progresses, and forecasts what's coming so you can adjust before problems escalate.
For a deeper look at the tracking side of the equation, our project cost tracking guide breaks down the eight practical steps.
Why project cost management matters for professional services teams
In my years managing client service teams before joining Teamwork.com, I watched the same pattern repeat. A project starts on budget. Creep sets in around week three. By the time anyone flags the overrun, the damage is done, not just to the budget, but to the entire operation.
This isn't a niche problem. According to Teamwork.com's 6 Strategic Shifts For 2026 report, 38% of professional services leaders say their current tools fall short on profitability management. That's more than one in three teams flying partially blind on the financial health of their projects.
For operations directors, cost overruns aren't just a line item. They create a cascade:
Projects drag on longer than planned, keeping team members tied up and unavailable for new work.
Capacity planning breaks down because overallocated staff can't be reassigned.
New business gets delayed or turned away because you can't confidently commit resources.
Client relationships erode when you're forced into uncomfortable conversations about scope and fees.
The professional services angle matters here. Unlike product companies where a budget overrun might delay a release, service firms absorb overruns directly into their margins. According to SPI Research, the average professional services firm targets net margins of 15% to 20%. Every dollar over budget is a dollar off that margin, and even small overruns compound quickly across a portfolio of active projects.
The operational cascade effect of poor cost management
The worst part? By the time a cost overrun surfaces in a monthly report, the operational damage is already done. Team members are already overworked. New projects are already understaffed. And the client relationship has already taken a hit.
That's why cost management isn't just a finance function. For ops directors, it's an operational control system. When you know where your costs stand in real time, you can make resourcing decisions proactively, not reactively.
Four steps that turn cost chaos into financial control
In my experience before joining Teamwork.com, I found that most teams know these steps exist. The problem isn't awareness; it's rigor. Each step feeds into the next, and cutting corners on any one of them weakens the whole chain.
The four steps of the cost management process are: resource planning and cost estimation, cost budgeting, cost control, and cost reporting.
Resource planning and cost estimation
Cost estimation is the process of forecasting the total cost required to deliver a defined scope of work. It requires identifying every resource (people, tools, materials, contractors) and assigning realistic costs to each. For a detailed walkthrough of estimation methods, including bottom-up, top-down, parametric, and three-point techniques, our project cost estimation guide covers the full framework.
Cost budgeting and baseline setting
Once you have reliable estimates, the next step is translating them into an approved budget, your cost baseline. This baseline is the financial yardstick you'll measure against throughout the project. For a step-by-step approach to building and managing project budgets (including contingency reserves and overhead allocation), see our project budgeting guide.
Cost control and monitoring
Cost control is where the real work happens. It's the ongoing process of comparing actual spend against your baseline, identifying variances, and taking corrective action before small deviations become large overruns. Our project cost tracking guide walks through eight practical steps for establishing a tracking process that catches problems early.
Cost reporting and forecasting
This is the step that gets the least attention in most operations, and it's the one that matters most if you're responsible for a P&L.
Cost reporting isn't just generating a spreadsheet at the end of the month. It's turning raw cost data into decisions. A useful cost report answers three questions:
Are we on track to deliver this project within budget?
If not, what's driving the variance and what can we do about it?
What does the current spend rate tell us about the final cost at completion?
The reporting cadence should match project complexity. For short engagements (under four weeks), a midpoint check and close-out review are sufficient. For longer projects, weekly reviews with a monthly stakeholder summary keep you ahead of problems.
Project duration
The goal is simple: if your review doesn't produce a clear "yes, we're on track" or a specific action item, it's a status meeting, not a budget review.
Connecting cost management to profitability
Cost management and profitability management are often treated as separate disciplines. They shouldn't be.
A project can come in on budget and still destroy your margin if the budget was built on the wrong rate assumptions or if utilization dropped during delivery. Here's the connection in simple terms:
If you bill a client $80,000 for a project and your total cost (including overhead allocation) is $64,000, your margin is 20%. That's healthy for most professional services firms. But if your team's utilization dropped to 65% during the project, the actual cost per billable hour went up. Bench time, context switching, and untracked non-billable work all contribute. Your real margin may be closer to 12%.
Metric
This is why cost management and resource utilization have to be connected. If your budgeting process doesn't account for utilization rates, you're managing costs in isolation from the thing that determines whether those costs translate into profit.
Why most teams track costs but never actually manage them
A pattern we see across Teamwork.com customers is teams that track costs but never documented how they'd manage them. They have budget data; they don't have a plan for using it.
A cost management plan is the document that turns ad hoc tracking into a repeatable system. It defines what you'll track, how you'll track it, who's responsible, and what happens when things go off course.
Define cost categories and structures
Start by mapping your cost categories. For professional services, the big four are:
Direct labor: Billable hours for delivery team members (designers, developers, strategists, consultants).
Direct non-labor: Software licenses, stock assets, contractor fees, materials.
Indirect labor: Project management time, internal meetings, status reporting, admin.
Overhead allocation: Office costs, equipment, training, non-billable coordination time.
The overhead line is where most plans fall apart. A pattern I kept seeing in my prior career, and still see at Teamwork.com, is teams that track every billable hour but treat non-billable time as invisible. If your team spends 20% of their week in internal meetings and admin, that cost belongs in your budget model.
Set escalation triggers and variance thresholds
Define your escalation thresholds before the project starts. Here's the model I use:
Variance level
Without predefined triggers, budget problems get escalated too late or not at all. The ops director ends up finding out about the overrun in a monthly P&L review instead of a weekly project sync.
Establish a tracking cadence
Decide how often you'll review costs and who sees the data. Weekly is the minimum for any project longer than two weeks. Make sure the tracking tool is accessible to everyone who needs it. If cost data lives in a spreadsheet that only the PM updates, you don't have visibility; you have a bottleneck.
Document assumptions and get sign-off
A cost management plan without documented assumptions is a liability. Every plan I've seen fail in an escalation meeting failed because the assumptions were never written down. The PM "knew" the scope included three rounds of revisions, but the client's sign-off email said "reasonable revisions."
Document these at minimum:
Included and excluded deliverables
Hourly rates and billing model (fixed fee vs. time and materials)
Revision and change request policy
Contingency amount and release criteria
Payment milestones and invoicing schedule
Then get written sign-off. Not a Slack thumbs-up. A formal approval that references the document. This protects both the client relationship and your margin.
For teams that want to get started quickly, our templates library includes pre-built project structures with budget frameworks you can customize for your workflow.
Earned value management: connecting cost to progress
In my experience before joining Teamwork.com, I found that earned value management (EVM) sounds intimidating. In practice, it's straightforward once you strip away the jargon.
EVM compares what you planned to spend against what you've actually spent and what work you've actually completed. It answers a question that basic budget tracking can't: are you getting value for the money you're spending?
Key EVM metrics for operations directors
The three core metrics are:
Planned Value (PV): The budgeted cost of the work you planned to complete by now.
Earned Value (EV): The budgeted cost of the work you've actually completed.
Actual Cost (AC): What you've actually spent.
From these, you can calculate two performance indices:
A CPI above 1.0 means you're under budget. Below 1.0 means you're spending more than planned for the work completed.
An SPI above 1.0 means you're ahead of schedule. Below 1.0 means you're behind.
Here's a worked example. Your project budget is $50,000 for 500 hours of work. At the halfway mark, you check the numbers:
PV (planned): $25,000 (you should have completed 50% of the work)
EV (earned): $22,000 (you've actually completed 44% of the work)
AC (actual cost): $27,000 (you've spent more than planned)
A CPI of 0.81 means you're spending $1.23 for every $1 of work completed. An SPI of 0.88 means you're behind schedule. Both numbers tell the same story: this project needs a corrective plan now, not at close-out.
Data point
According to the Project Management Institute, projects that use earned value analysis are significantly more likely to meet their budget targets. The structured tracking forces teams to confront variances early rather than finding out about them at close-out.
When EVM is worth the overhead (and when it isn't)
EVM adds overhead. For a two-week sprint, it's probably overkill. But for any engagement running longer than six weeks with a budget above $50,000, the cost of not using EVM almost always outweighs the tracking overhead.
The key is keeping it simple. You don't need enterprise-grade EVM software. You need three numbers (PV, EV, AC) updated weekly, and the discipline to act on what they tell you.
The cost management mistakes that quietly kill your margins
After years inside professional services teams, I've seen the same cost management failures repeat across different firms, industries, and project types. Here are the ones that cause the most damage.
Treating overhead as invisible
This is the single biggest margin killer in professional services. Teams track billable hours religiously but treat non-billable time as free. It's not.
If your team spends 20% of their capacity on internal meetings, context switching, and admin, every estimate you produce is understated by roughly 20%. Don't account for that in your project budgets, and you're systematically under-pricing your work across the entire portfolio.
Hard truth
If your budgeting process doesn't connect to utilization tracking and margin reporting, you're managing a spreadsheet, not a business. Use a utilization rate calculator to benchmark your team's performance and identify where capacity leaks are hiding.
Skipping the estimate-to-actual feedback loop
Many teams estimate at the start, track during execution, but never close the loop. They don't compare their original estimates against actual costs after the project finishes. The PMBOK Guide calls this "organizational process assets," but in practice, it's simpler than that: did we learn from last time? Without that feedback, you repeat the same estimation errors on every new project.
Ignoring non-billable time in cost calculations
Related to overhead, but more specific: non-billable time includes project management hours, internal reviews, QA, and rework cycles. When these aren't factored into cost estimates, margins erode invisibly. The project looks "on budget" in the tracker, but the profitability report tells a different story.
Pro tip
When I was managing delivery ops before joining Teamwork.com, tracking time at the task level (not just the project level) was the single change that gave us the clearest view of margin erosion. It's still the first thing I recommend to any team trying to figure out where profit is leaking.
Relying on project-level estimates instead of task-level
A project-level estimate of "120 hours, $18,000" hides errors. A task-level breakdown (discovery: 20 hours, design: 25 hours, build: 40 hours, testing: 15 hours, revisions: 20 hours) exposes them. Budget at the task level. It takes more effort upfront, but it catches estimation errors before they compound.
Not connecting cost management to change control
Scope changes are inevitable. The mistake isn't that they happen; it's that they happen without a cost conversation. Every change request should trigger a budget impact assessment before the work begins. Without a formal change control process tied to your cost management plan, scope creep becomes the default operating mode. Small changes accumulate, and by the time anyone notices, the budget gap is too wide to close.
Self-audit: is your cost management process working?
In my experience, the gap between "we track costs" and "we manage costs" almost always shows up in the same five places. Run through this checklist to find where your process breaks down. If you answer "no" to two or more of these, your cost management process has gaps that are likely costing you margin.
Self-audit checklist
Do you have a documented cost management plan for every project over $10,000?
Can you see actual vs. budgeted costs in real time (not just at month-end)?
Are your escalation thresholds defined before the project starts?
Do you include non-billable time in your cost estimates?
Do you run a post-project estimate vs. actual analysis on every completed engagement?
What to look for in project cost management software
A pattern I kept seeing in my prior career, and still see at Teamwork.com, is teams using three or four disconnected tools. They're trying to manage what should be a single financial picture. Time tracking in one tool, budgets in a spreadsheet, profitability calculations in yet another tab.
The right project cost management tool brings these pieces together. Here's what to prioritize:
Built-in budgets with real-time tracking: You need to set a budget and see actual spend against it without manual reconciliation. Look for threshold alerts that flag problems automatically.
Native time tracking: Time is the single largest cost driver in professional services. If your time data lives in a separate system, your cost data is always lagging.
Profitability reporting (not just cost reporting): Cost tracking tells you what you spent. Profitability reporting tells you whether you made money. The second question is the one that matters.
Resource visibility: Overruns often start with resource misalignment. A tool that connects capacity planning to project budgets catches these problems before they hit the P&L.
Forecasting: Historical data is useful, but forward-looking projections are what let you course-correct. Look for AI-powered forecasting that flags margin risk before it materializes.
The key test: can you answer "is this project profitable?" in under 30 seconds without opening a spreadsheet? If not, your tooling has a gap.
How Teamwork.com helps you manage project costs
Everything I've covered in this guide, from scoping through monitoring through margin analysis, is easier when your projects, people, and finances live in one system. Here's how customers we work with at Teamwork.com put these principles into practice.
Project budgets
The cost management challenge for most teams starts with budgeting, and that's where Teamwork.com's budgets feature makes the biggest difference. Set a total project budget (time-based, fee-based, or both) and track actual spend against it in real time. You can break budgets down by task list, which maps directly to the WBS approach discussed earlier. When spend crosses a threshold you define, the system flags it before it becomes a problem.
)
Time tracking and billable rates
Accurate cost data starts with accurate time data. Built-in time tracking captures both billable and non-billable hours at the task level. This feeds directly into your budget burn rate and eliminates the overhead gap that derails so many project budgets. Team members log time from the task view, the timer, or the timesheet, so the barrier to compliance is as low as possible.
)

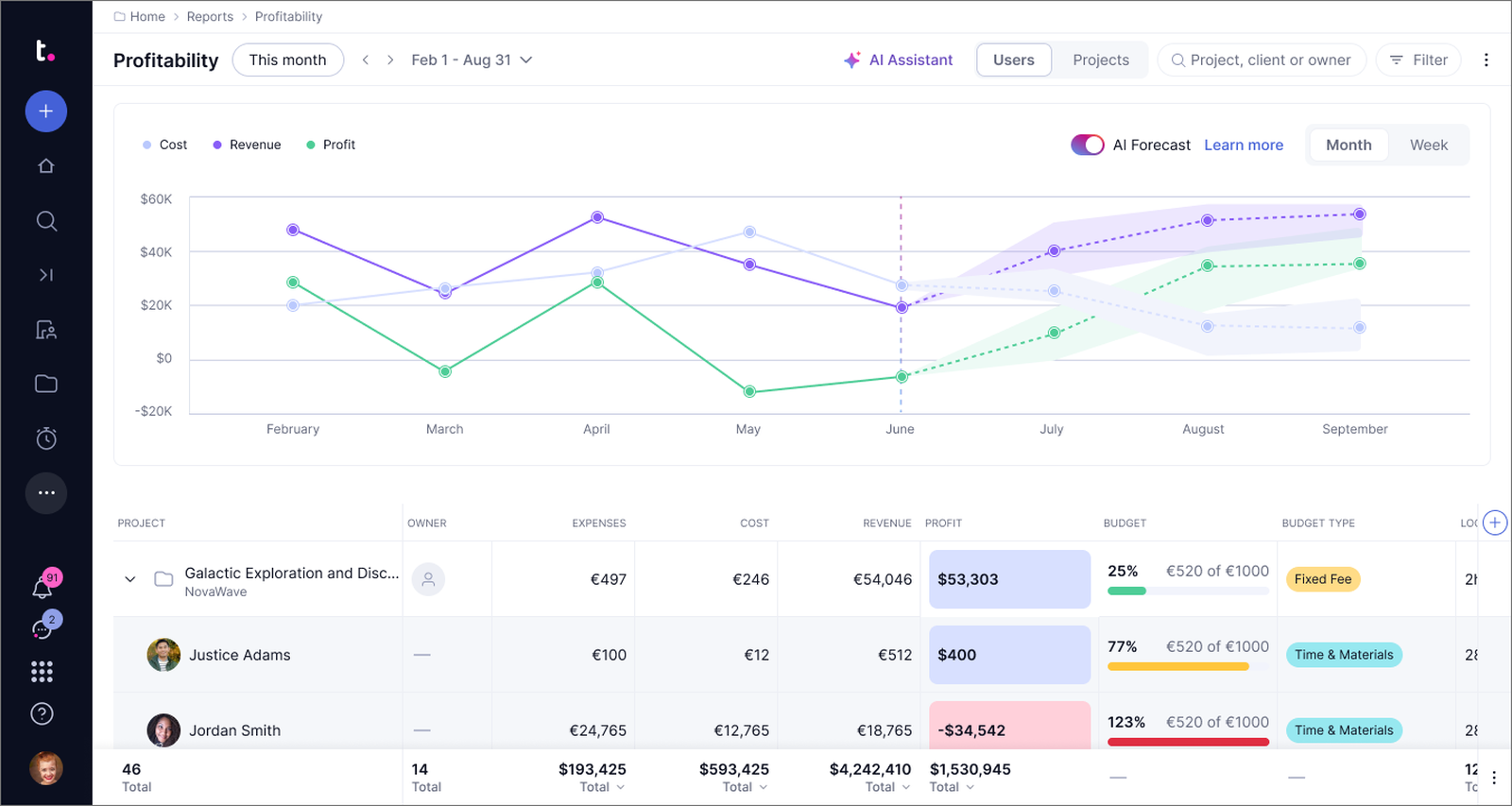

Profitability reporting
The real question isn't "are we on budget?" It's "are we making money?" The profitability dashboard connects budgets to revenue, showing margin at the project, client, and portfolio level. It pulls in time data, cost rates, and billing rates to give you a single margin number.
When The Brand Leader, a creative agency, started using Teamwork.com's budgeting and profitability features, the results were immediate. "By understanding our cost centers and the cost per person per project, we're now more profitable and more efficient," said Kyle Duford, President and Executive Creative Director. Read The Brand Leader's full story.
)

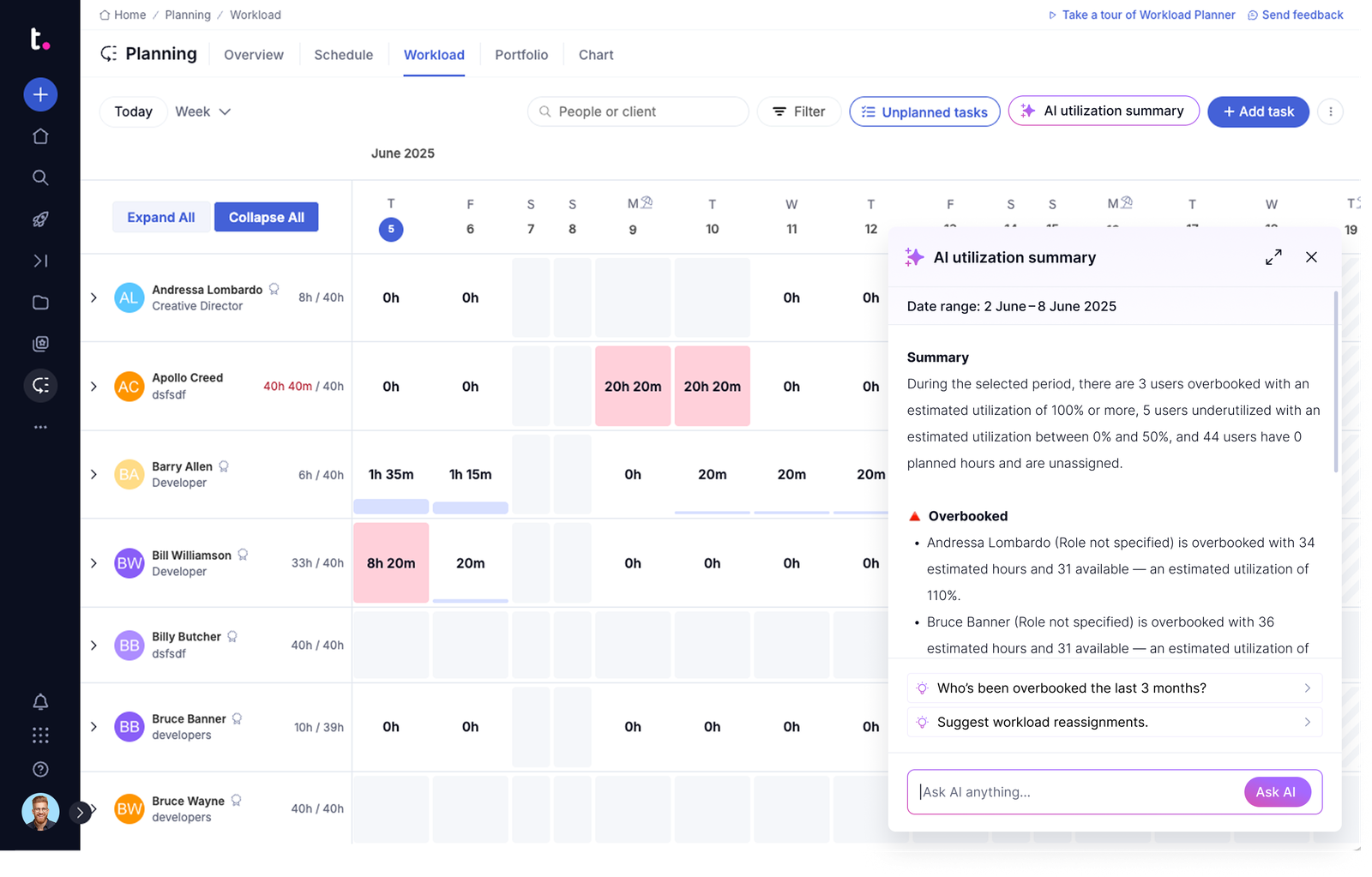

Workload planner and resource scheduling
Cost overruns often start with resource misalignment. The Workload Planner shows who is available, who is overbooked, and where capacity gaps exist, all before you commit to a budget. Invanity, a UK-based digital marketing agency, cut time spent on weekly workload management by 80% after adopting the Workload Planner. On-time project delivery increased by 20%. Read Invanity's full story.
)
AI Profitability Forecaster
Waiting until project close-out to check profitability is like checking your bank balance after the bill is due. The AI Profitability Forecaster gives you instant profitability predictions based on current project data. Instead of finding out about margin erosion after the fact, you get forward-looking forecasts that flag risk while there's still time to course-correct.
)
"I also really value the finance section. Having clear, easy-to-understand visibility of project budgets and financial performance is exactly what I need to keep everything on track." — Daniel M., Customer Success Manager, G2
Project cost management FAQ
What is project cost management?
Project cost management is the discipline of planning, estimating, budgeting, and controlling costs across a project's lifecycle. It ensures projects are completed within their approved budget while delivering the expected value and return on investment.
What are the four steps of the cost management process?
The four steps are resource planning and cost estimation, cost budgeting (setting a baseline), cost control and monitoring (tracking actuals against baseline), and cost reporting and forecasting. Each step feeds into the next to create a continuous financial control loop.
What is a cost management plan?
A cost management plan is a document that outlines how project costs will be estimated, budgeted, tracked, and controlled. It defines cost categories, escalation thresholds, reporting cadence, roles, and the tools used for monitoring. It's typically created during project planning and approved by stakeholders before work begins.
What is earned value management (EVM)?
Earned value management is a project performance measurement technique that compares planned spend, actual spend, and work completed. It uses metrics like Cost Performance Index (CPI) and Schedule Performance Index (SPI) to measure whether a project is on budget and on schedule.
How do you prevent project cost overruns?
Start with accurate task-level estimates, not project-level guesses. Include overhead and contingency in your budget. Set variance thresholds with clear escalation paths. Track costs in real time rather than monthly. Close the loop by comparing estimates to actuals after every project.
What is the difference between a project estimate and a project budget?
An estimate is a prediction of what something will cost based on available information. A budget is the approved financial plan with governance, tracking, and accountability built in. Estimates are inputs to budgets, not substitutes for them. For a deeper dive, our project cost estimation guide covers estimation techniques in detail.
)
)
)
)
)
)
)
)
)
)
