Team utilization tracking: how to measure and improve what your team actually delivers

Blog post image

Team utilization tracking: summary and key takeaways

  • Utilization rate is not productivity: It measures capacity allocation, not output quality. Tracking it wrong creates perverse incentives that burn people out.

  • The formula is simple; the discipline isn't: Calculating utilization takes one equation, but building a reliable tracking system requires defined billable categories, consistent time entry, and weekly reviews.

  • Benchmarks vary by role: Producers should target 70–80% billable utilization, managers 30–45%, and support roles any percentage above zero. One blanket target for everyone is a recipe for dysfunction.

  • Tracking without action is just surveillance: Utilization data only matters if you connect it to staffing decisions, capacity forecasting, and profitability analysis.

  • Automation kills the spreadsheet tax: Manual tracking in spreadsheets costs your ops team hours every week and produces data nobody trusts. Purpose-built tools eliminate that overhead.

I spent years inside agencies before joining Teamwork.com, and the single biggest gap I kept seeing wasn't a lack of data. It was a lack of trust in the data. Teams tracked utilization in spreadsheets that were always two weeks stale, made resourcing decisions on gut feel, and then wondered why they kept oscillating between burnout and bench time.

This guide covers how to set up team utilization tracking that actually works: what to measure, what benchmarks to use, how to build a weekly review cadence, and what mistakes to avoid along the way. If you've ever stared at a spreadsheet trying to figure out who's overloaded and who has room, this is for you.

What is team utilization tracking?

I'll keep this short because we've covered the fundamentals extensively elsewhere. Team utilization tracking is the practice of measuring how your team spends their available working hours, expressed as a percentage of total capacity. The core equation is straightforward.

Utilization Rate=Total Hours Worked on TasksTotal Available Hours×100\text{Utilization Rate} = \frac{\text{Total Hours Worked on Tasks}}{\text{Total Available Hours}} \times 100

The distinction that matters most is between resource utilization (all work, including internal meetings and admin) and billable utilization (only client-facing, revenue-generating hours). Both metrics tell you something different. Resource utilization shows overall capacity allocation. Billable utilization shows revenue efficiency. You need both.

For a deeper dive into formulas, variations, and calculation examples, see our utilization rate definition and formula guide. You can also plug your own numbers into the Utilization Rate Calculator to see where your team stands right now.

Why tracking team utilization matters more than you think

In my years managing client services teams before joining Teamwork.com, I watched smart leaders make major staffing decisions based on nothing but hallway conversations and gut instinct. Someone says "we're slammed" and the response is either to hire or to push harder. Neither works without data.

Here's what's actually at stake. A team running at 60% billable utilization when it should be at 75% is leaving roughly 15% of its revenue capacity on the table. For a 20-person team billing at $150 per hour, that's over $900,000 a year in unrealized revenue. That's not a rounding error.

Data point

According to Teamwork.com's 6 Strategic Shifts For 2026 report, 42% of professional services teams say resource management is where their current tools fall short. The visibility gap is real, and it's costing firms money every quarter.

Without reliable utilization data, you can't answer the questions that actually drive your business: Can we take on this new client? Do we need to hire, or just reallocate? Which team members are approaching burnout? Which are underbooked and costing us margin?

One of the reasons we built utilization tracking directly into Teamwork.com is that these questions don't wait for a monthly report. They come up in every Monday pipeline meeting, every client kickoff, every resource request. You need answers in real time, not in a spreadsheet someone updates on Fridays.

The revenue impact is only half the story. The human cost is the other half. Teams without utilization visibility tend to overload their top performers (because they're reliable) and underuse newer team members (because allocation feels risky). The result is burnout concentrated on your best people and attrition you can't afford. According to the Project Management Institute, poor resource allocation is one of the top reasons projects exceed budgets. Utilization tracking is how you get ahead of that problem.

See exactly where your team's capacity goes

Track billable and non-billable hours across every project, then turn those numbers into staffing and revenue decisions you can actually trust.

Start free

How to calculate your team's utilization rate

I covered the core formula above, but let me walk through a practical example so you can see how the numbers play out in a real scenario.

Take a designer on your team who works 40 hours per week. In a given week, they spend 28 hours on client projects, 4 hours in internal meetings, 3 hours on admin, and 5 hours on professional development. Here's how the two utilization metrics break down:

Metric

Formula
Calculation
Result
Resource utilization
(All work hours / Available hours) x 100
(35 / 40) x 100
87.5%
Billable utilization
(Billable hours / Available hours) x 100
(28 / 40) x 100
70%

That 17.5-point gap between resource and billable utilization tells you something important. Your designer is busy, but a significant chunk of their time goes to non-revenue activities. Whether that's acceptable depends on their role and your benchmarks.

For a second example, consider a project manager who works 40 hours per week. They spend 15 hours in client meetings and project coordination, 12 hours on internal planning and team standups, 8 hours on reporting and admin, and 5 hours on process improvement.

Metric

Formula
Calculation
Result
Resource utilization
(35 / 40) x 100
87.5%
87.5%
Billable utilization
(15 / 40) x 100
37.5%
37.5%

Both people are working hard. But their billable utilization rates look completely different, and that's expected. Applying the same target to both would be a mistake. That's one reason we built role-based utilization targets into Teamwork.com's reporting: so you can set different benchmarks for different roles and see the variance at a glance.

For a deeper walkthrough of capacity and optimal billing rate formulas, see our full utilization rate guide. And if you want to run your own numbers quickly, the Utilization Rate Calculator lets you input your team's hours and see results instantly.

What's a realistic utilization benchmark?

The right utilization benchmark target depends on what kind of work someone does. Here's a framework I've found works well across agencies, consultancies, and IT services firms.

Role type

Target billable utilization
Rationale
Pure producers (developers, designers, copywriters)
70–80%
Primary billable function; 20–30% reserved for overhead
Delivery managers and project managers
30–45%
Coordination and risk management focus
Support roles (admins, HR, sales)
Any percentage above 0%
Enablers of billable work
Blended organizational target
60–70%
Accounts for all roles, PTO, holidays, and training

Producers spend most of their time on direct client work, so a higher target makes sense. The remaining 20–30% covers breaks, admin, learning, and context switching. Managers and project leads, on the other hand, create value through coordination and planning. Expecting high billable hours from them means they're neglecting the work that prevents project overruns. For your blended organizational target, 60–70% is a healthy baseline that accounts for support staff, time off, and training.

In my experience, firms that target 70–80% billable utilization for producers consistently outperform those chasing higher targets. The remaining capacity funds the learning and collaboration that improves output quality over time.

For a practical example, consider a 40-hour work week at 75% billable utilization. That's 30 billable hours per week, leaving 10 hours for internal meetings, admin, training, and buffer. If your team member bills at $150 per hour, those 30 hours generate $4,500 per week in revenue. At 60% utilization, that drops to $3,600. The $900 weekly difference across a 20-person team adds up to $936,000 annually. Small shifts in utilization have massive financial impact.

You can run this calculation for your own team using the team utilization tracker template we've built for exactly this purpose.

How to set up team utilization tracking (step by step)

The pattern that works is always the same. It's not complicated, but skipping any step means the data you get will be unreliable, and unreliable data is worse than no data.

Define what counts as billable

This sounds obvious, but it's where most implementations go sideways. You need a clear, written list of activity types that qualify as billable versus non-billable. Client project work is billable. Internal meetings, admin, training, and business development are not (usually). The gray areas like pre-sales scoping, client relationship management, and internal projects that support client delivery need explicit categorization.

Write the list down. Share it with every team member. If people are guessing whether something is billable, your utilization data is already compromised.

Set individual and team targets

Use the benchmark framework from the previous section to set role-appropriate targets. Communicate these clearly and explain the reasoning. A designer who understands why their target is 75% (not 95%) is more likely to track time honestly. A project manager who knows their 35% target is intentional will stop feeling guilty about "low" numbers.

Choose your tracking method

You have three options, and they vary dramatically in reliability.

Manual spreadsheets work for very small teams (under 5 people) but break down fast. They rely on people remembering to update them, and the data is always lagging. I used spreadsheets early in my career and spent more time chasing updates than analyzing the data.

Time tracking software (standalone tools like timers and timesheets) gives you better data but still requires manual entry. The key is making it frictionless. If logging time takes more than 30 seconds per entry, compliance drops. Features like stop-start timers and timesheet views make a real difference in adoption.

Integrated platforms that connect time tracking to project management, resource scheduling, and financial reporting give you the full picture. This is the approach we took at Teamwork.com: time data flows directly into utilization reports and workload planning so you're not stitching together three different tools to answer one question.

Build a weekly review cadence

Utilization data that sits in a dashboard nobody checks is just noise. I recommend a 15-minute weekly review with your ops or resource management team. Look at three things: who's trending above target (potential burnout risk), who's trending below (capacity available or scope mismatch), and how current utilization maps to your pipeline commitments.

This weekly rhythm turns utilization from a retrospective metric into a planning tool. You catch problems before they become crises.

Connect utilization to capacity planning

Utilization tracking on its own answers "how busy is my team right now?" But the real value comes when you connect it to forward-looking capacity planning. If you know your team's current utilization and you know your pipeline, you can forecast whether you'll be overbooked or underbooked in 4, 8, or 12 weeks.

This is where tools like the Resource Scheduler pay for themselves. You can model tentative projects against current allocations and see the impact on utilization before committing. For a deeper guide on this topic, see our full workforce capacity planning guide.

Utilization tracking approaches compared

I've seen teams try everything from sticky notes to enterprise PSA platforms. Here's how the main approaches stack up so you can pick the right fit for your team's size and maturity.

Approach

Best for
Strengths
Limitations
Spreadsheets (Excel, Google Sheets)
Teams under 5 people
Low cost, familiar, fully customizable
Manual entry, no real-time data, error-prone at scale
Standalone time trackers
Freelancers and small teams (5–15)
Timer-based accuracy, simple setup
No resource planning integration, limited reporting
Project management tools with time tracking
Mid-size teams (15–50)
Time data tied to project context
May lack utilization-specific reporting and targets
Integrated operations platforms
Teams over 20 managing client work
Connects time, resources, budgets, and utilization in one system
Requires setup investment and team-wide adoption

The most common mistake I see is teams outgrowing their approach but not switching. A spreadsheet that worked for a team of 8 becomes a liability at 25 people. If your ops manager is spending more than an hour per week compiling utilization data manually, it's time to upgrade to an integrated approach.

Common mistakes that sabotage your utilization data

I've seen every version of utilization tracking gone wrong, both in my prior career and across the customers we work with at Teamwork.com. Here are the five most common mistakes.

  1. Tracking time after the fact instead of in real time. When people log time on Friday for the whole week, they're reconstructing from memory. Research consistently shows that time logged more than 24 hours after the work happened is inaccurate by 20–30%. If your utilization numbers are based on recalled time, they're fiction. The fix: use a timer-based system and make same-day entry the expectation, not the exception.

  2. Treating all hours as equal. If you don't distinguish between billable and non-billable time, you can't diagnose problems. A team member at 90% resource utilization but only 50% billable utilization has a very different issue than someone at 90/85. The fix: define activity types upfront and track both metrics separately.

  3. Setting one utilization target for every role. I covered this in the benchmarks section, but it bears repeating. A blanket 80% target across your organization will punish project managers, overshoot realistic expectations for producers, and create resentment across the board. The fix: tier your targets by role type.

  4. Measuring utilization without connecting it to profitability. Utilization tells you how busy people are. Profitability tells you whether that busyness is generating margin. A team member billing at $100 per hour on a project with a $150 per hour rate is profitable. The same person billing at $100 on a fixed-fee project that's already over budget is actively eroding margin. You need both lenses. Connecting utilization to profitability through integrated budget and margin tracking closes this gap.

  5. Using utilization as a performance weapon. The fastest way to kill honest time tracking is to use utilization numbers punitively. If people believe low utilization means a bad review, they'll inflate their time entries. Then your data is useless and your culture is worse. Utilization is a planning metric, not a performance metric. Use it to make better allocation decisions, not to rank employees.

Hard truth

Targeting 100% billable utilization is not ambitious; it's a burnout factory. Teams that push for near-total utilization leave zero room for the unplanned: rush client requests, sick days, knowledge sharing, and the creative thinking that produces better work. I've seen firms sustain 90%+ utilization for a quarter and then face significant senior attrition soon after.

How to improve utilization rates without burning out your team

A pattern I kept seeing in my prior career was teams trying to improve utilization by simply pushing people harder. That works for about three weeks before quality drops, attrition spikes, and client satisfaction craters.

The sustainable strategies focus on removing friction, not adding pressure. Here's what actually works.

Strategy

When to use
Expected impact
Reduce non-billable overhead
High resource utilization, low billable utilization
+5–10pp billable utilization
Improve time tracking adoption
Suspected under-reporting or batch entry
Improved data accuracy, then +3–5pp
Rebalance workloads across team members
High variance (some at 90%, others at 50%)
Reduced variance, fewer burnout extremes
Match skills to work more precisely
Generalist allocation patterns
Higher billable rates, better output quality
Build capacity buffers into scheduling
Frequent overruns and rush reassignments
Fewer firefighting episodes, steadier utilization

Each strategy addresses a different root cause. Reducing overhead works when your team is busy but not billing enough. Rebalancing workloads works when utilization is unevenly distributed. The key is diagnosing the right problem before applying the fix.

When Community Link Consulting moved from spreadsheets and handwritten notes to Teamwork.com for resource planning, they increased their billable hours and reduced team burnout by gaining real-time visibility into who was overloaded and who had capacity. That shift, from reactive to proactive planning, is what actually moves utilization numbers.

The key insight is that utilization improvement is a systems problem, not an effort problem. You don't need people to work harder. You need better allocation, less overhead, and more accurate data.

Connecting utilization to profitability and revenue

I've noticed that many teams track utilization in isolation, disconnected from the financial metrics that actually matter. Utilization tells you how busy your people are. Profitability tracking tells you whether that busyness is generating margin. The two metrics together paint the complete picture.

Here's a practical example. Say your team has an average billable rate of $125 per hour and your fully loaded cost per employee is $65 per hour. At 75% billable utilization across a 20-person team, you're generating roughly $3,900,000 in annual billable revenue against $2,704,000 in labor costs. That's a healthy 30.6% gross margin.

Now drop utilization to 65%. Revenue falls to $3,380,000 while costs stay the same. Margin shrinks to 20%. That 10-percentage-point swing in utilization just cost you $520,000 in annual margin. This is why utilization and profitability must be tracked side by side, not in separate dashboards by different teams.

At Teamwork.com, we connect time tracking and budgets directly, so you can see in real time whether a project's utilization is translating into margin or eroding it. This prevents the common trap of celebrating high utilization on a project that's actually losing money because the budget was underscoped.

Tools and features that make utilization tracking automatic

I spent years cobbling together spreadsheets, standalone time trackers, and separate reporting tools trying to get a clear utilization picture. It never worked. If you've set up the fundamentals (categorized billable time, set role-based targets, and built a weekly review cadence) the next step is automation.

Here's how we approach this at Teamwork.com, built from those exact problems.

  • See your team's utilization at a glance, broken down by billable and non-billable hours. The utilization report shows exactly how each person's time breaks down across projects, with targets overlaid so you can spot who's above, below, or at plan. No more building pivot tables in Excel every Monday morning.

Blog post image

  • Know who has room before you promise a client anything. The Workload Planner gives you a real-time view of who's at capacity and who has availability, by day or week. When a new project request comes in, you can check capacity in seconds instead of sending six Slack messages asking who's free.

Blog post image

  • Plan ahead with long-term resource forecasting. The Resource Scheduler lets you map tentative and confirmed projects against your team's capacity weeks or months in advance. You can model "what if we take on this project?" scenarios before committing and see the utilization impact in real time.

Blog post image

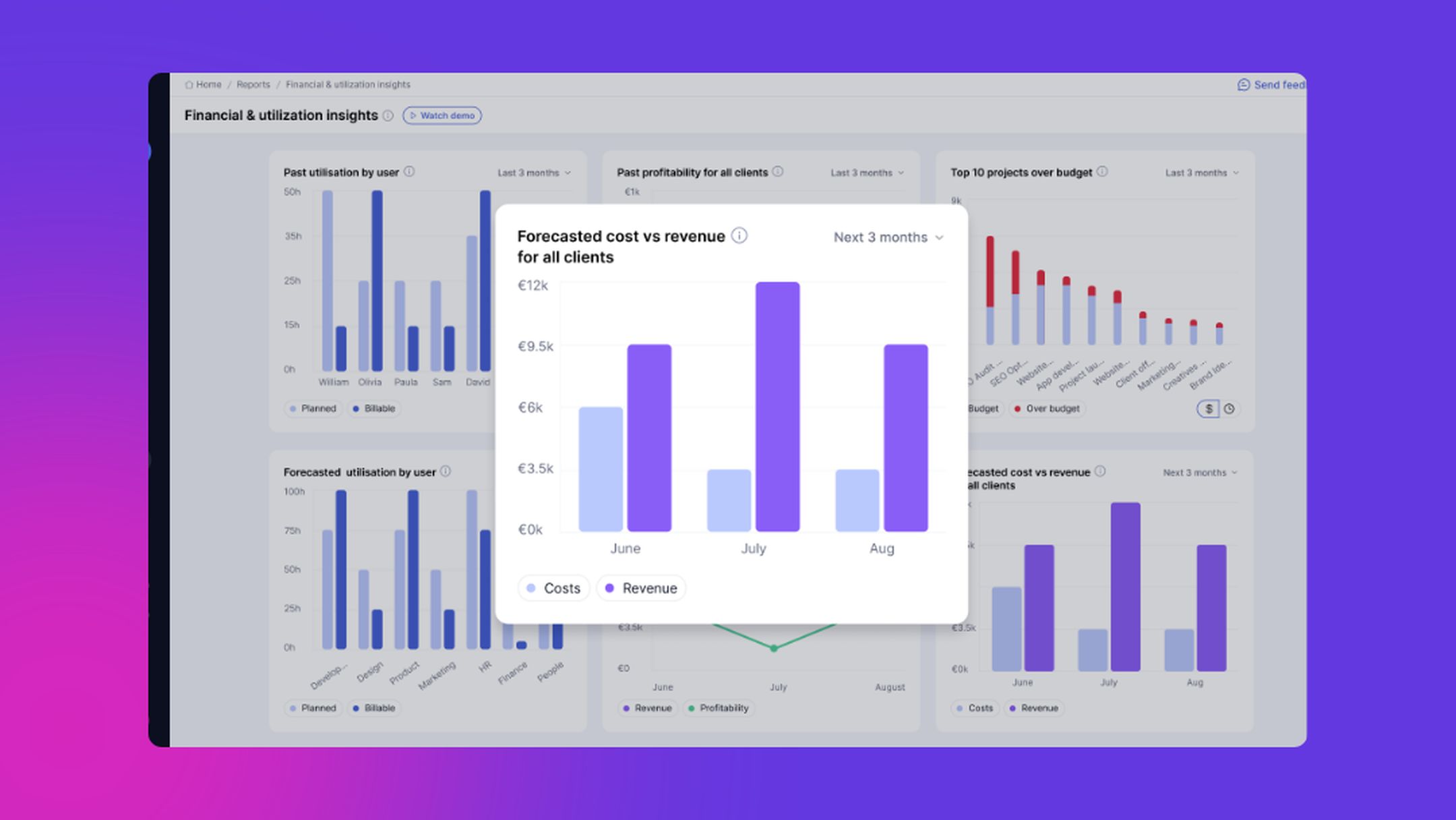

  • Get an instant snapshot of who's overbooked or underutilized. The AI Utilization Summary analyzes your team's current allocations and flags imbalances automatically. Instead of manually scanning a spreadsheet for red flags, you get a plain-language summary of where to focus your attention.

Blog post image

  • Capture accurate time data without the friction. Accurate utilization tracking starts with accurate time entry. The stop-start timer and timesheet view in Teamwork.com let people log time as they work, reducing the recall gap that makes end-of-week batch entry so unreliable.

Blog post image

See your team's real utilization in minutes, not spreadsheets.
Start free

FAQ

What is a good utilization rate for professional services?

A healthy billable utilization rate for professional services firms is typically 65–75% across the organization. This blended target accounts for all roles, including non-billable support staff. Individual producers like designers and developers should aim for 70–80%, while managers and coordinators typically target 30–45%. Pushing the organizational average above 80% almost always leads to quality and retention problems.

How do you track utilization across multiple projects?

You need a time tracking system that lets people log hours against specific projects, not just general categories. The most reliable approach is a platform that connects time entries to project records automatically, so utilization data rolls up by person, project, and portfolio. Standalone spreadsheets break down fast when team members split time across three or more projects in a single week.

How does utilization differ for salaried versus hourly employees?

The formula is the same, but the "available hours" denominator changes. For salaried employees, available hours are typically their contracted weekly hours (minus holidays, PTO, and sick days). For hourly employees, available hours are their scheduled hours for the period. The key difference is that salaried employees have a fixed capacity ceiling, making utilization tracking more straightforward for capacity planning purposes.

What are red flags to watch for in utilization data?

Watch for sustained utilization above 85% for any individual (burnout risk), large gaps between resource and billable utilization (too much non-billable overhead), sudden drops in utilization without a corresponding drop in workload (possible time tracking abandonment), and wide variance across team members in the same role (workload imbalance). Any of these patterns warrants a deeper investigation into either the work allocation or the tracking process itself.

How do you prevent utilization tracking from feeling like micromanagement?

Be transparent about why you're tracking and what you'll do with the data. Share team-level utilization results openly. Use the data for planning and support decisions, not performance reviews. Let people see their own numbers and understand how their targets were set. Teams that understand utilization tracking as a capacity planning tool rather than a surveillance system are far more likely to engage honestly.

What is the difference between resource utilization and billable utilization?

Resource utilization measures the percentage of available hours spent on any work activity, including internal meetings, admin, and training. Billable utilization measures only the hours spent on client-facing, revenue-generating work. Both metrics matter: resource utilization shows overall capacity allocation, while billable utilization directly correlates with revenue. Most professional services firms track both to get a complete picture.
