Leading vs lagging indicators for professional services: a pairing map finance can act on

Blog post image

Leading vs lagging indicators for professional services: summary & key takeaways

  • The difference: Lagging indicators report margin, revenue, and cash after delivery decides them; leading indicators track the delivery signals that move weeks earlier.

  • The tense rule: One metric can do both jobs, so booked utilization leads and last month's actual utilization lags.

  • The pairing map: Each of five finance outcomes gets one leading signal, a warning time, and amber and red thresholds to calibrate.

  • Act on amber: A burn ratio between 1.10 and 1.25 calls for a scope and staffing check that week.

Leading vs lagging indicators for professional services comes down to timing. Lagging indicators like margin and realization report what delivery already decided; leading indicators are the delivery signals that move weeks earlier.

Before I joined Teamwork.com, resourcing forecasts were consistently the hardest numbers I owned as an agency Account Director, and hard-to-build forward numbers are the ones worth checking weekly. This guide pairs five finance outcomes with the signals that predict them, then works one fixed-fee example and a 30-minute weekly review.

Leading indicators predict, lagging indicators report: in professional services, tense decides which is which

Leading vs lagging indicators for professional services differ by tense: leading indicators describe delivery still ahead, and lagging indicators describe delivery already done. Margin, write-offs, and cash are all past tense, so the hours behind them are logged before the number reaches you.

The idea isn't new to finance. In a 1992 Harvard Business Review article on the balanced scorecard, reprinted in 2005, Robert Kaplan and David Norton separated outcome measures from performance drivers. Financial measures "tell the results of actions already taken," while operational measures "are the drivers of future financial performance."

Services firms add a twist: one metric can sit on either side, depending on whether it describes work that's booked or banked. Realization, a banked number, is the share of the value of hours worked that you actually invoice.

The metric

Leading version (future tense)
Lagging version (past tense)
Utilization
Hours booked to billable projects over the next four weeks
Billable hours logged last month
Revenue
Signed backlog not yet delivered
Revenue recognized last quarter
Scope changes
Open change requests not yet priced
Hours written off at invoice

So ask one question of every line in your monthly finance report: is this booked or banked? Booked numbers lead and still respond to a decision. Our guide to project management KPIs defines the underlying measures.

See booked and banked numbers in one place

Start your free trial

The professional services indicator pairing map

Once you can tell which numbers are future tense, pair each lagging outcome you report with the future-tense signal that predicts it. Five pairs cover the leading vs lagging indicators for professional services that finance signs off most often. Treat every threshold as an illustrative starting point to calibrate against your own history.

Professional services indicator pairing map

Lagging outcome you report

Leading indicator to watch
Typical warning time
Amber threshold (illustrative)
Red threshold (illustrative)
First action
Realized revenue next quarter
Forward revenue coverage
60 to 90 days
Below 1.0x
Below 0.85x
Review deal probabilities with sales
Actual billable utilization
Forward-booked utilization per person, next four weeks
2 to 6 weeks
Below 70% or above 90%
Below 60% or above 100%
Move open hours onto backlog work
Project margin
Budget burn ratio
4 to 8 weeks
1.10 to 1.25
Above 1.25
Check scope and staffing with the delivery lead
Realization and write-offs
Unpriced change request hours as a share of budgeted hours
2 to 6 weeks
Above 5%
Above 10%
Price the change order before the next invoice
Cash collected (DSO)
Timesheet lag in days between work and approved time
1 to 4 weeks
Above 3 days
Above 7 days
Chase missing time before the invoice run

Forward revenue coverage predicts next quarter's revenue

Forward revenue coverage is the share of next quarter's revenue target already covered by signed work and probability-weighted pipeline. Signed backlog is revenue that leads, because it's contracted and will land unless delivery slips.

Forward revenue coverage=Signed backlog+Probability-weighted pipelineRevenue target for the next 90 days\text{Forward revenue coverage} = \frac{\text{Signed backlog} + \text{Probability-weighted pipeline}}{\text{Revenue target for the next 90 days}}

Weighted pipeline is only as honest as its stage probabilities, which our guide to sales pipeline management covers. Whether you can staff what you sell is the next question, and our guide to forecasting delivery capacity from your sales pipeline answers it.

Forward-booked utilization predicts the utilization you'll report

Forward-booked utilization is the share of each person's available hours over the next four weeks already scheduled to billable projects. Last month's actual utilization is the lagging version, and its empty hours can no longer be sold.

SPI Research's 2026 Impact of AI on Professional Services report, which Teamwork.com sponsored, shows what rides on the gap. Firms at or above SPI's 75% utilization target average EBITDA of 18.7% vs. 14.4% for firms below it. The report also finds that utilization works through revenue rather than driving EBITDA directly. That makes booked utilization your earliest read on the revenue that carries that gap.

Averages are where this metric misleads. On my agency teams, a healthy average hid the same few people staying late while others left on time, and that imbalance drove burnout. So read bookings person by person, and treat 90% as seriously as 70%. Our guide to workforce capacity planning covers the demand side of that plan.

Budget burn ratio predicts project margin

Budget burn ratio is the share of budget used divided by the share of work complete. Above 1.0, cost is running ahead of delivery. Our guide to project profitability metrics covers the margin formulas, and the next section works the ratio through with numbers.

Unpriced change requests predict realization and write-offs

Most write-offs start as a yes on a status call. A client asks for an extra round, the team agrees, and the hours land with no change order. Finance meets them weeks later as hours nobody can invoice.

Track accepted but unpriced hours against budgeted hours, and make pricing part of saying yes. Our guide to project revenue planning shows how to build that step into the plan.

Timesheet lag predicts cash

Cash is the most lagging number finance owns, and timesheet lag is its earliest warning. Every day between doing the work and approving the time delays the invoice by a day. Track median lag per team, because one late approver holds back a whole project's billing.

Worked example: a fixed-fee project that flags red six weeks before it closes

Of the five pairs, budget burn catches margin loss on a single project soonest. Take an illustrative $80,000 fixed fee, a 10-week project, and 500 budgeted hours at a $104 blended cost rate. That's $52,000 of planned cost and a 35% target margin.

At the end of week 4, the team has logged 300 hours, or 60% of the budget, but the work is only 40% complete:

Burn ratio=Share of budget usedShare of work complete=0.600.40=1.5\text{Burn ratio} = \frac{\text{Share of budget used}}{\text{Share of work complete}} = \frac{0.60}{0.40} = 1.5

That's past the red line of 1.25. At the same rate, the project needs 750 hours, which cost $78,000 at $104 an hour against the $80,000 fee:

Hours at completion=3000.40=750\text{Hours at completion} = \frac{300}{0.40} = 750

750×104=78,000750 \times 104 = 78{,}000

Projected margin=80,000−78,00080,000=0.025\text{Projected margin} = \frac{80{,}000 - 78{,}000}{80{,}000} = 0.025

Projected margin falls to 2.5% against a 35% target, putting $26,000 of planned profit at risk. With six weeks left, there's room to price the extra scope or change the staffing mix. Wait for the close and the same number arrives as a write-off. The decision rules fit on one line each:

  • Below 1.10: Spend is tracking progress, so no action is needed.

  • 1.10 to 1.25 (amber): Check scope and staffing with the delivery lead this week.

  • Above 1.25 (red): Open a change order conversation or re-staff before the next invoice.

The note to the delivery lead can be short. "Burn ratio 1.5 at week 4, projecting 2.5% margin against 35%. Can we agree on a change order or staffing change before we invoice?" Swap in your own hours, budget, percent complete, and cost rate to run it on any project.

Check your utilization baseline

Work out your team's current billable utilization so the utilization row of your pairing map starts from a real number.

Try the utilization rate calculator

Run the pairing map in a 30-minute weekly review

A threshold only helps if someone looks at it while the number can still move, so the map belongs in a weekly meeting. If you already lose the first days of every month reconciling delivery hours against invoices, another meeting sounds like the last thing you need. This one earns its slot by catching surprises in the week they appear. Keep the same five steps in the same order, with one owner each:

  1. Coverage check (5 minutes, finance lead): Compare forward revenue coverage with last week and flag any move into amber.

  2. Booked utilization (5 minutes, resourcing lead): Review person-level bookings for the next four weeks, ignoring the team average.

  3. Burn ratios (10 minutes, delivery leads): Walk only the projects above 1.10 and agree on one action for each.

  4. Unpriced change requests (5 minutes, account owners): Confirm which open requests get a change order before the next invoice.

  5. Timesheet lag and actions (5 minutes, finance lead): Name anyone behind on time, then read back every action with its owner.

Preparation is where reviews like this stall. At my agencies, client reports were built by hand every week, every client wanted a different format, and none of those hours were billable. I recommend a test from that: if pulling the numbers takes longer than the meeting, fix the data before the agenda.

Our guide to team performance metrics sets out the wider weekly, monthly, and quarterly cadence. The Teamwork.com templates library has reporting templates you can adapt for the agenda.

Where leading indicators mislead

The weekly review is only as good as the signals feeding it, and leading indicators break in four predictable ways. Knowing them tells you when to trust the map and when to override it.

Late time data turns every leading indicator into a lagging one. If timesheets arrive a week late, your burn ratio describes last week's project. Fix timesheet lag first, because the other four rows depend on it.

Small firms get noisy ratios. Under about 50 people, one big deal or one week of leave can push a ratio past red. Watch absolute hours instead, such as unbooked hours next month and hours over budget per project.

Thresholds need your own history. Run the starting bands for two or three quarters, check which amber flags actually became a margin miss, and move the lines to match.

People also game the numbers they know you watch. Once booked utilization is on the agenda, someone will book placeholder time to stay out of amber. Ask for the client and project behind any vague booking.

How Teamwork.com connects leading signals to the margin you report

Teamwork.com puts all five leading signals on the same delivery data, so they stop arriving late from separate tools. It's the agentic PSA (professional services automation platform) that connects pipeline, resourcing, time, and budgets as delivery happens. Your CRM keeps the deals, your finance system keeps invoicing and the ledger, and Teamwork.com owns delivery in the middle.

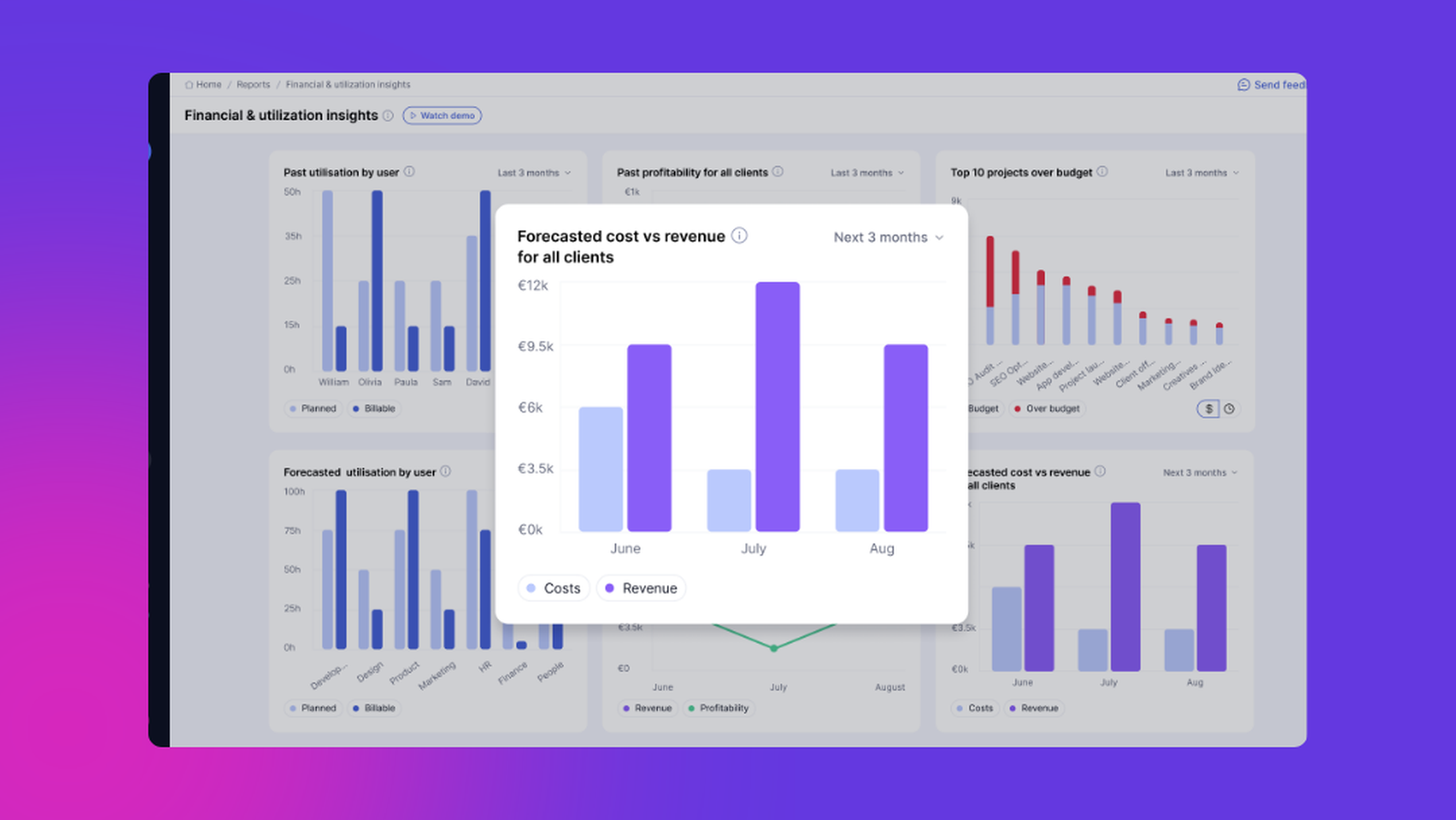

See next quarter's demand before it's signed. Coverage goes blind when probable deals live only in the CRM. Tentative Projects turn those deals into scenario plans with placeholder roles and soft allocations, so you reserve capacity and forecast revenue early. You create and manage them from HubSpot, and their status updates with the deal stage. When a deal closes, you convert it to a confirmed project, so backlog and pipeline share one forward view.

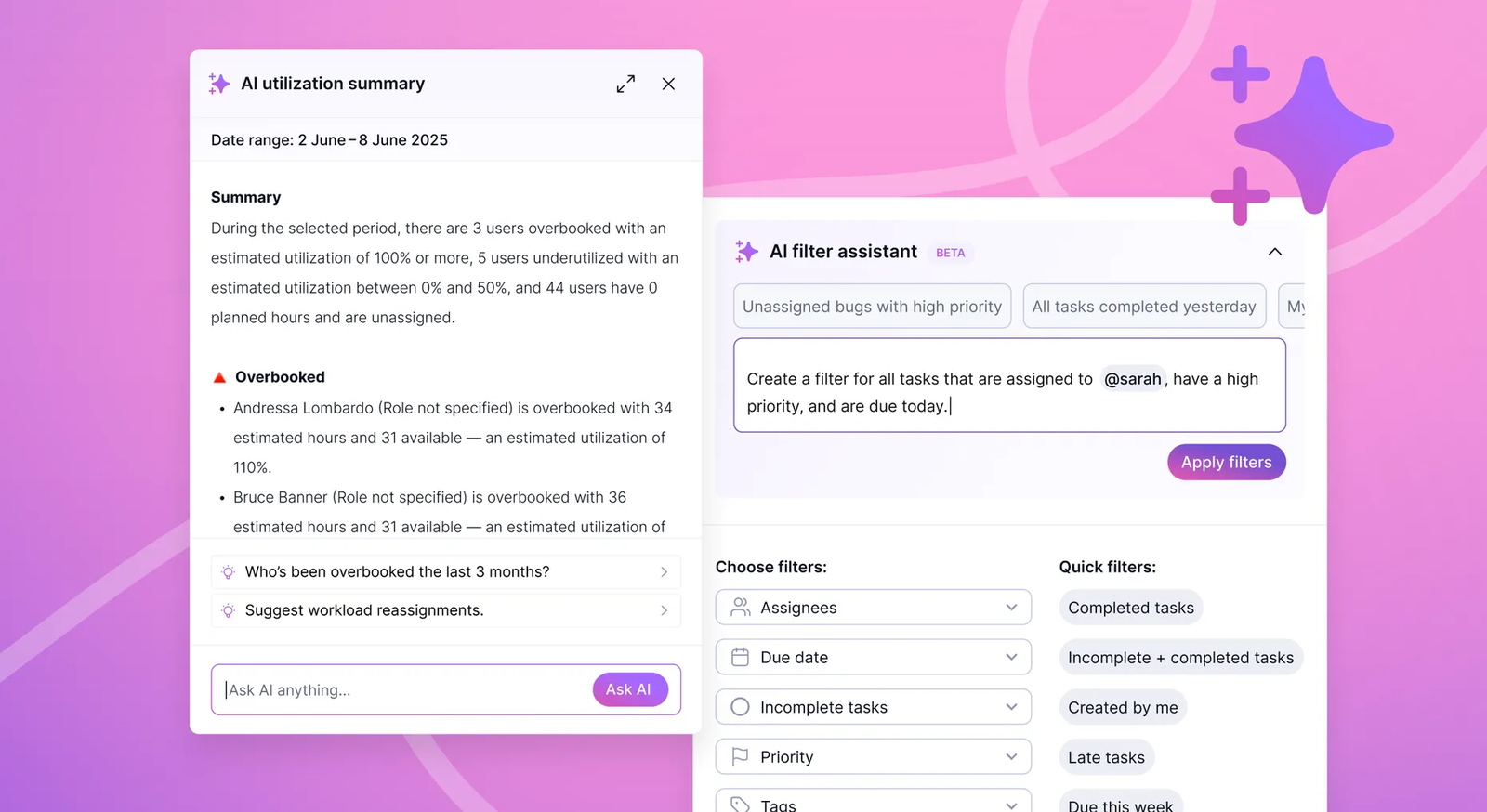

Read utilization person by person, forward and back. A team average hides who's overbooked next month. The Utilization Report shows each person's historical and forecasted utilization against their Utilization Target and billable target. The AI Utilization Summary flags who's over or under capacity, and the resourcing lead decides what to move. Booked and actual utilization sit in one report, which puts the tense rule on a single screen.

Blog post image

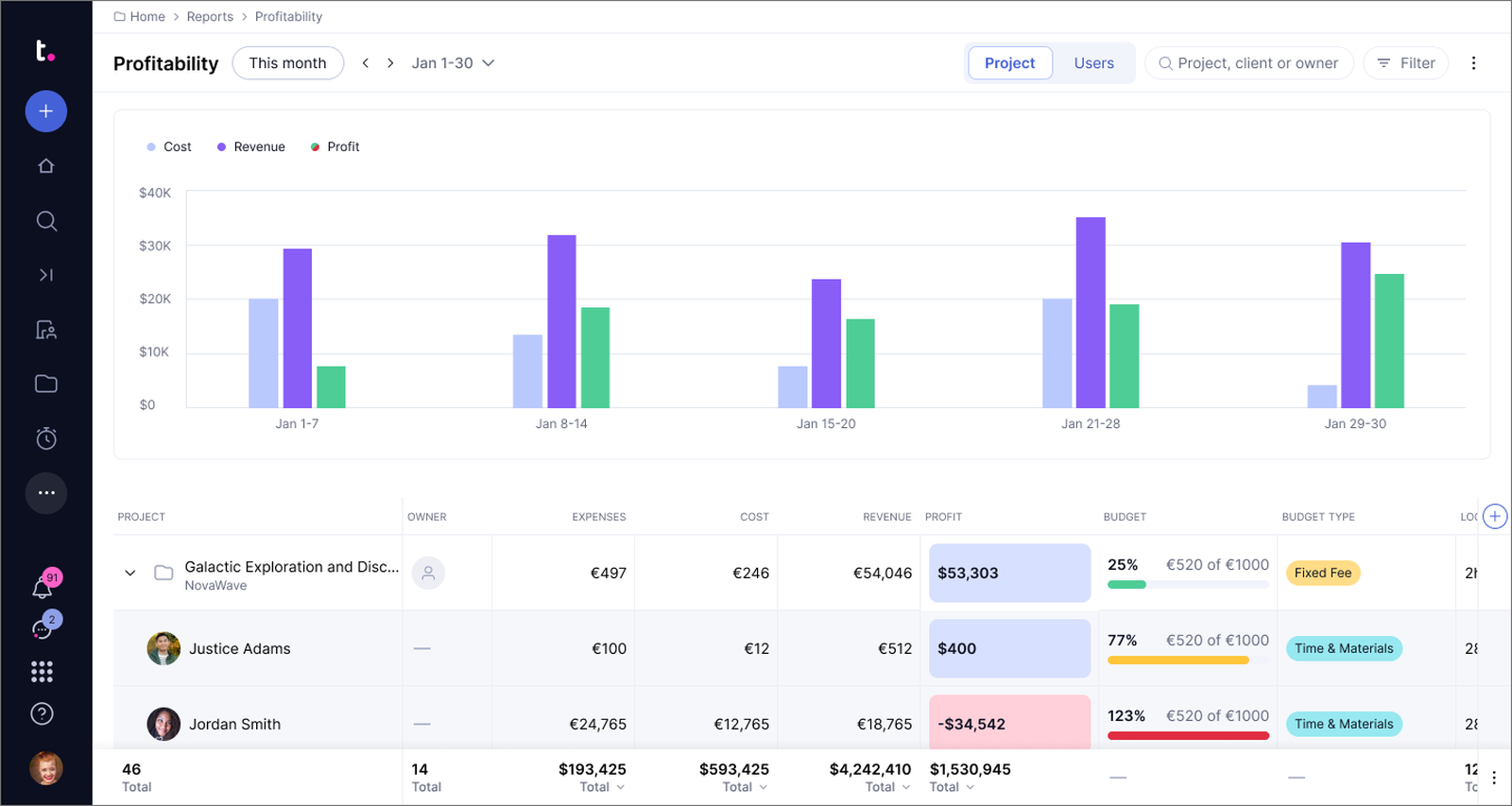

Catch margin slipping while the project is still running. Burn costs margin when nobody sees it before the next invoice. Budgeting & Profitability tracks live cost from time and expenses, at team rates, against fixed-fee, time-and-materials, or retainer budgets and each project's profit margin target. Spend notifications fire at the threshold you choose, and task-level budget splits show which phase is burning; in the worked example, a 50% alert lands by week 4. You now see the margin you'll report next to the burn ratio that predicts it.

Blog post image

OIC Advisors, an IT consulting firm, moved project reporting into Teamwork.com. They gained 360° visibility across all active projects with 100% less time spent manually generating reports. With every row of the pairing map reading from one set of delivery data, the margin you report is a number you saw coming.

Get booked utilization, burn ratios, and margin targets on your own delivery data, ready to fill in your pairing map.
Start your free trial

FAQ

Are KPIs leading or lagging indicators?

A KPI can be either, because the label depends on which outcome you measure it against. Proposals sent is a leading KPI for revenue but a lagging KPI for business development activity.

Is utilization a leading or lagging indicator?

Utilization is both: forward-booked utilization is a leading indicator, and actual utilization is a lagging one. Current-week utilization sits in between as a coincident check that bookings are turning into logged billable hours.

Is backlog a leading indicator of revenue?

Yes, signed backlog is a leading indicator of revenue because it's contracted work not yet delivered or recognized. Divide it by monthly delivery capacity to get backlog in months, which shows how long the team stays busy without a new sale.

How much pipeline coverage does a professional services firm need?

The pipeline coverage a firm needs depends on its win rate, because a lower win rate needs more unweighted pipeline behind each dollar of target. A firm that wins one in three proposals needs about three times the gap between signed backlog and target.

Can Teamwork.com track leading indicators for professional services firms?

Yes, Teamwork.com tracks forward-booked utilization, budget burn, and margin against target from the same delivery data that produces your lagging numbers. Tentative Projects add probable deals to the forward view, while your CRM and finance system stay the systems of record.

Related Articles
